Abanca Balaídos
Updated: 07.03.2025
Target capacity | 28 000 |
---|---|
Capacity before works | 31 800 |
Country | Spain |
City | Vigo |
Clubs | Celta |
Category | Construction in progress |
Cost | €60 M ($65 M) |
Construction | 2015–2027 |
Design | Capitel Consultores |
Design time | 2014 |
Contractor | Copasa |
Advertisement
Abanca Balaídos – construction description
This scheme to redevelop aging Estadio Balaidos was developed by local architect Pedro de la Puente Crespo in 2014. It’s the first concept since Vigo’s failed bid to be a 2018 World Cup city with other Spanish and Portuguese hosts. Worth just a fraction of the FIFA bid’s vision, this one is more economic and focuses on efficient redevelopment of the old stadium.
Nicknamed the “New Wave”, it foresees the stadium becoming football-specific and giving all stands (or at least the roof) a uniform height and aesthetics. Lightweight steel cover will be clad with aluminum in a way to create numerous waves throughout the building’s facades and roof. This cost-effective aesthetic intervention should become the signature feature of New Balaidos, honouring maritime traditions of Vigo.
The phased project was divided into several phases, in order not to interrupt Celta’s use of the stadium. In early 2015 the north stand’s lower tier was demolished and replaced with new sections, much closer to the field. Following the 2015/16 season concrete roof over that same stand was removed and replaced by segments of new one, much higher than its predecessor. Aside from new seating and cover, the north side will also get a strip of private boxes and additional facilities under the lower tier.
Following the completion of the reconstruction of the north stand, between 2017 and 2018 the grandstand on the south side was modernised. This included the renovation of the auditorium and backstage area (keeping the entire reinforced concrete structure), the construction of a new canopy and the installation of a façade.
In 2021 another stage of the stadium's reconstruction began, this time involving the demolition of the existing stand behind the eastern goal and the construction in its place of a new one, located much closer to the pitch. The opening of the new stand took place on June 4, 2023 on the occasion of a league match against FC Barcelona.
The last to be rebuilt will be the stand behind the west goal. Work began in early 2025, and the new stand should be ready in about two years. The cost of the entire stadium reconstruction will total more than €60 million.
Advertisement
Pictures
-

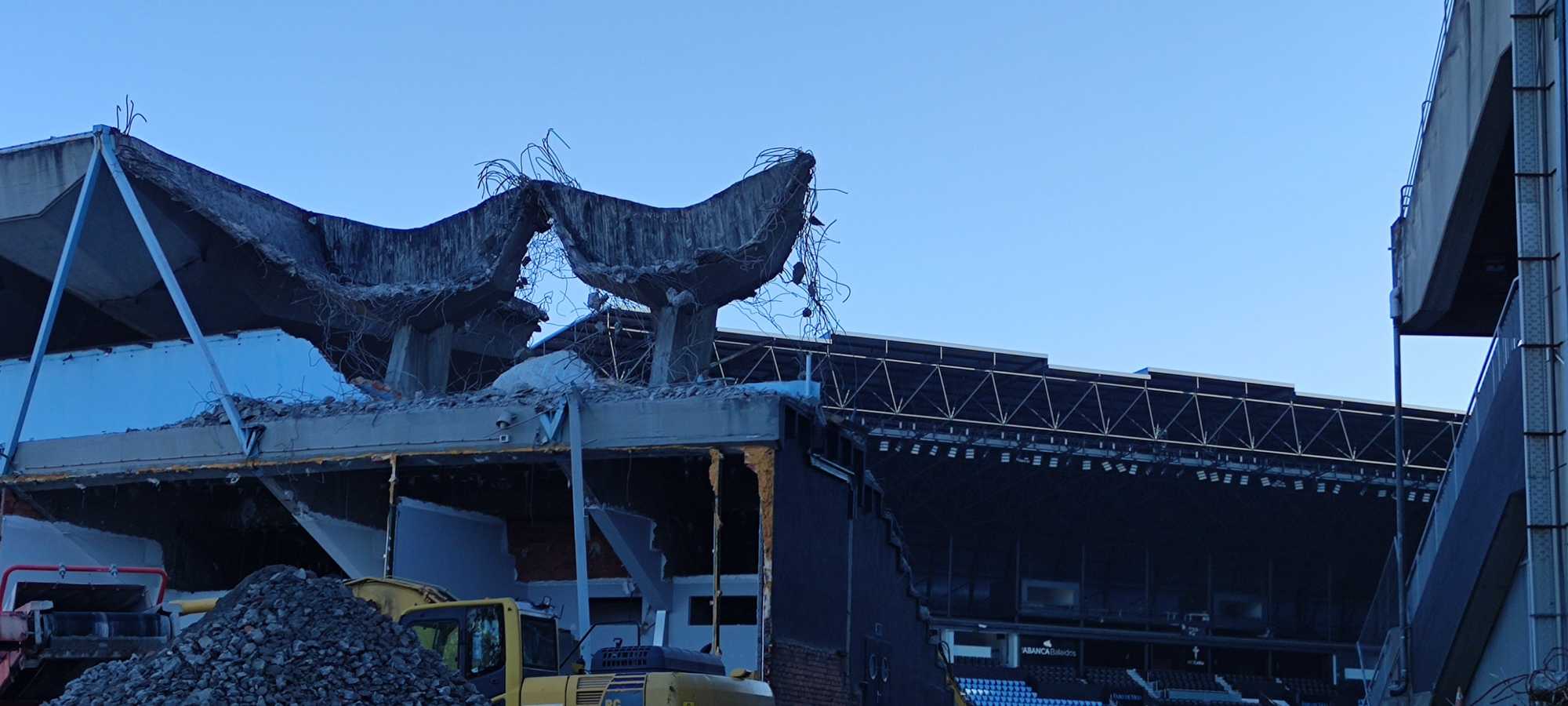

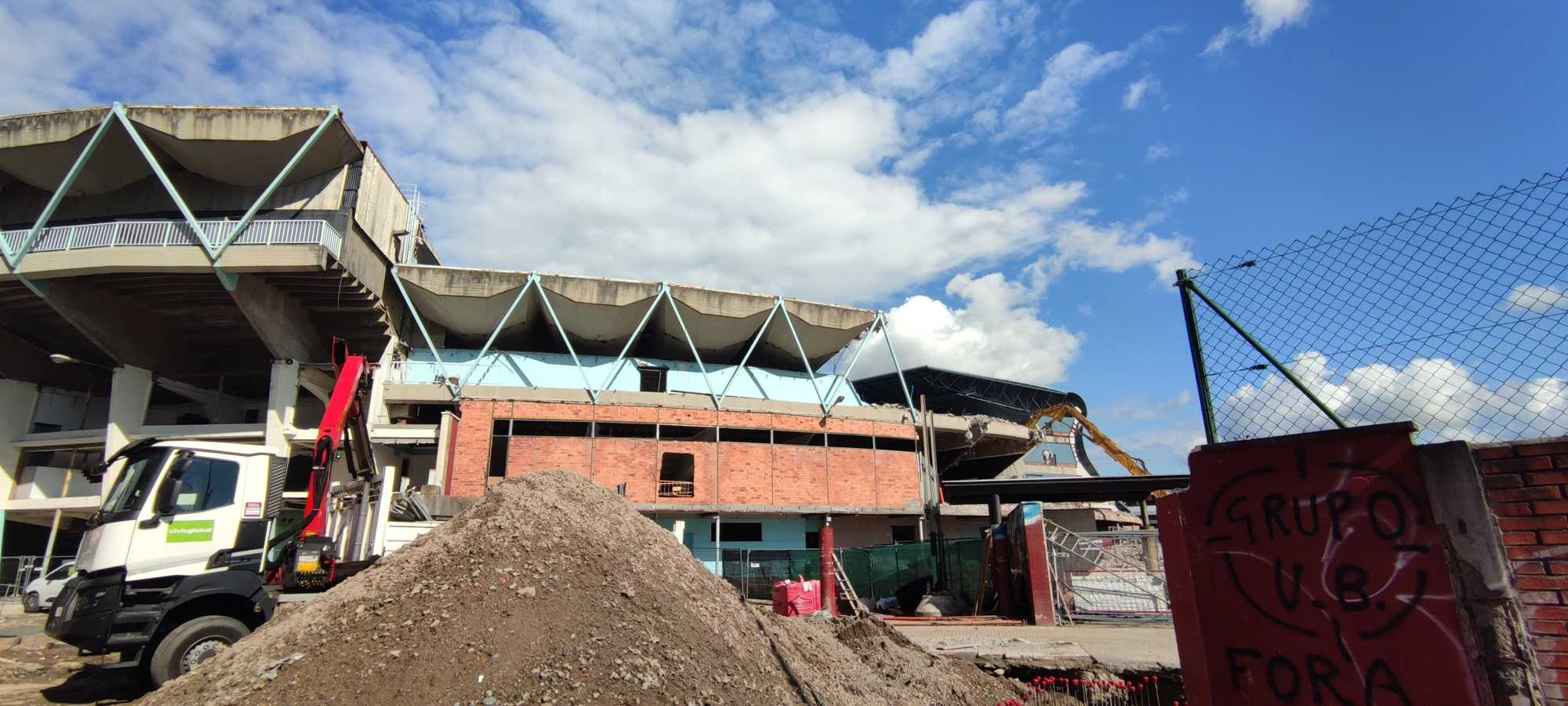

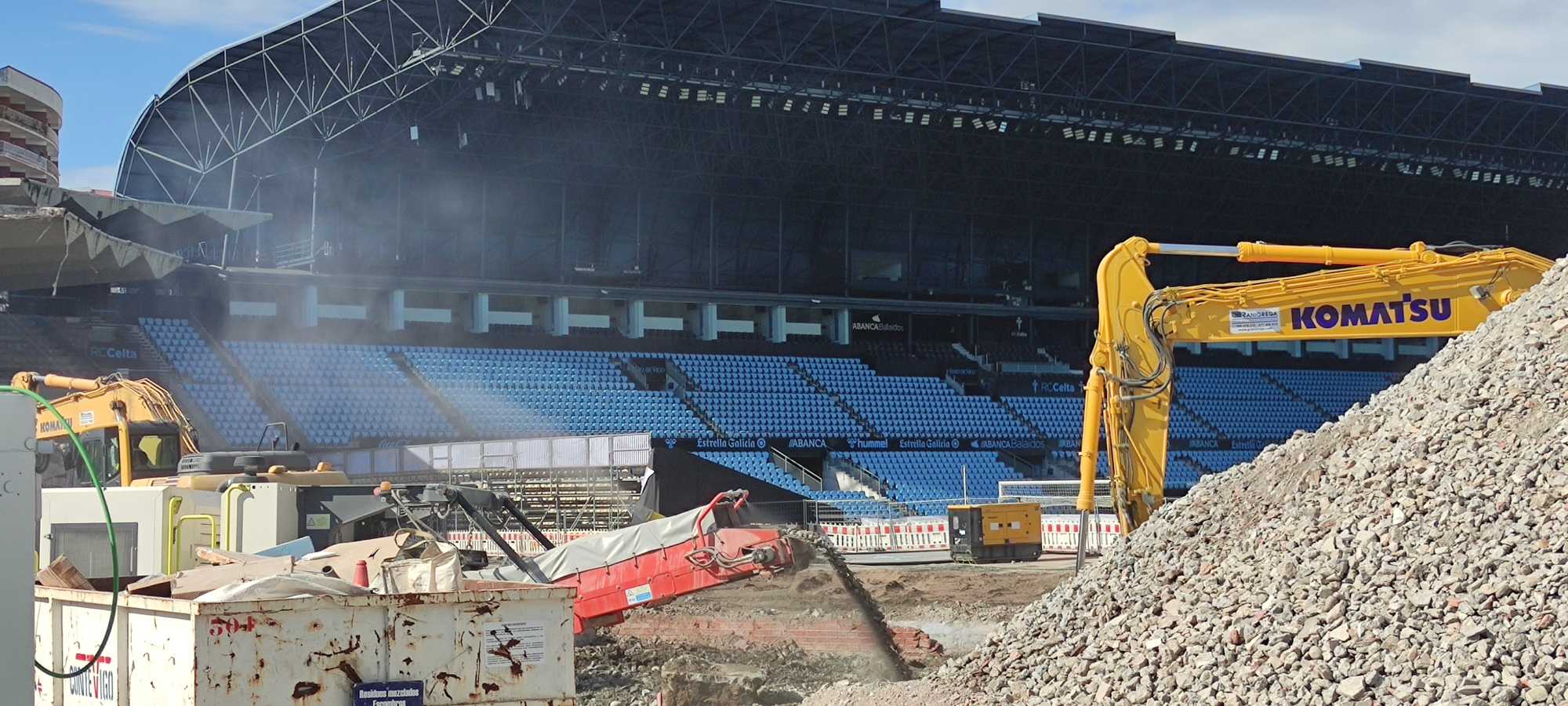

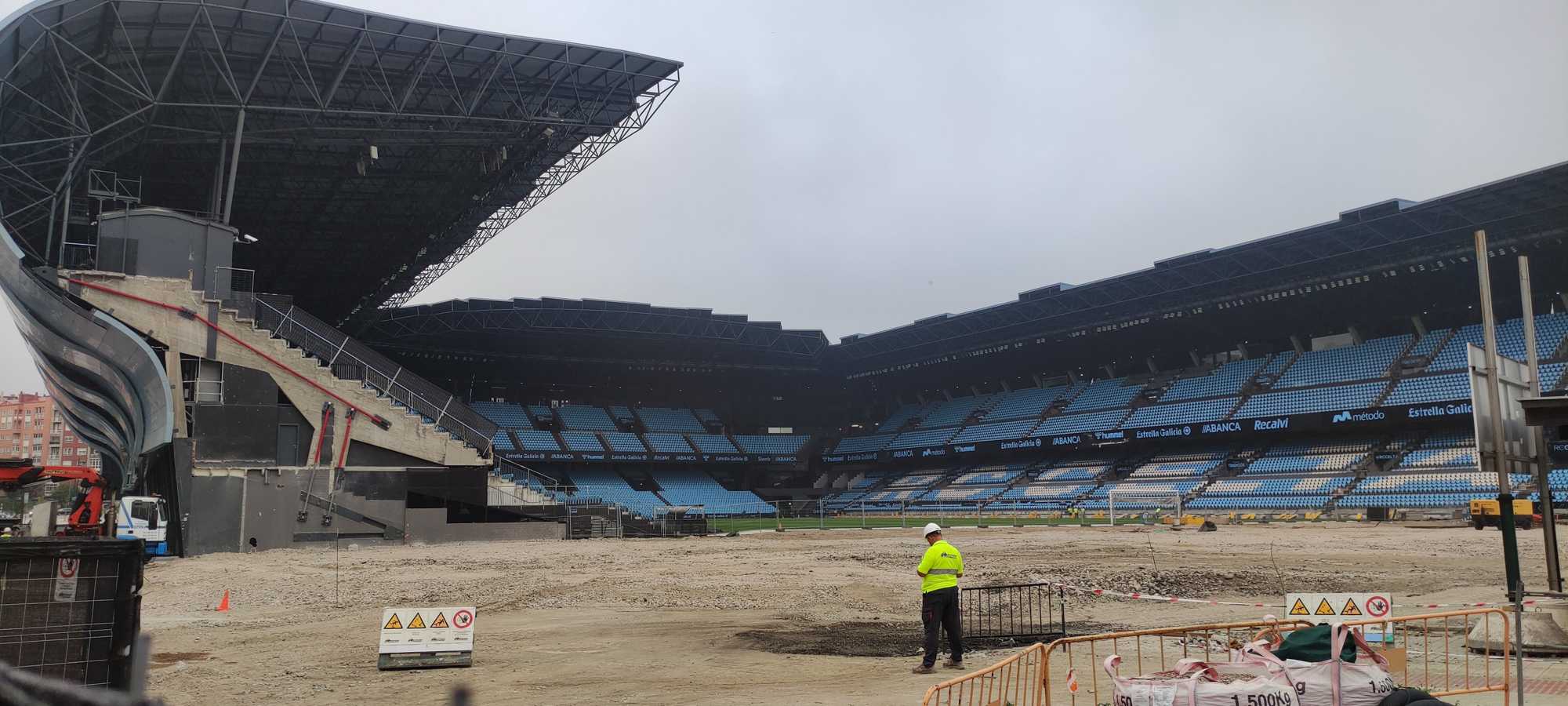

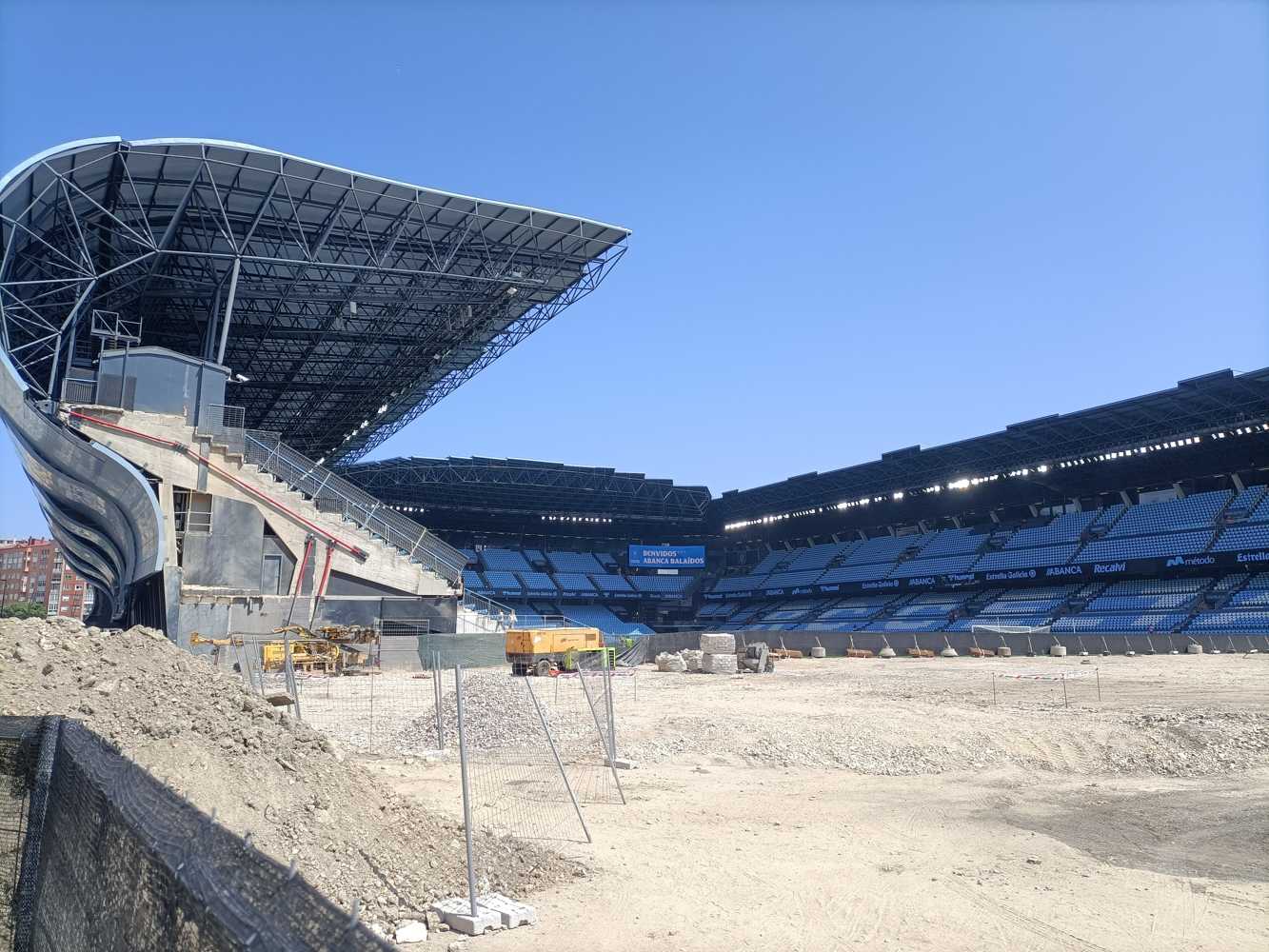

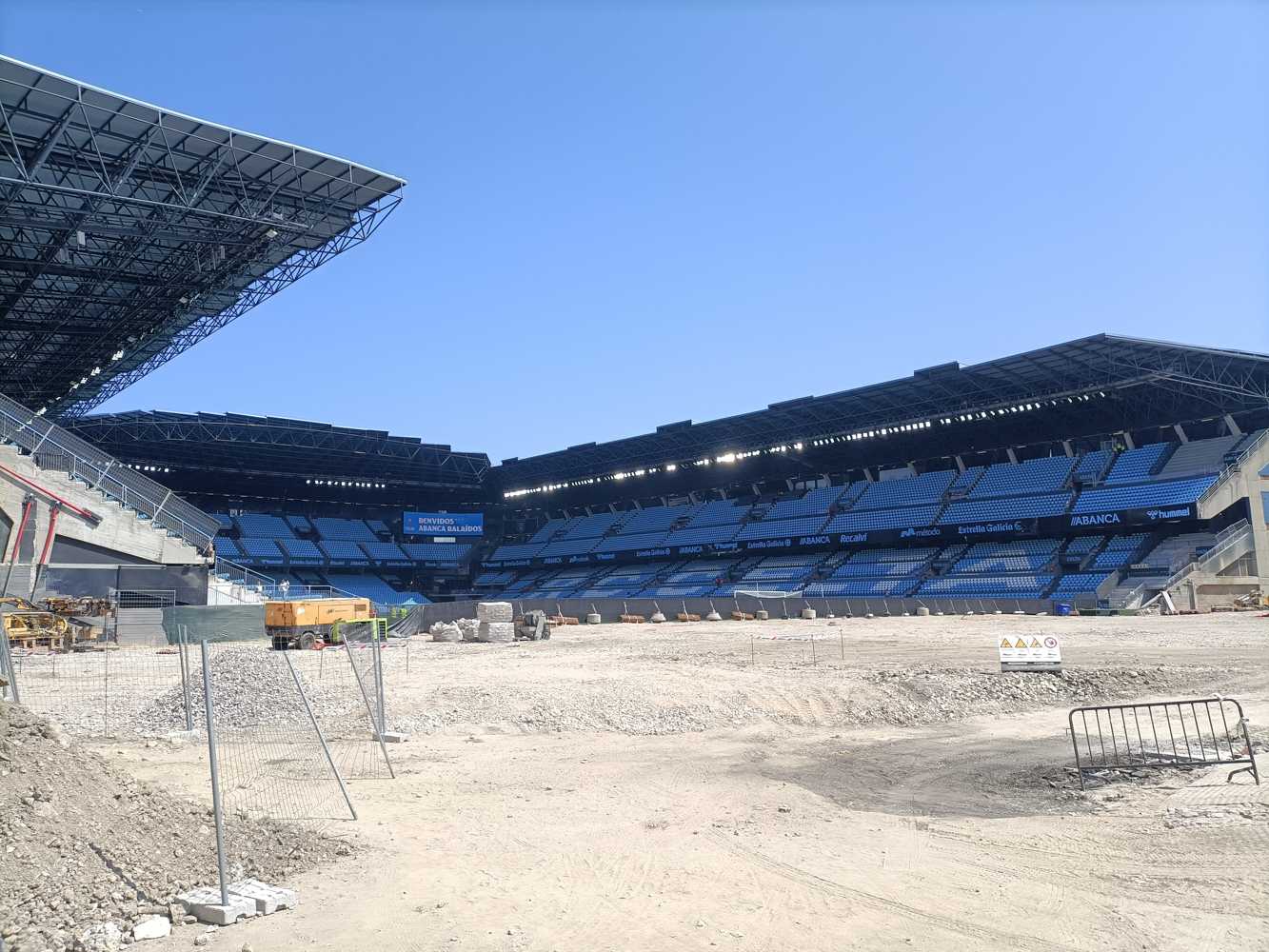

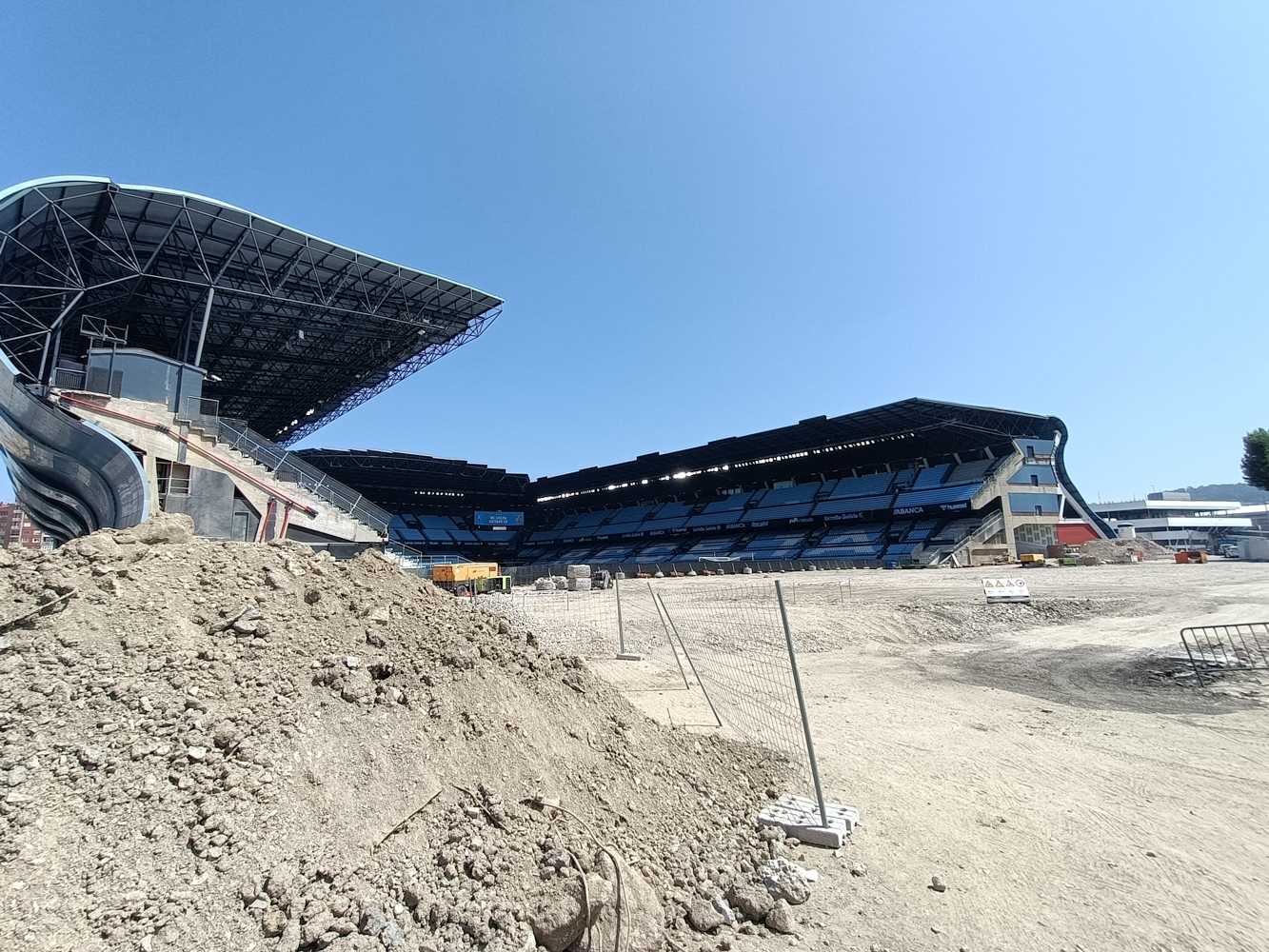

07.03.2025

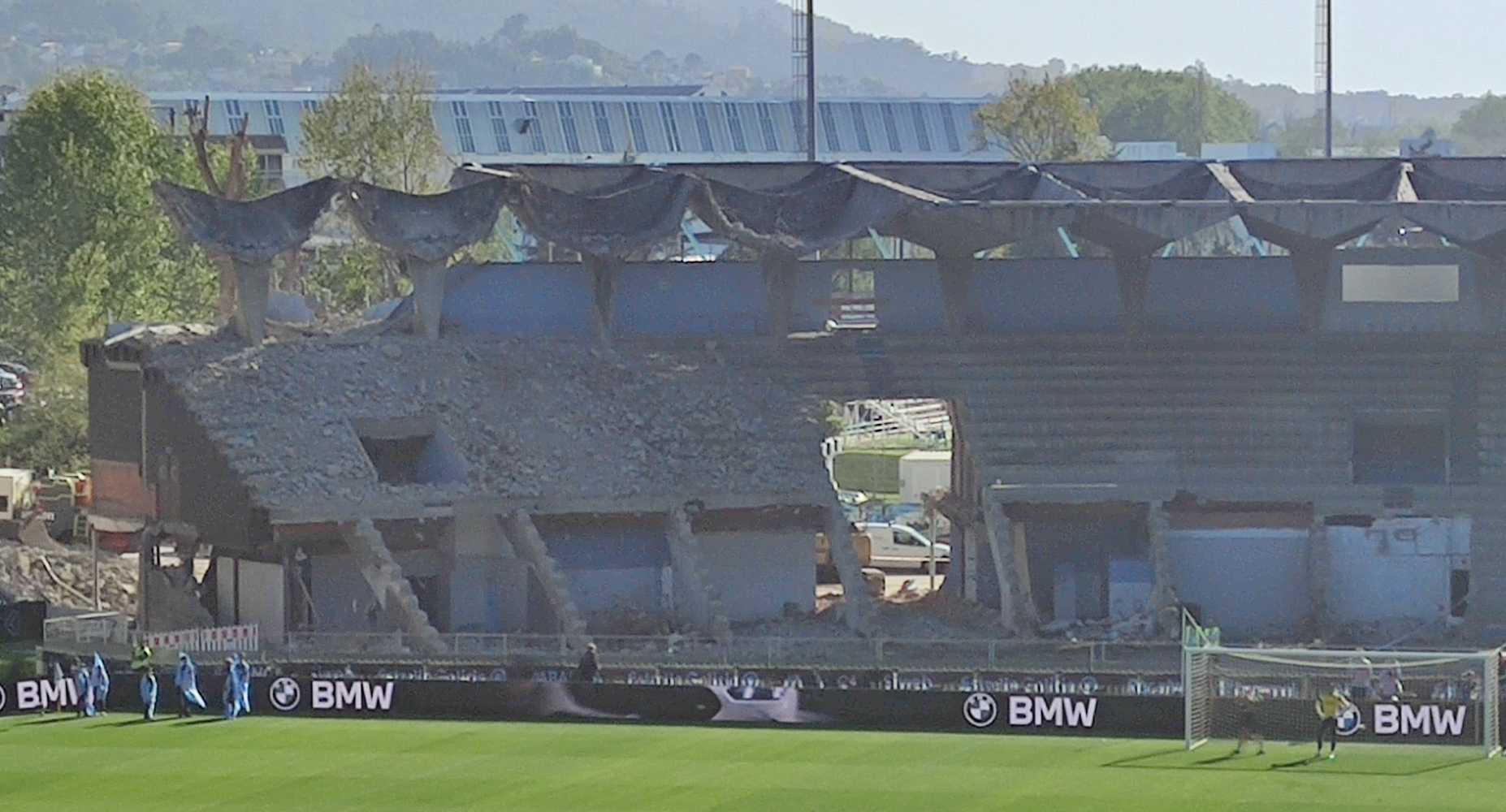

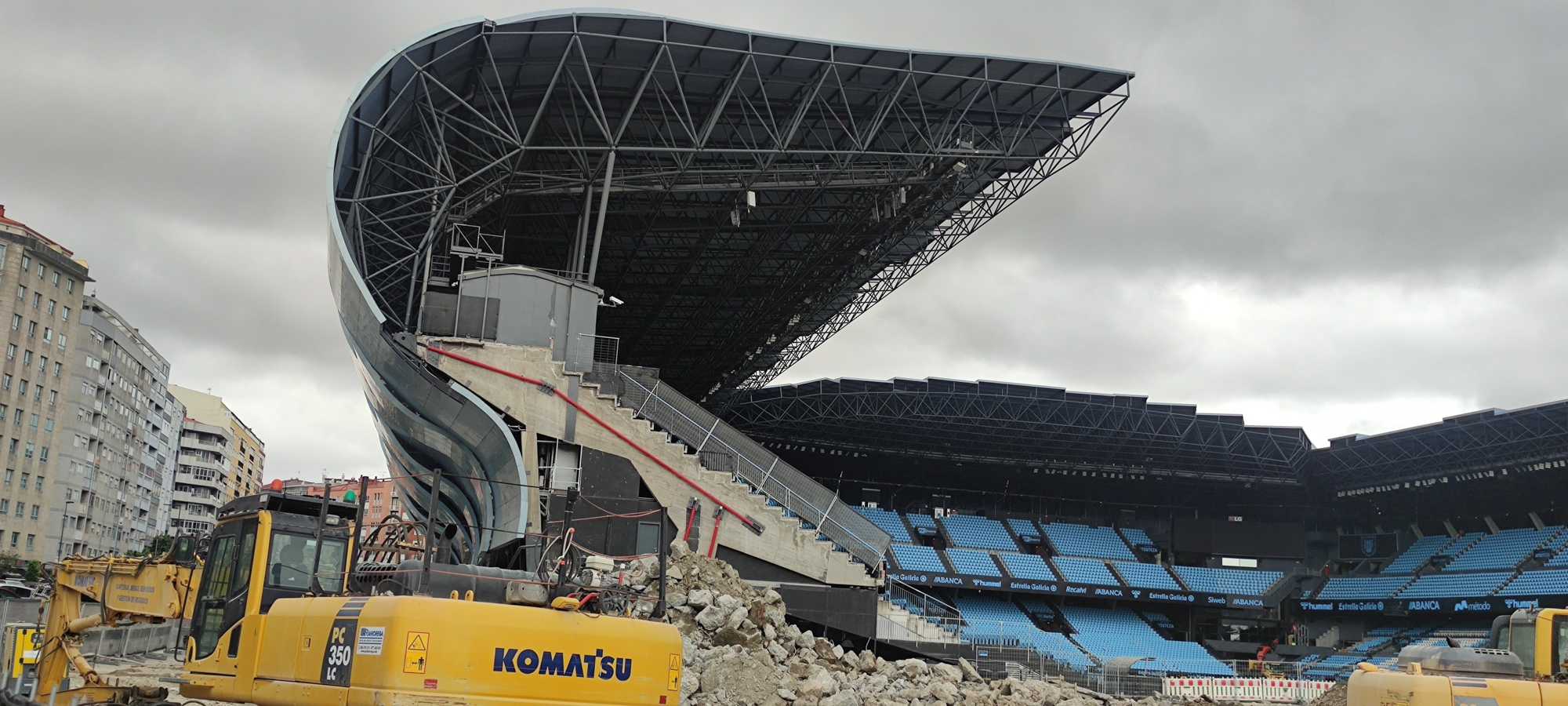

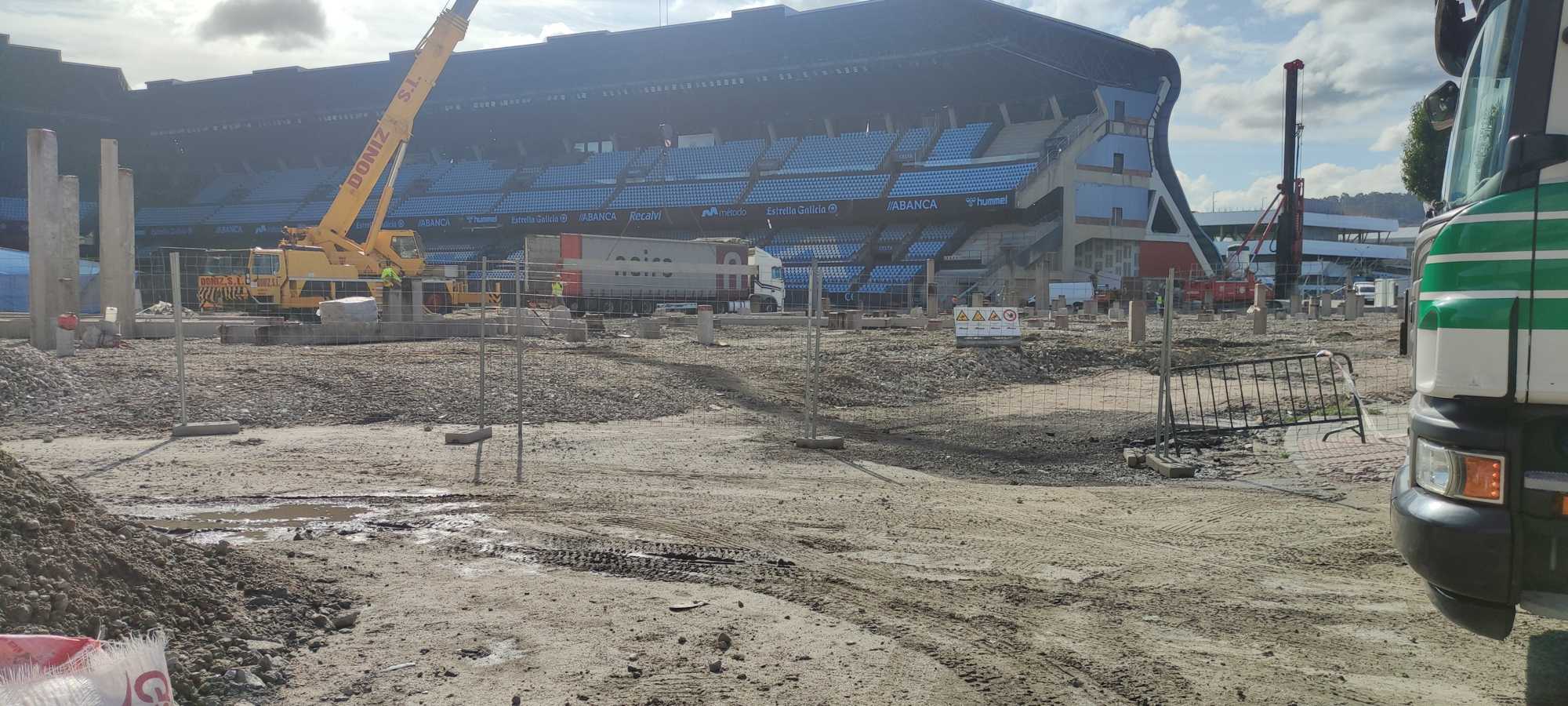

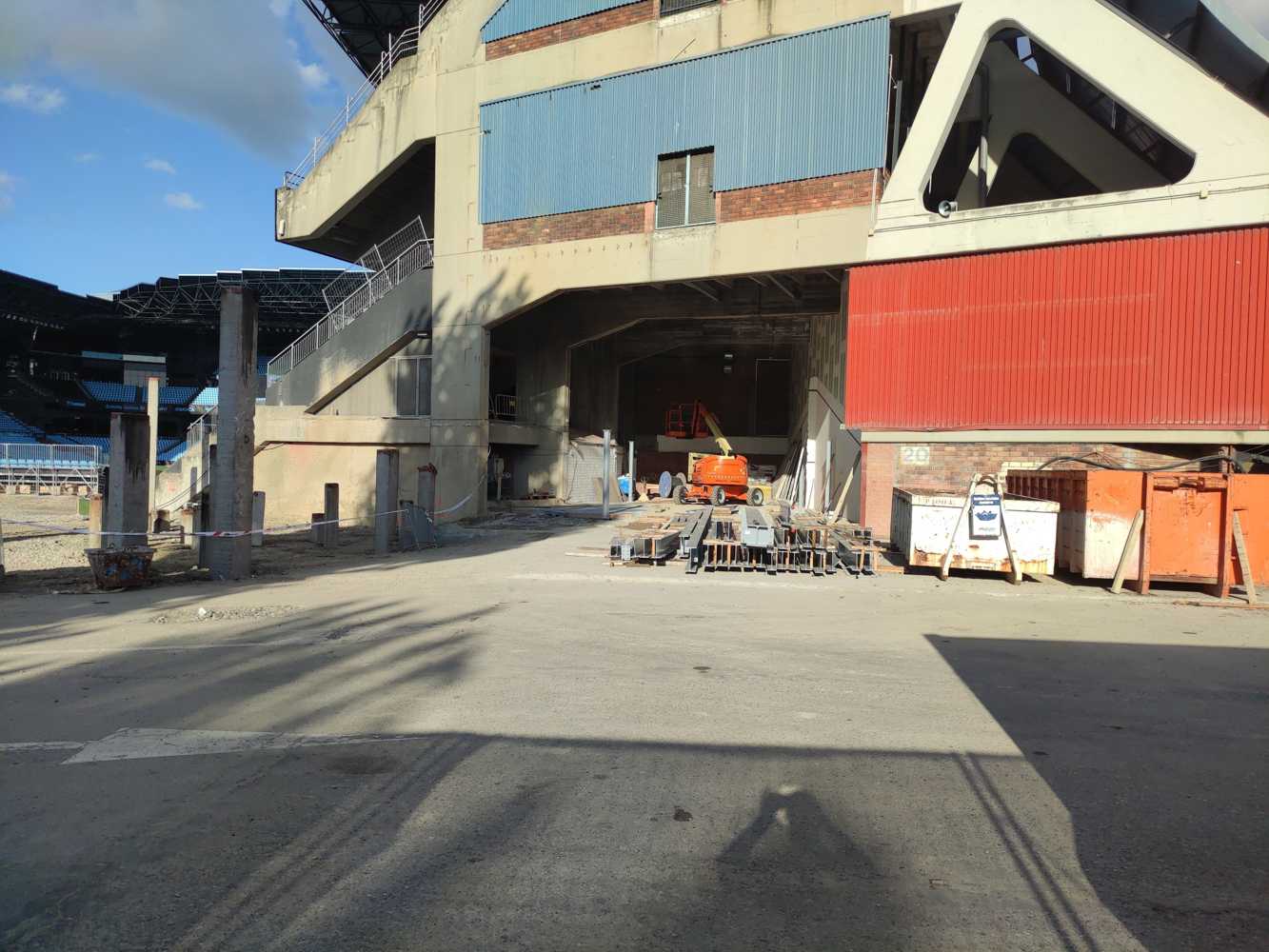

07.03.2025 © Pablo Hernández Gamarra, Faro de Vigo 07.03.2025 © Pablo Hernández Gamarra, Faro de Vigo

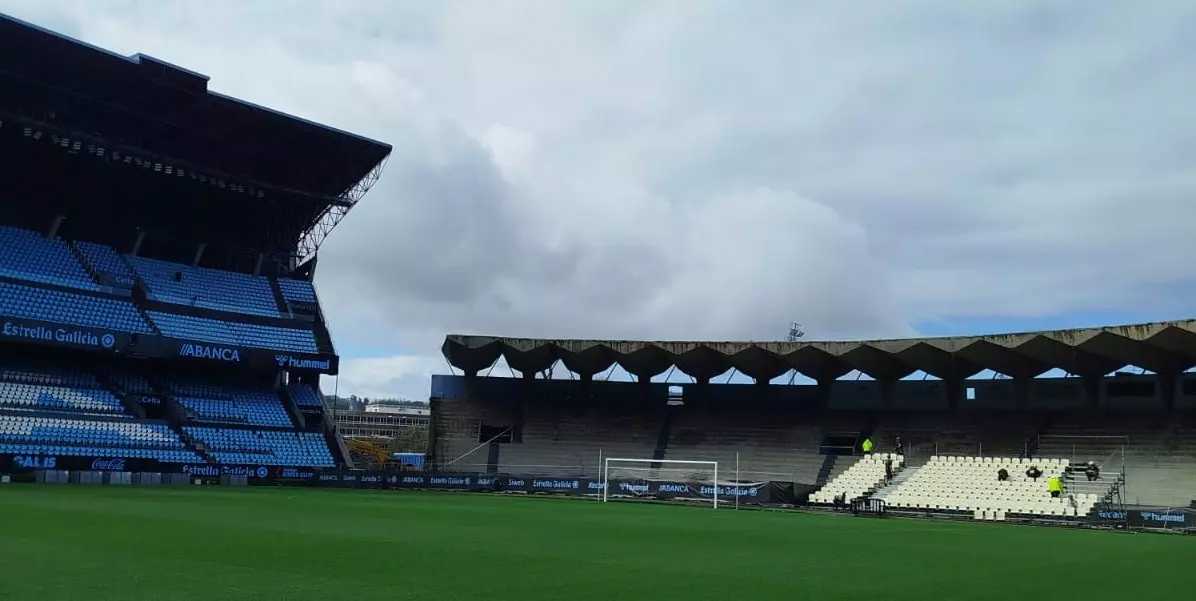

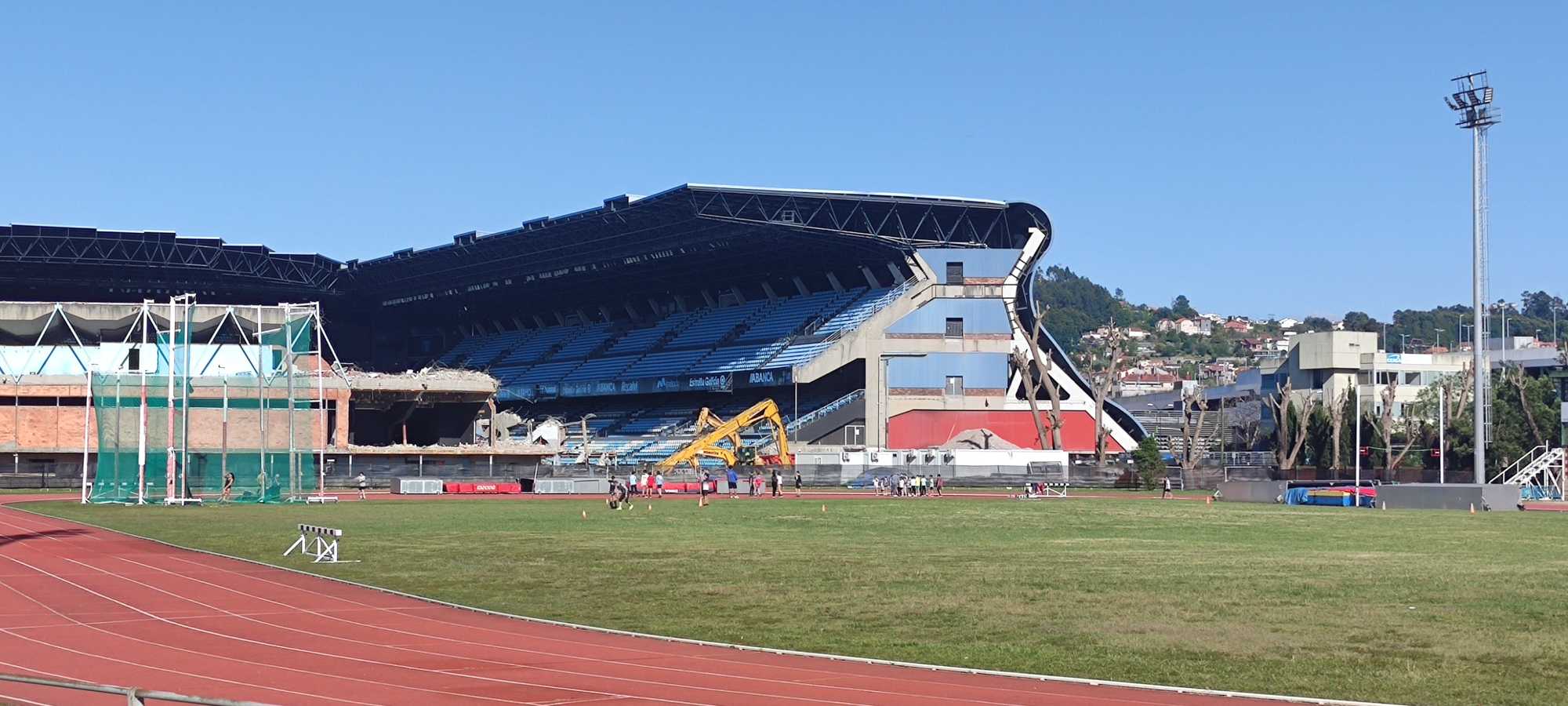

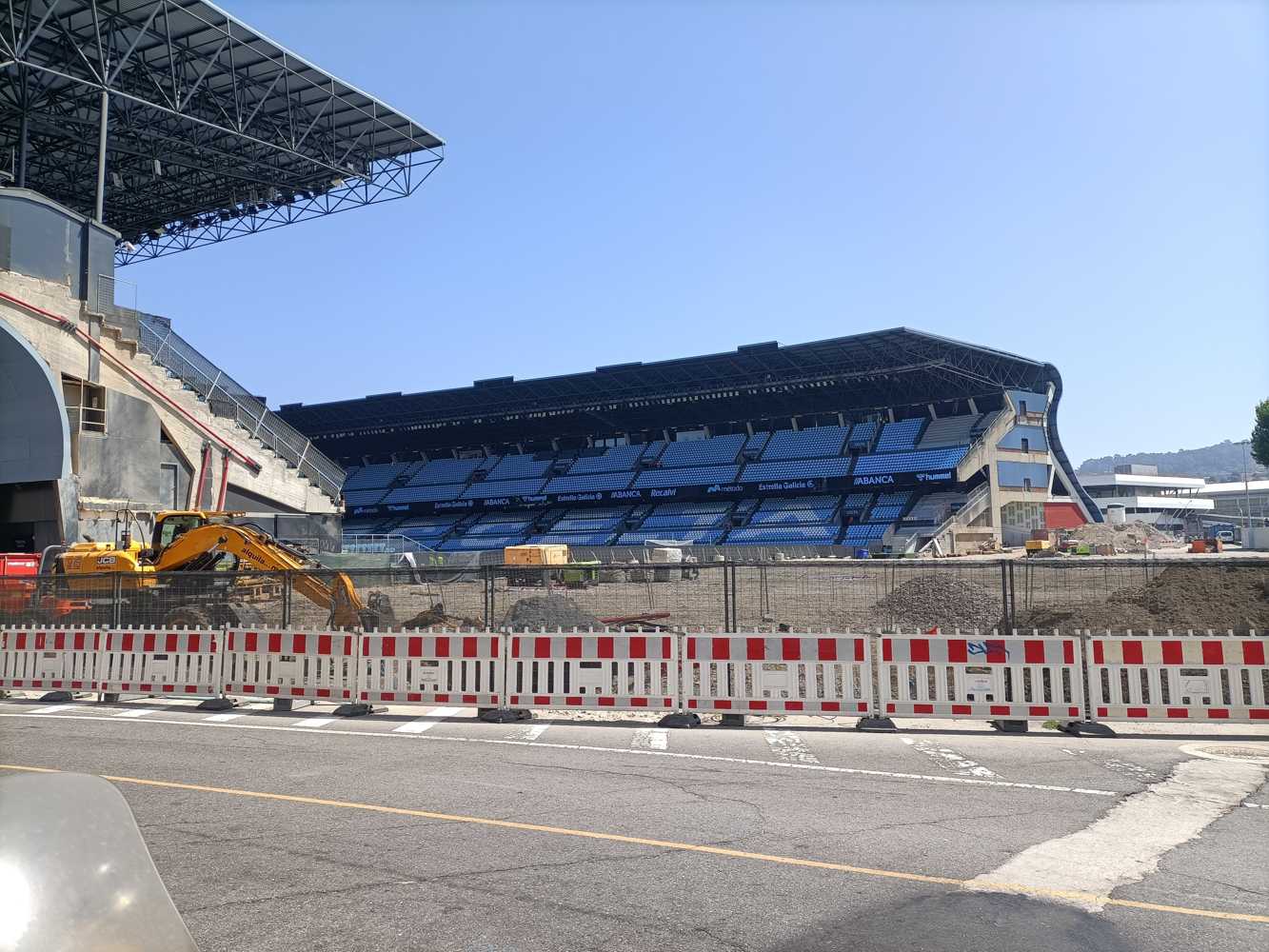

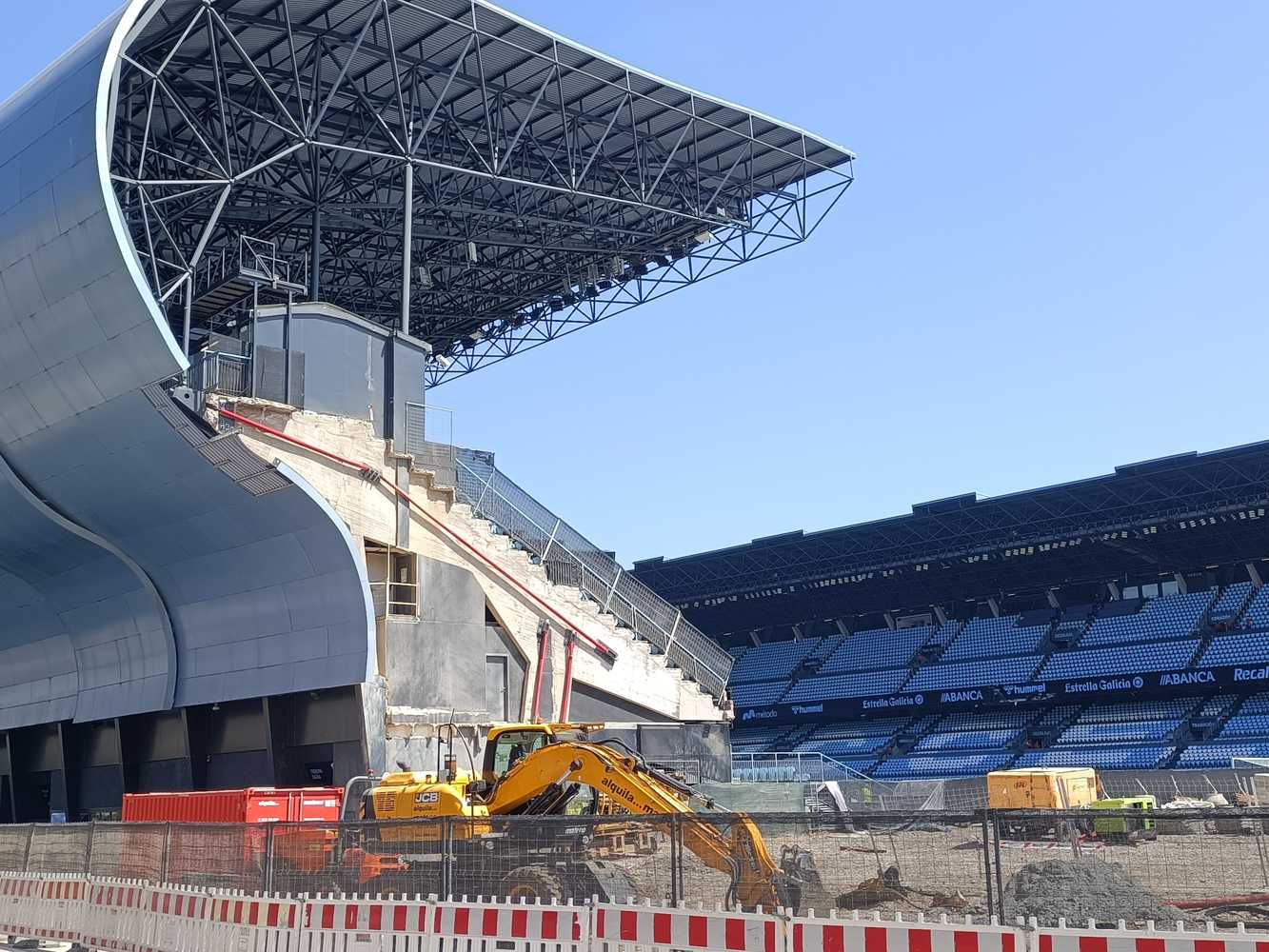

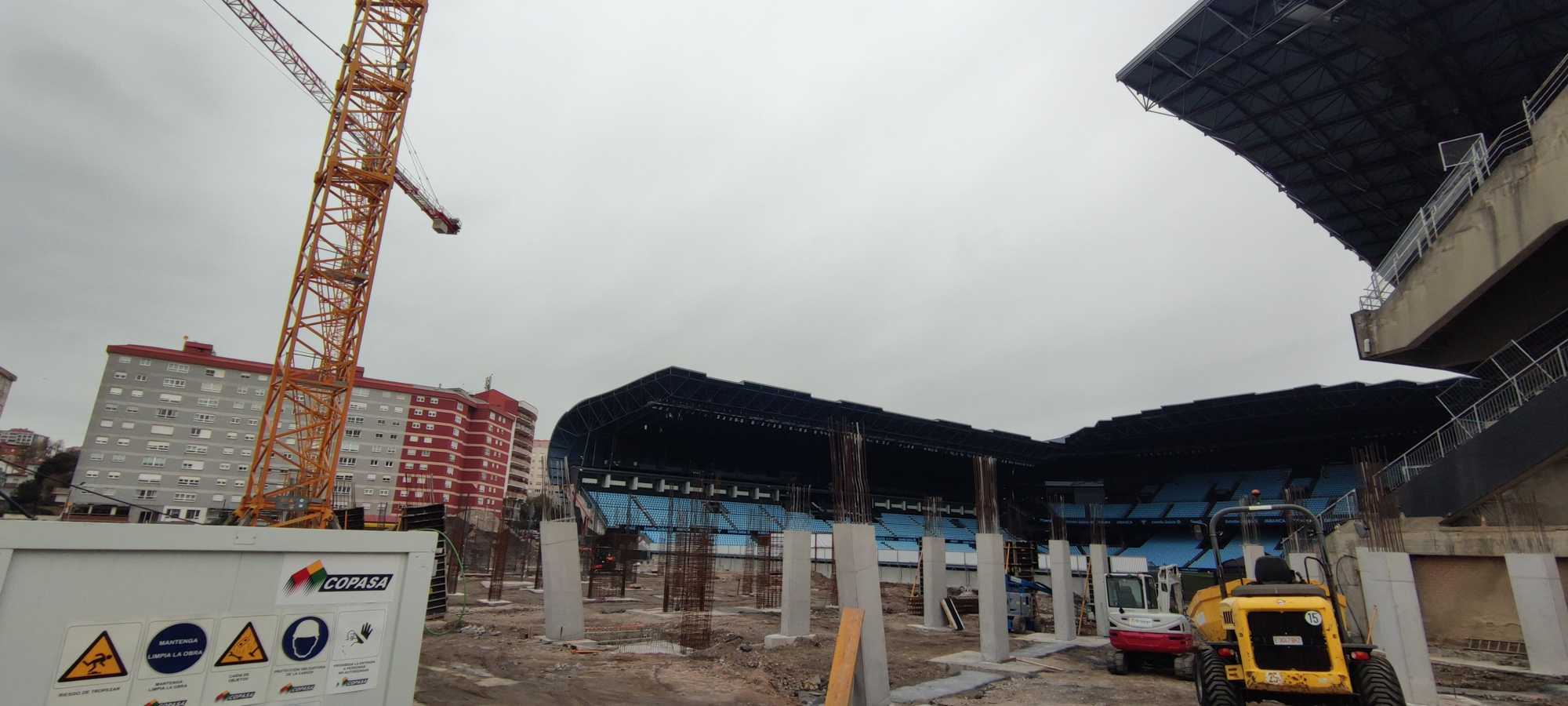

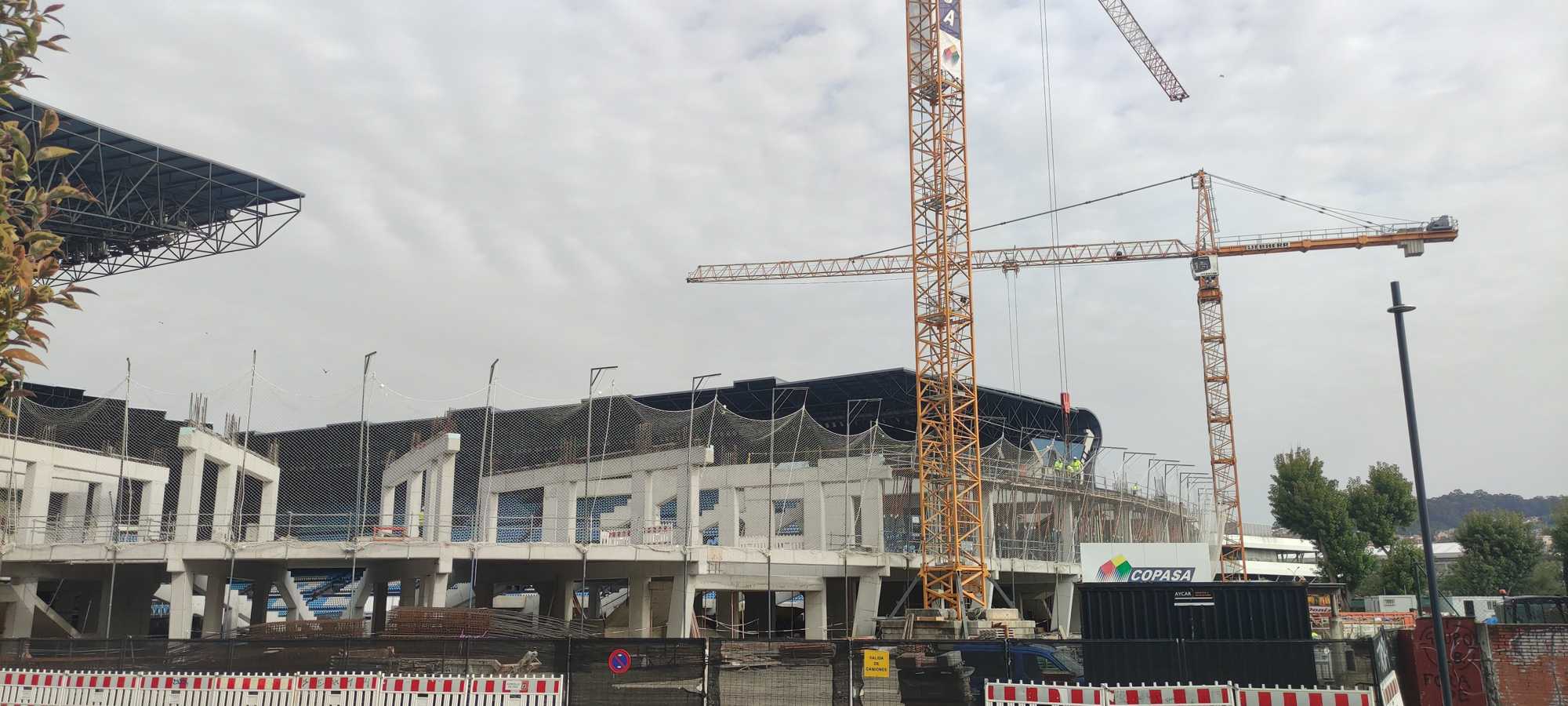

28.02.2025

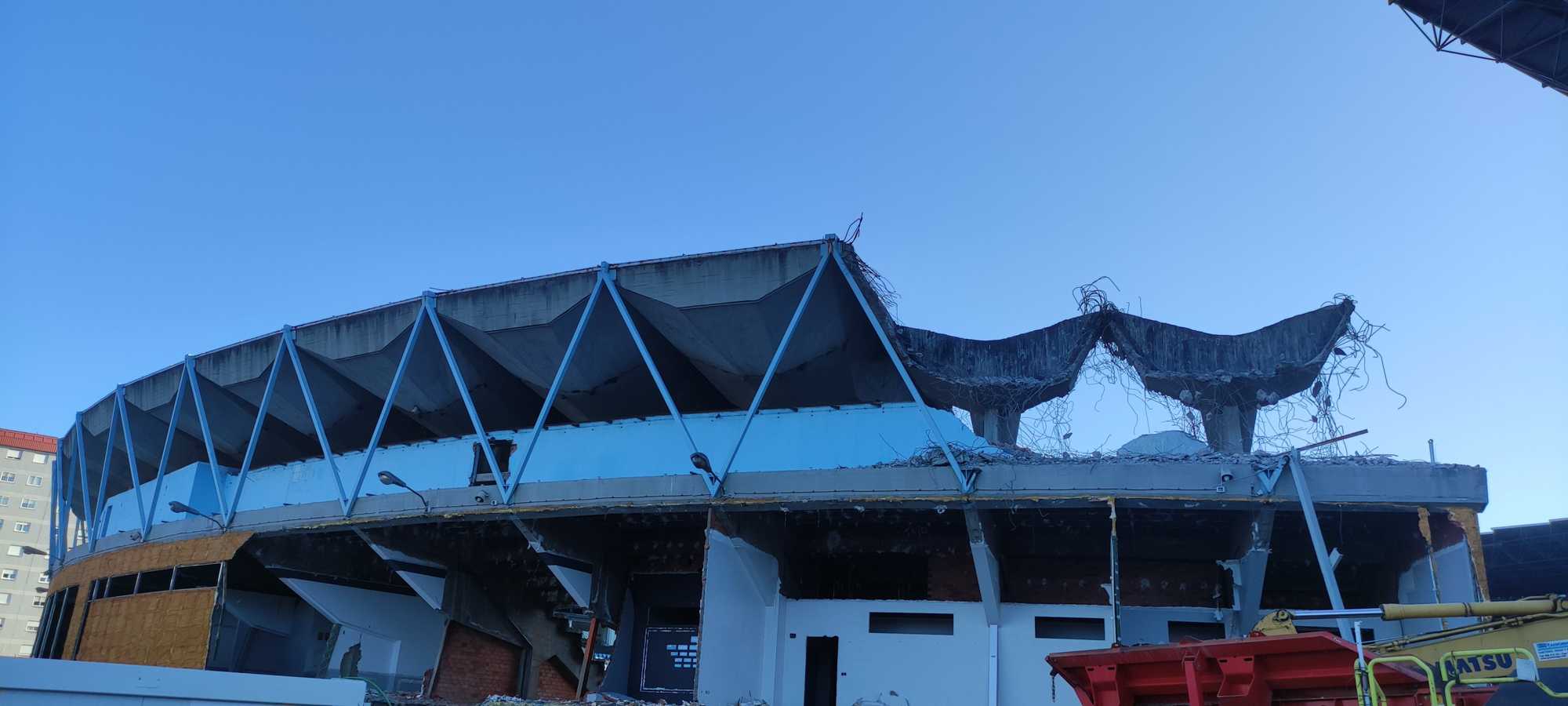

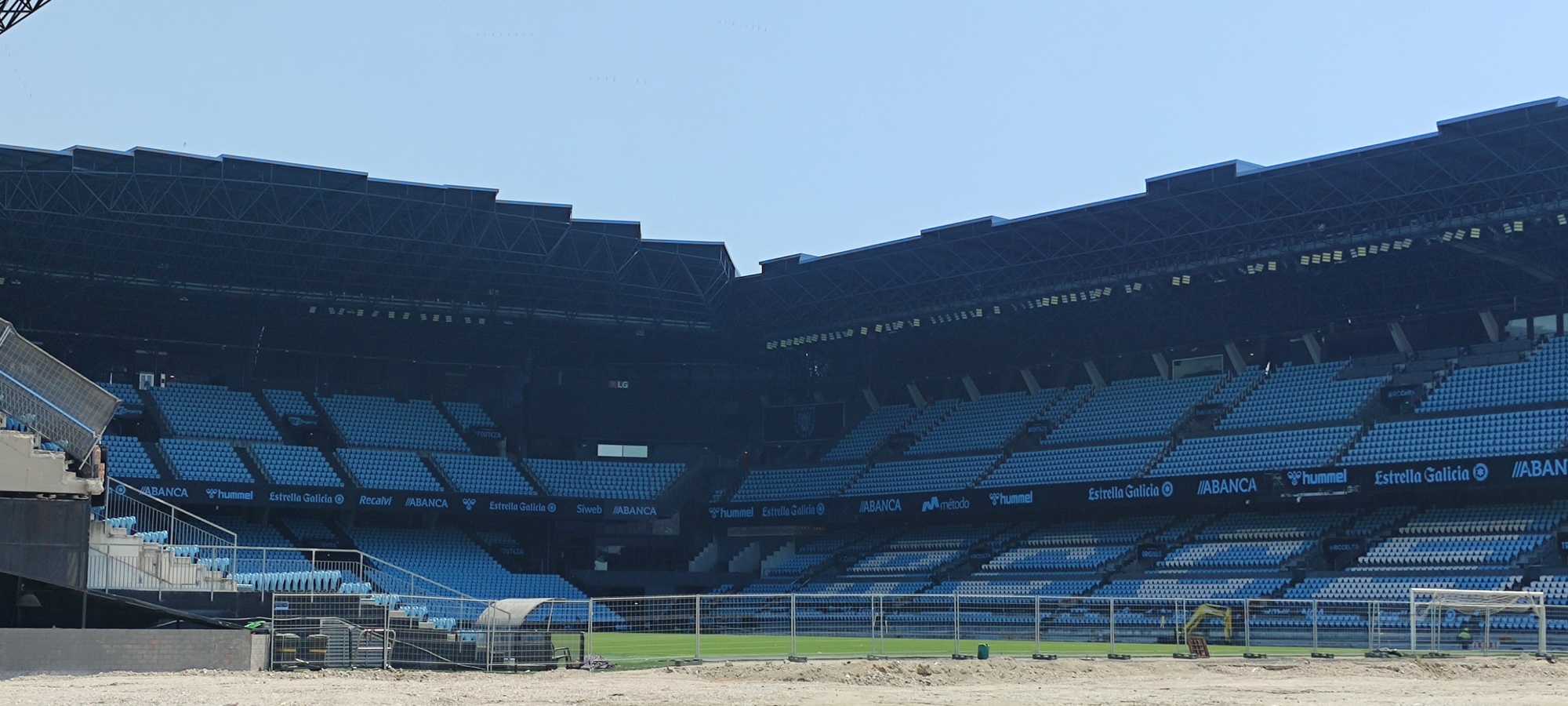

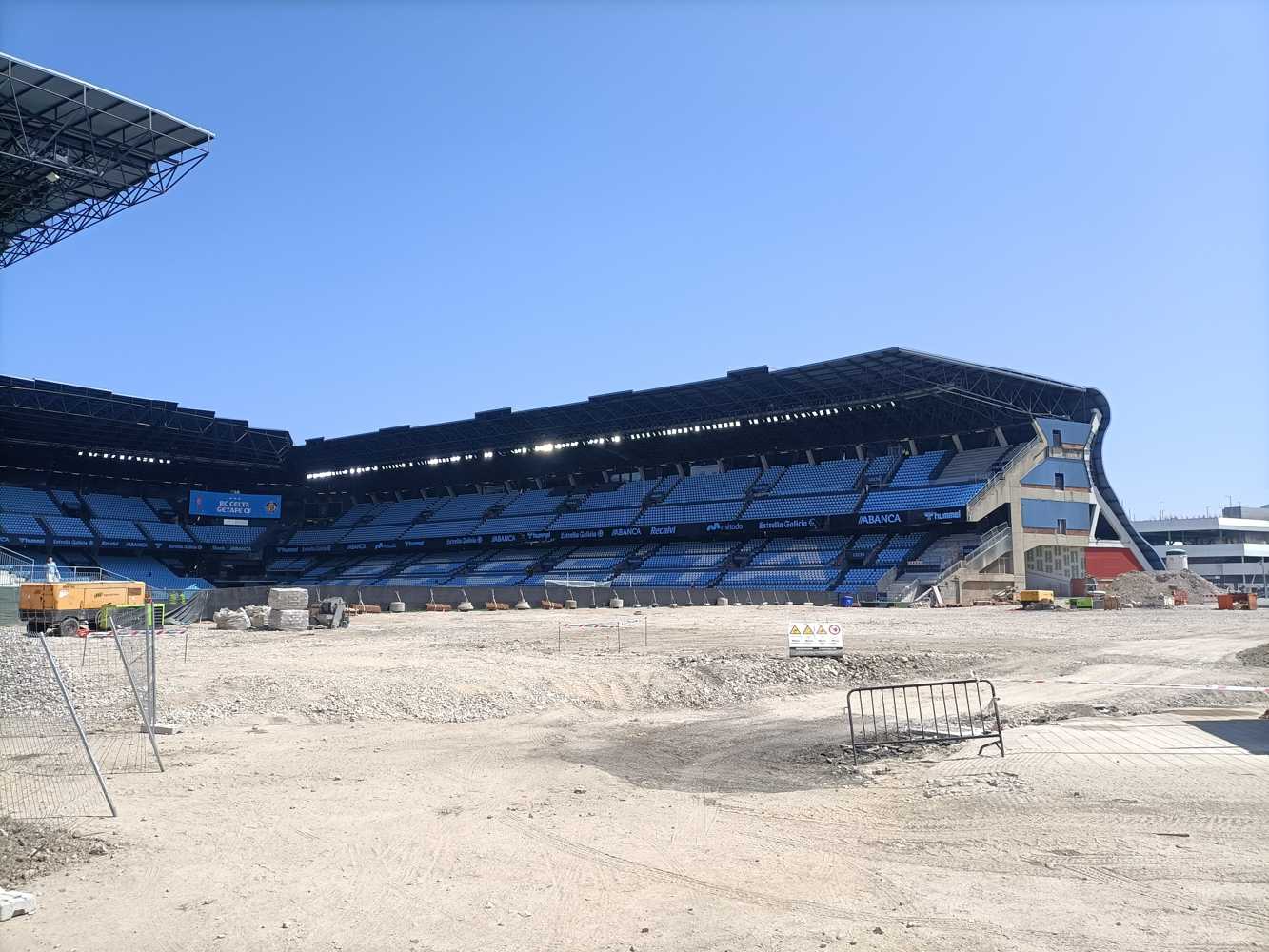

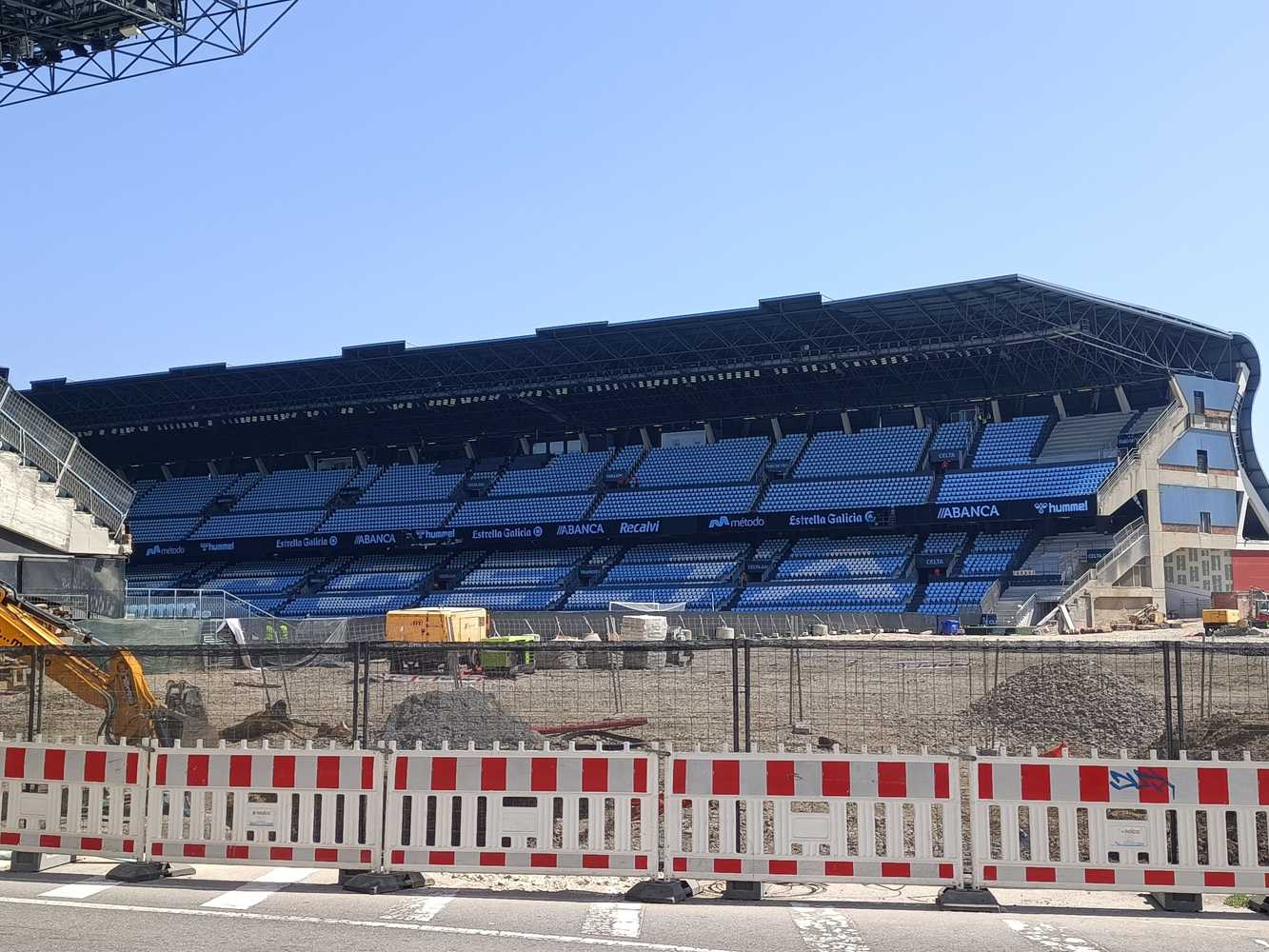

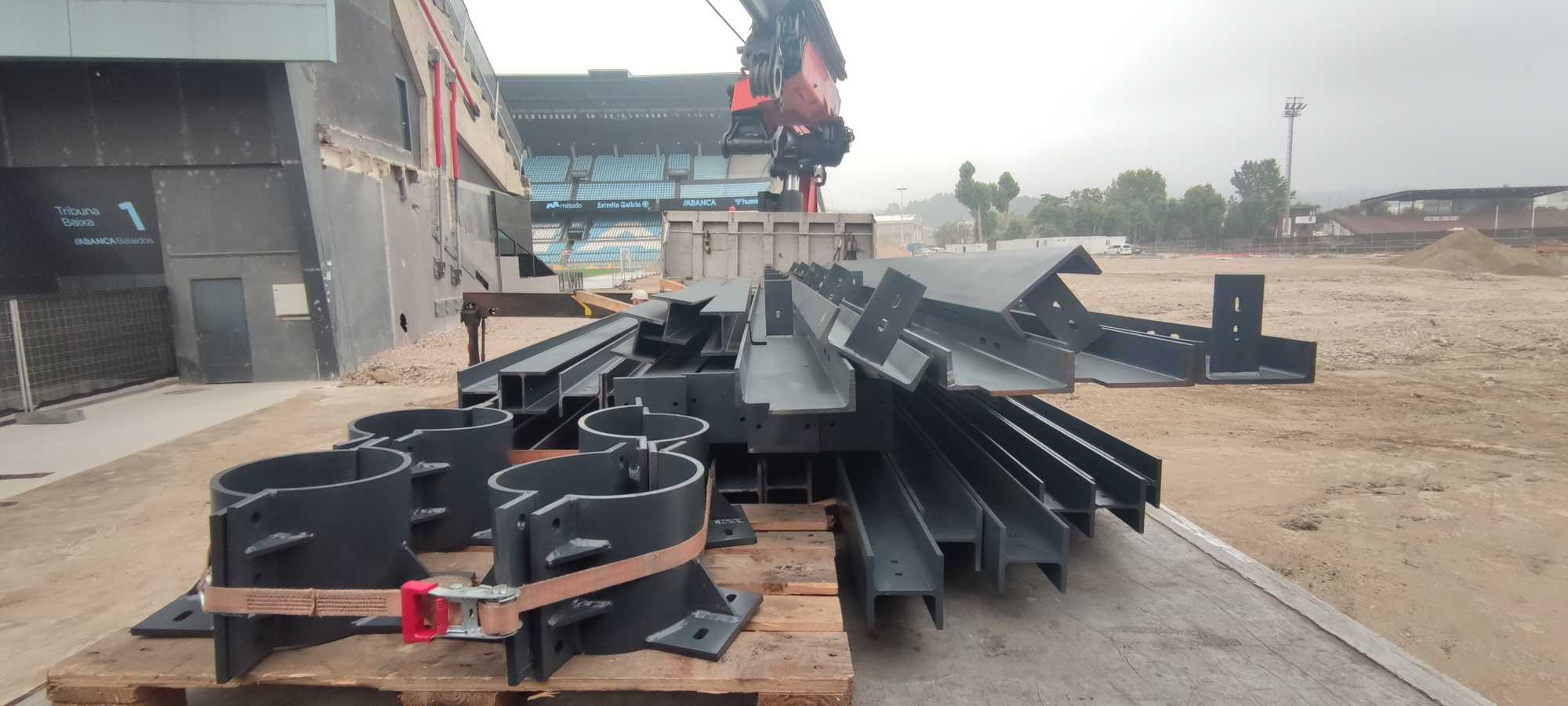

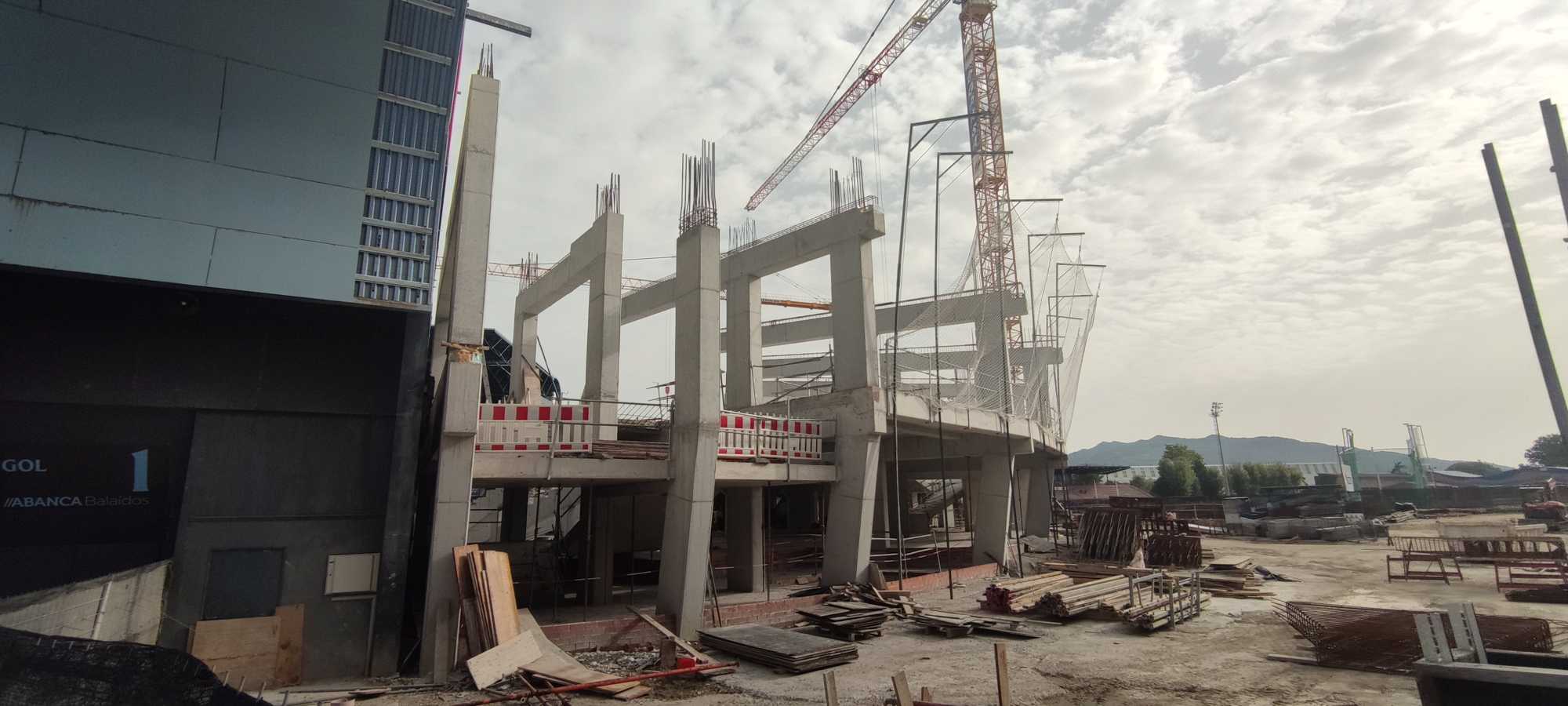

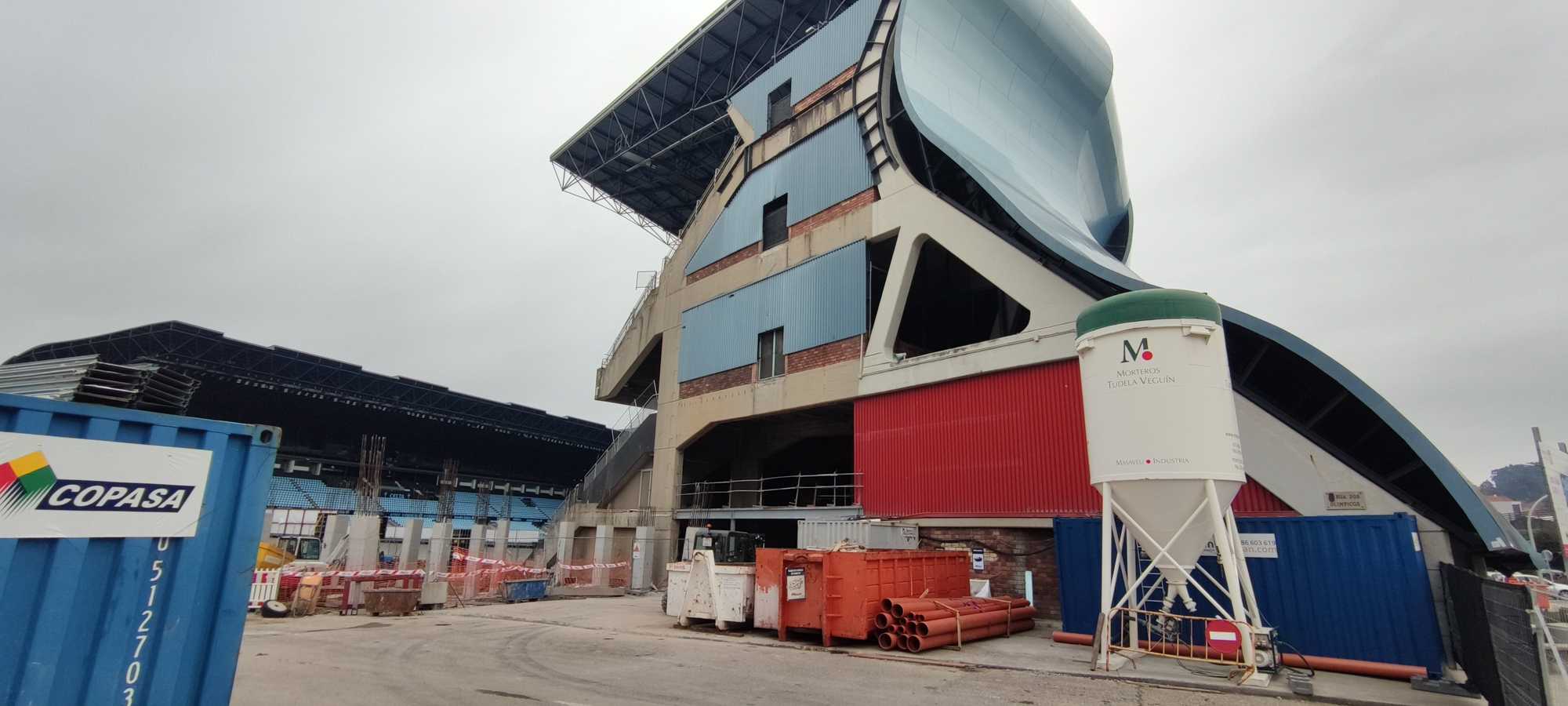

24.02.2025

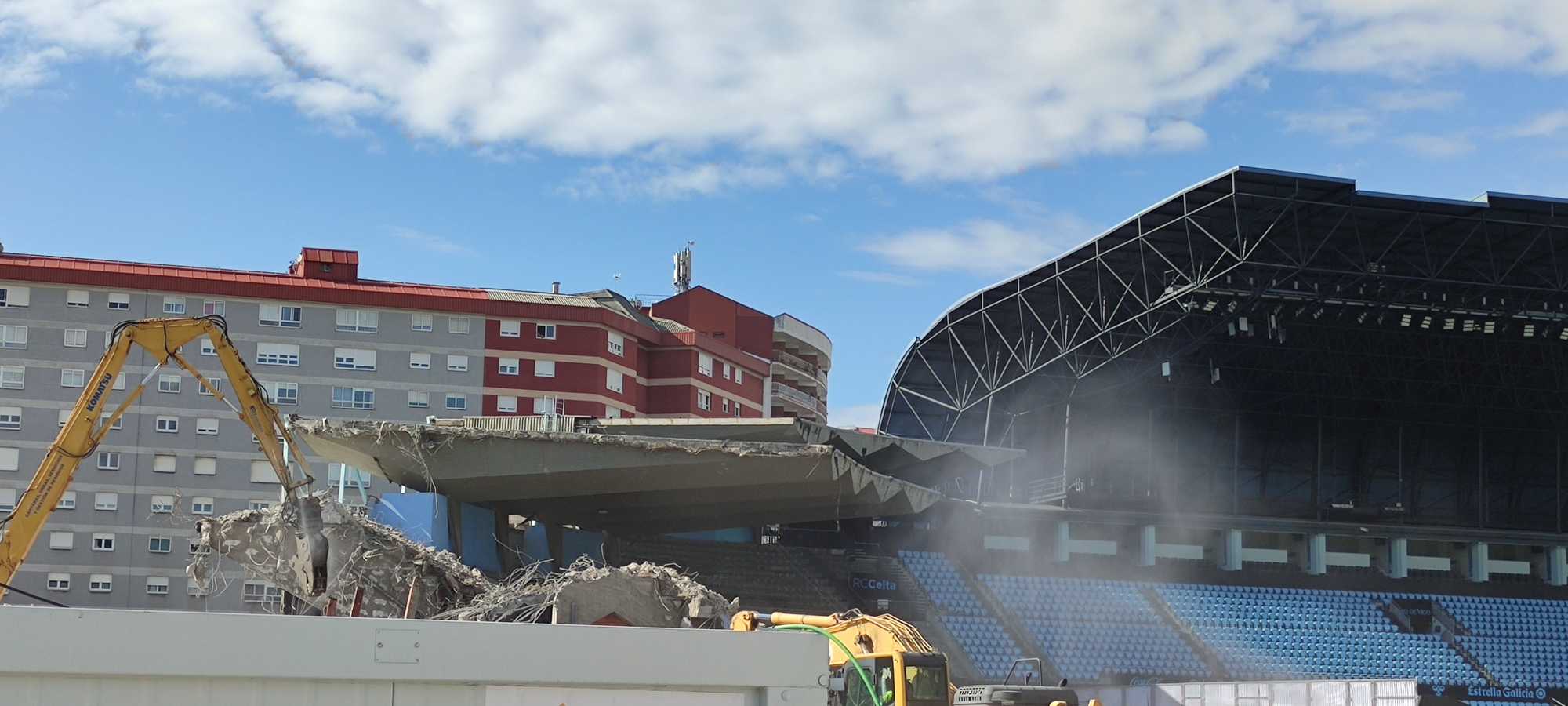

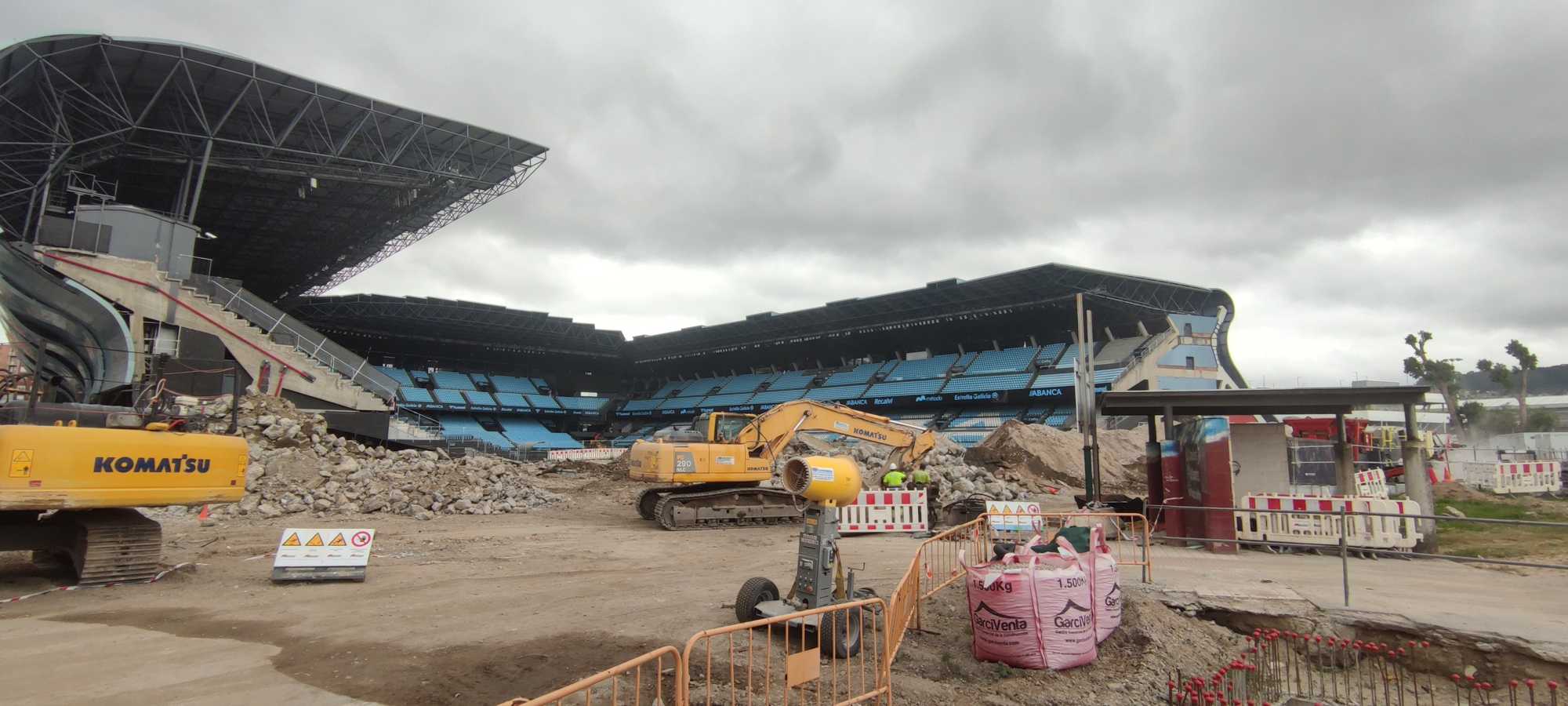

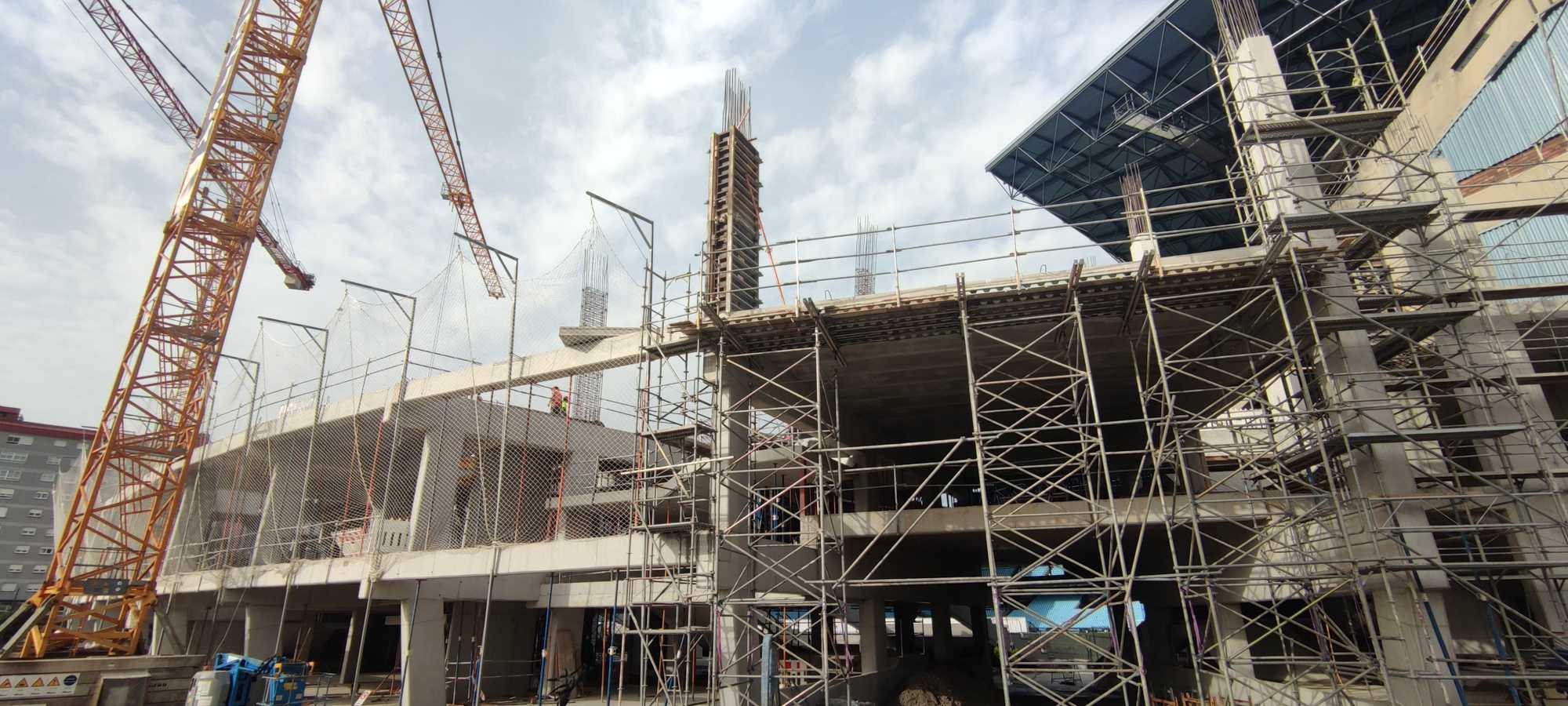

24.02.2025 © Concello de Vigo

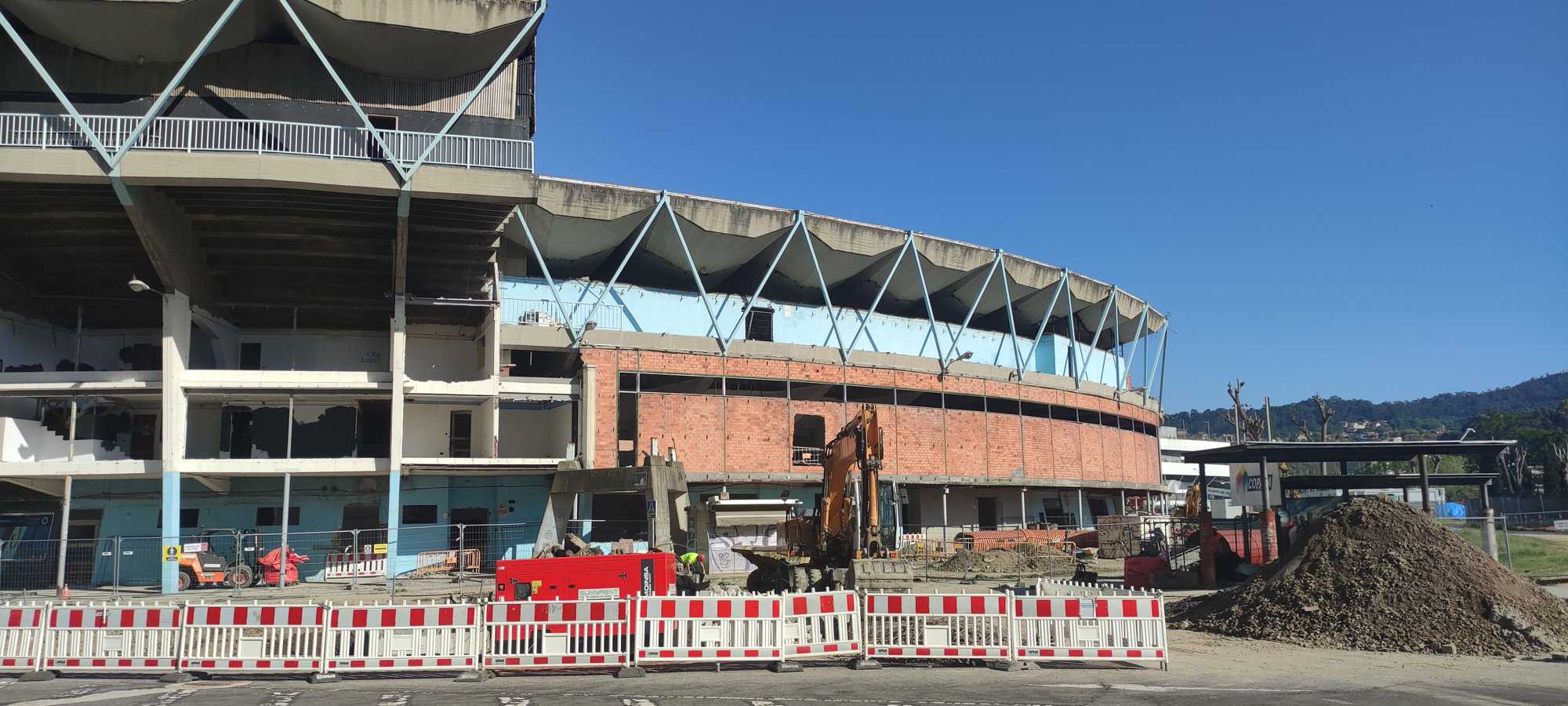

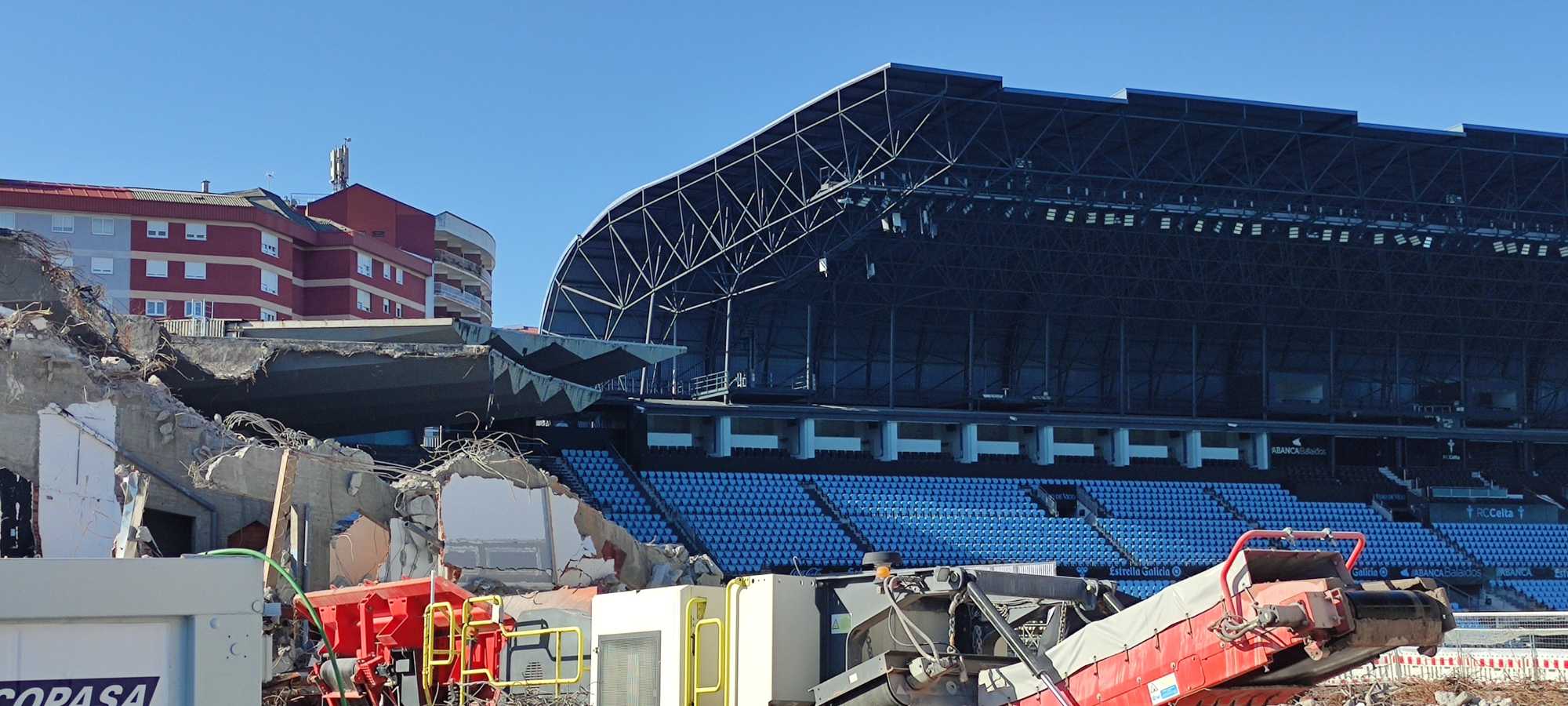

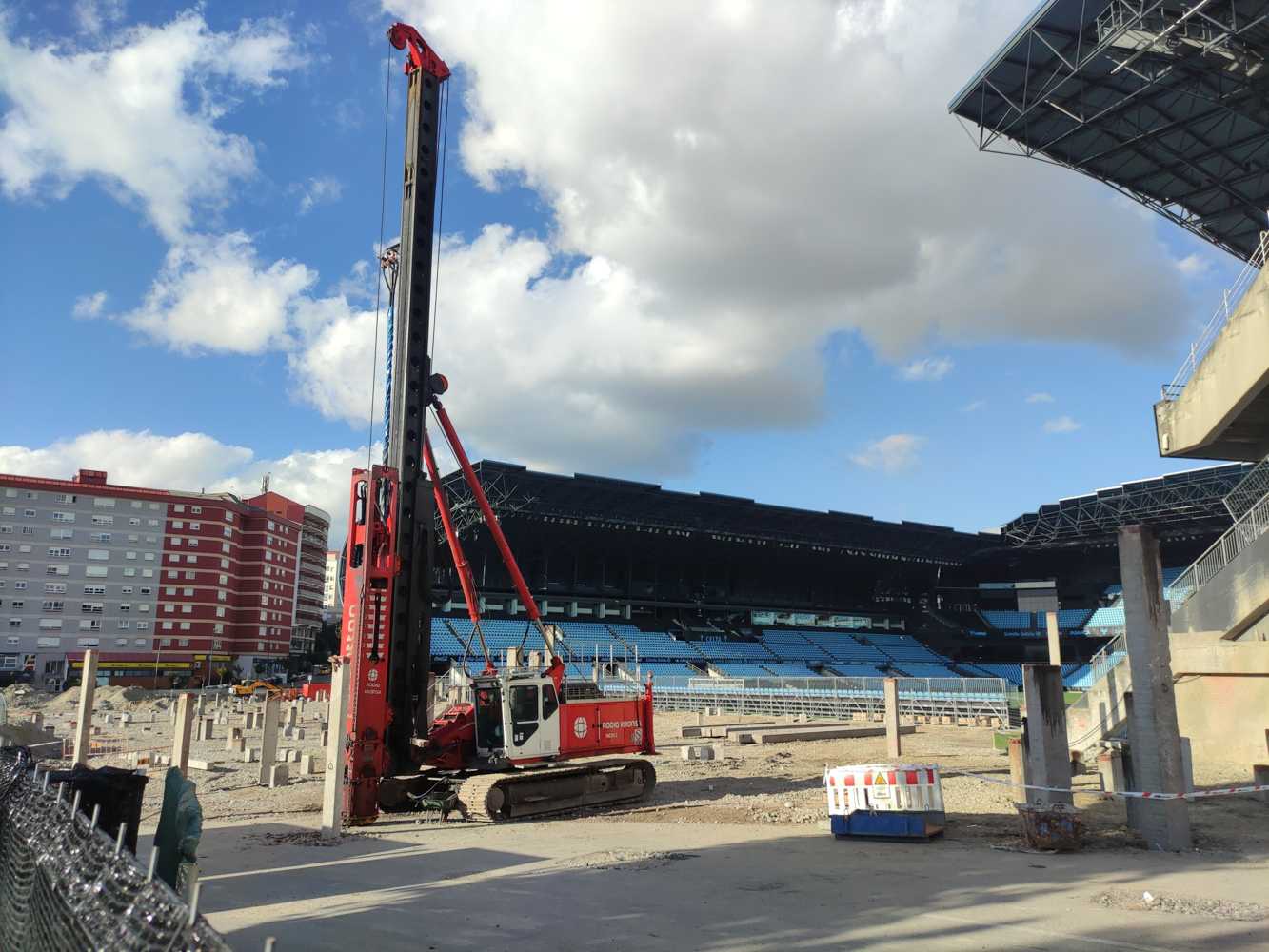

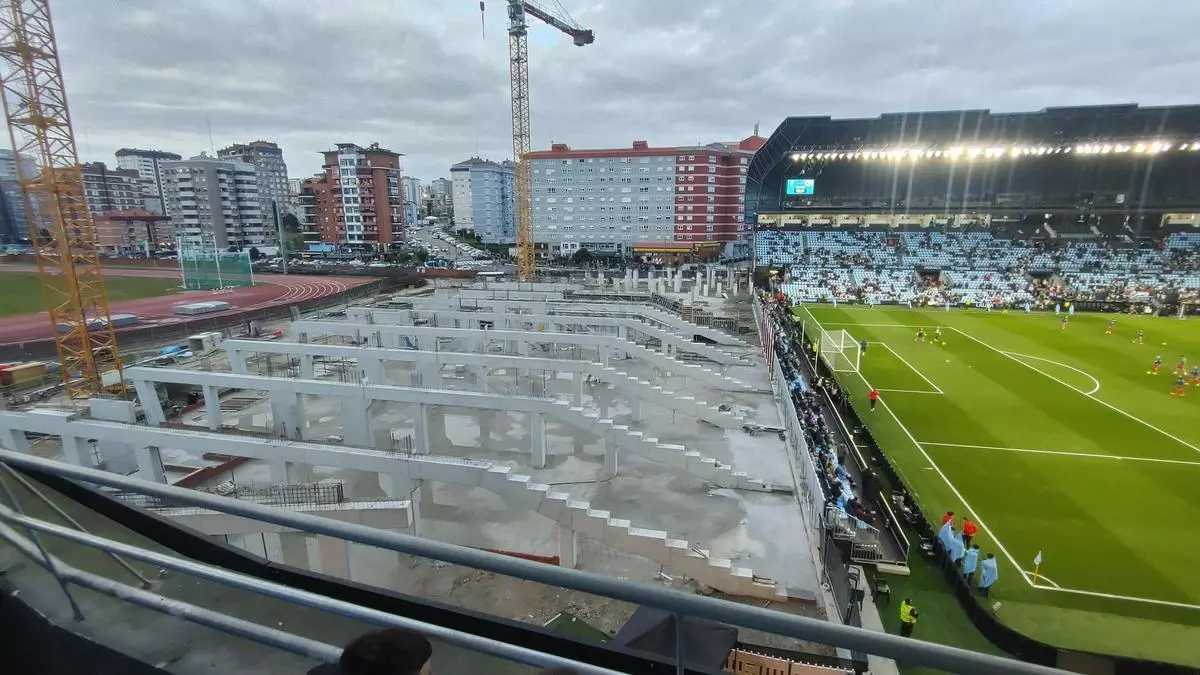

15.05.2023

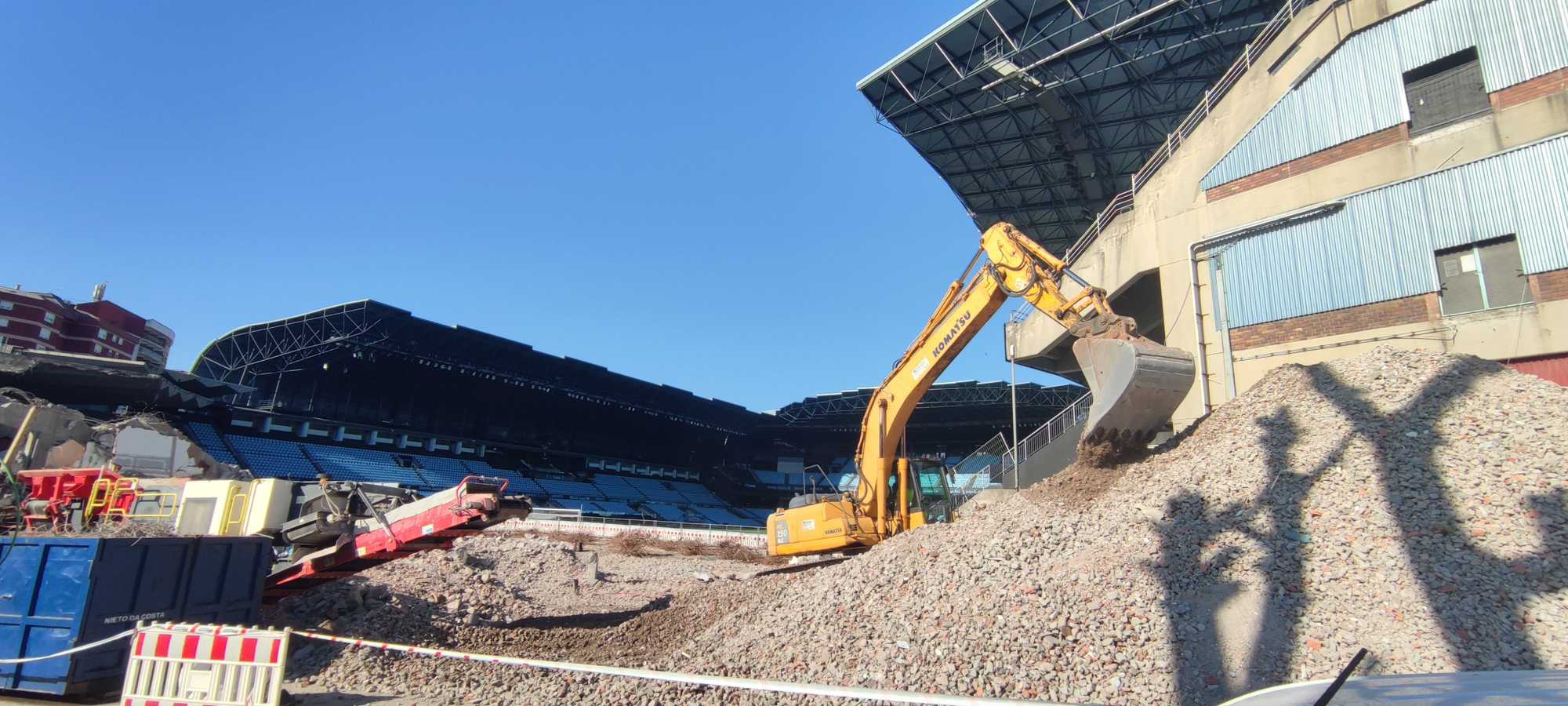

15.05.2023 © La Cámara del Celta 15.05.2023 © La Cámara del Celta 15.05.2023 © La Cámara del Celta 15.05.2023 © La Cámara del Celta 15.05.2023 © La Cámara del Celta

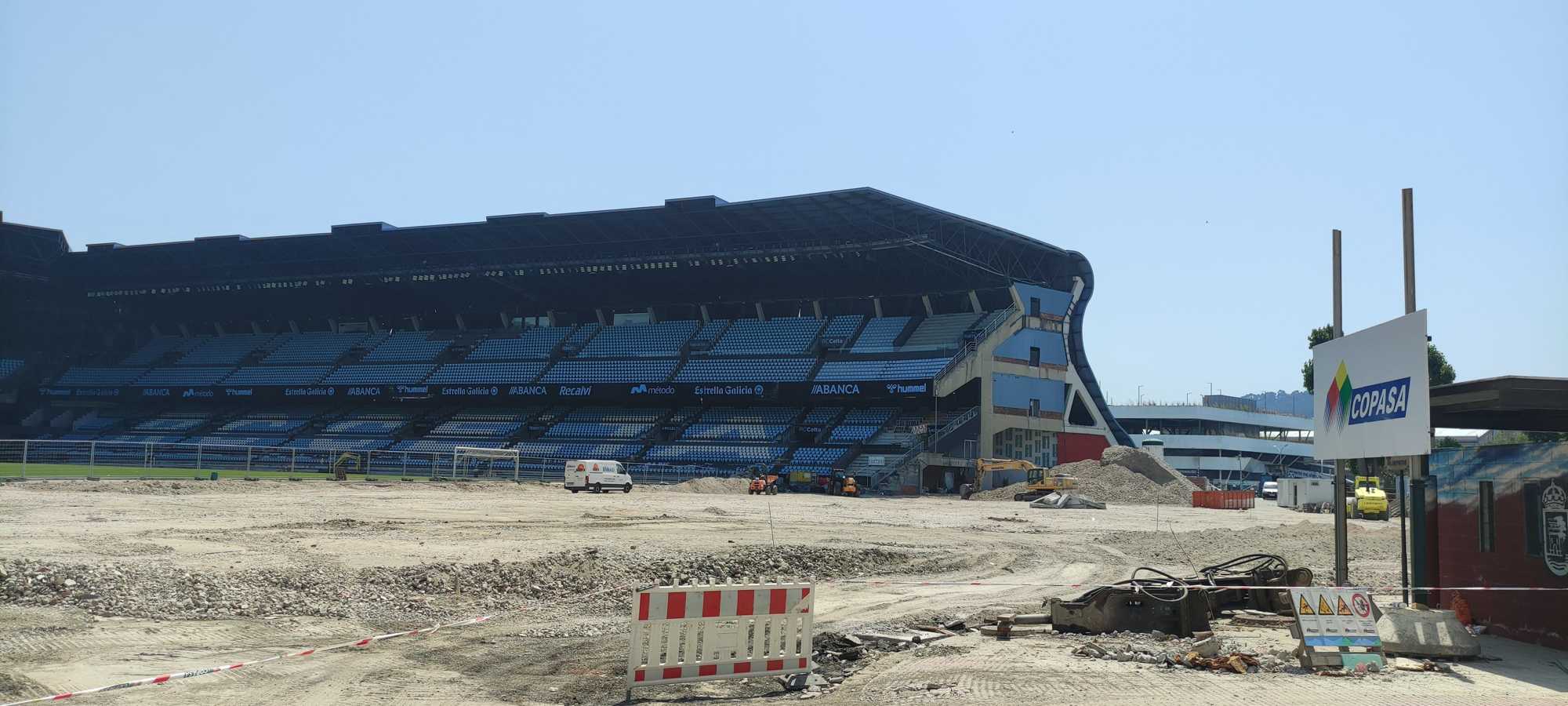

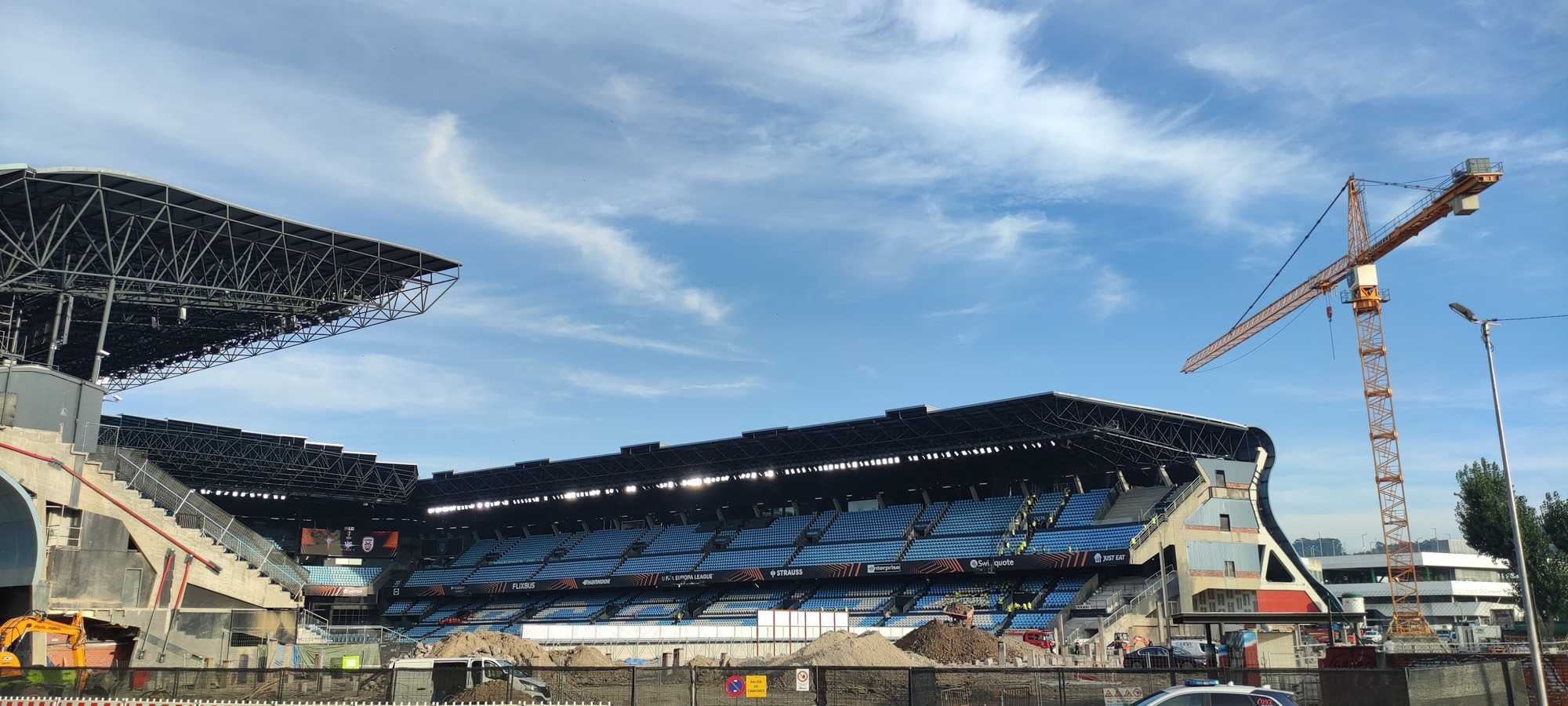

13.05.2023

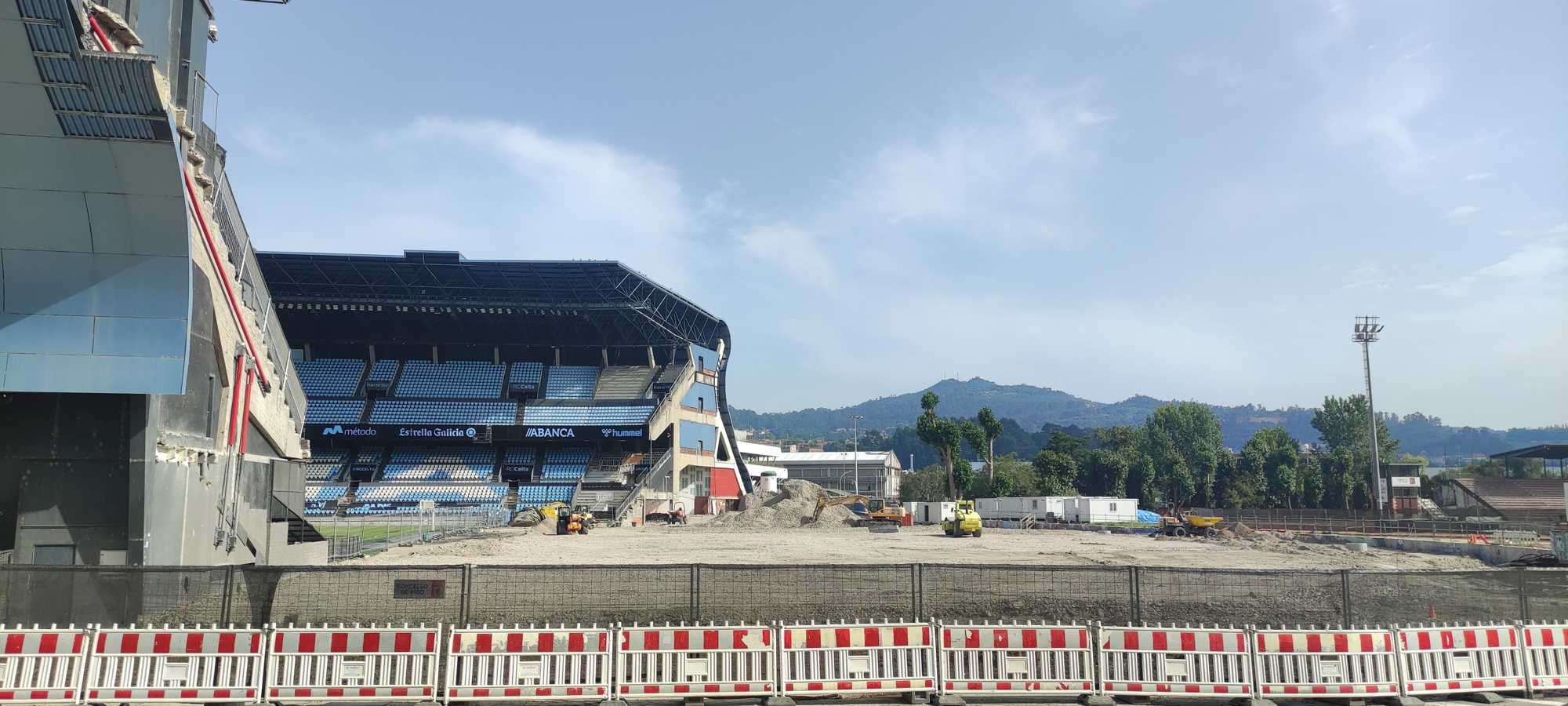

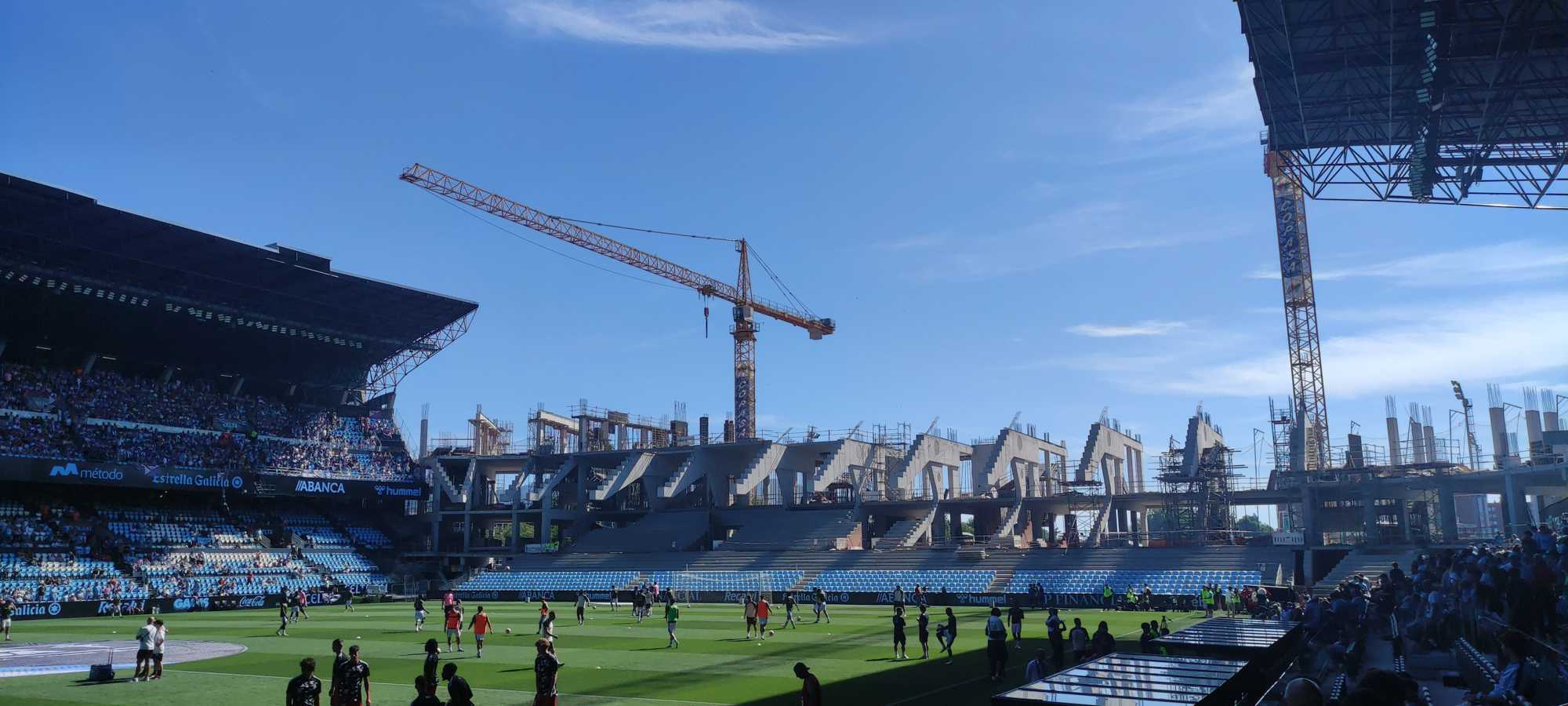

13.04.2023

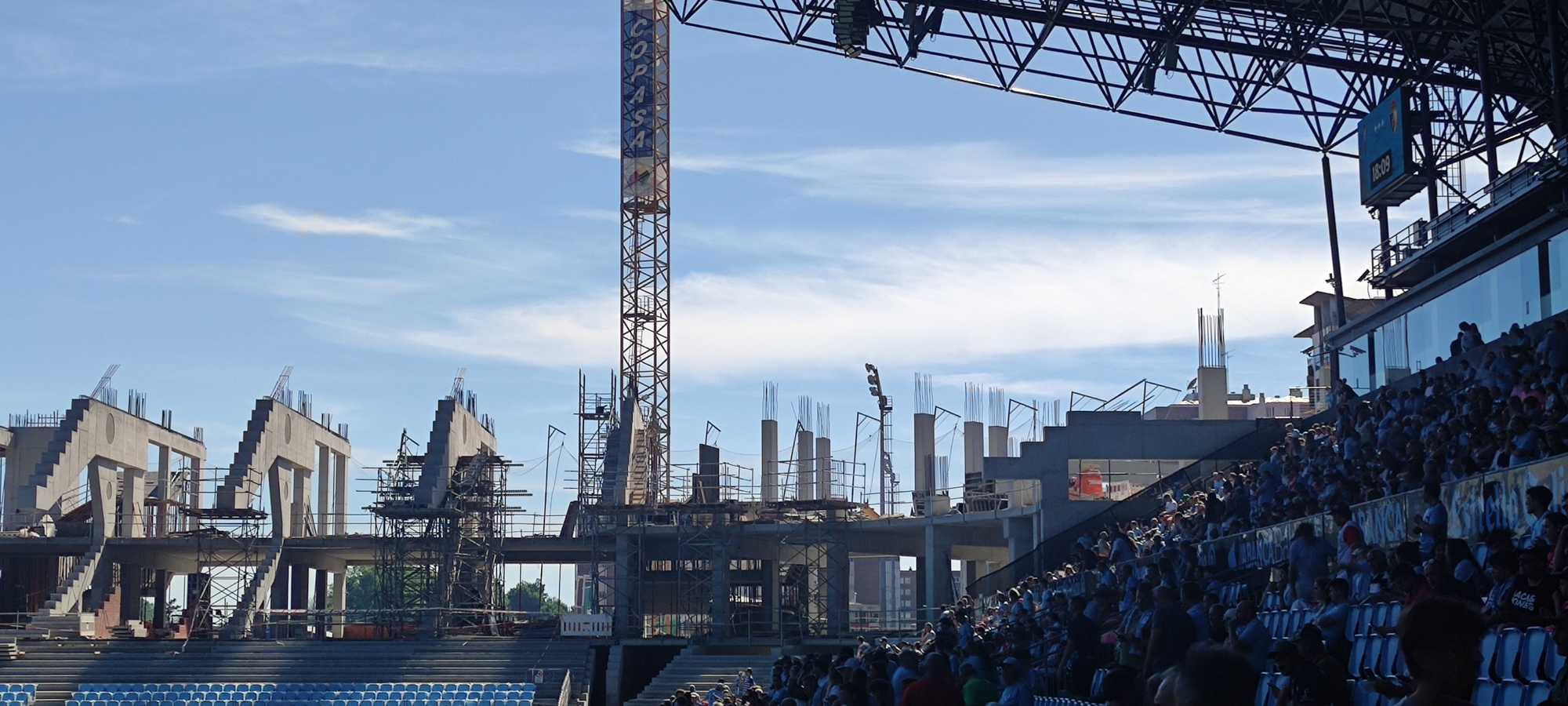

23.03.2023

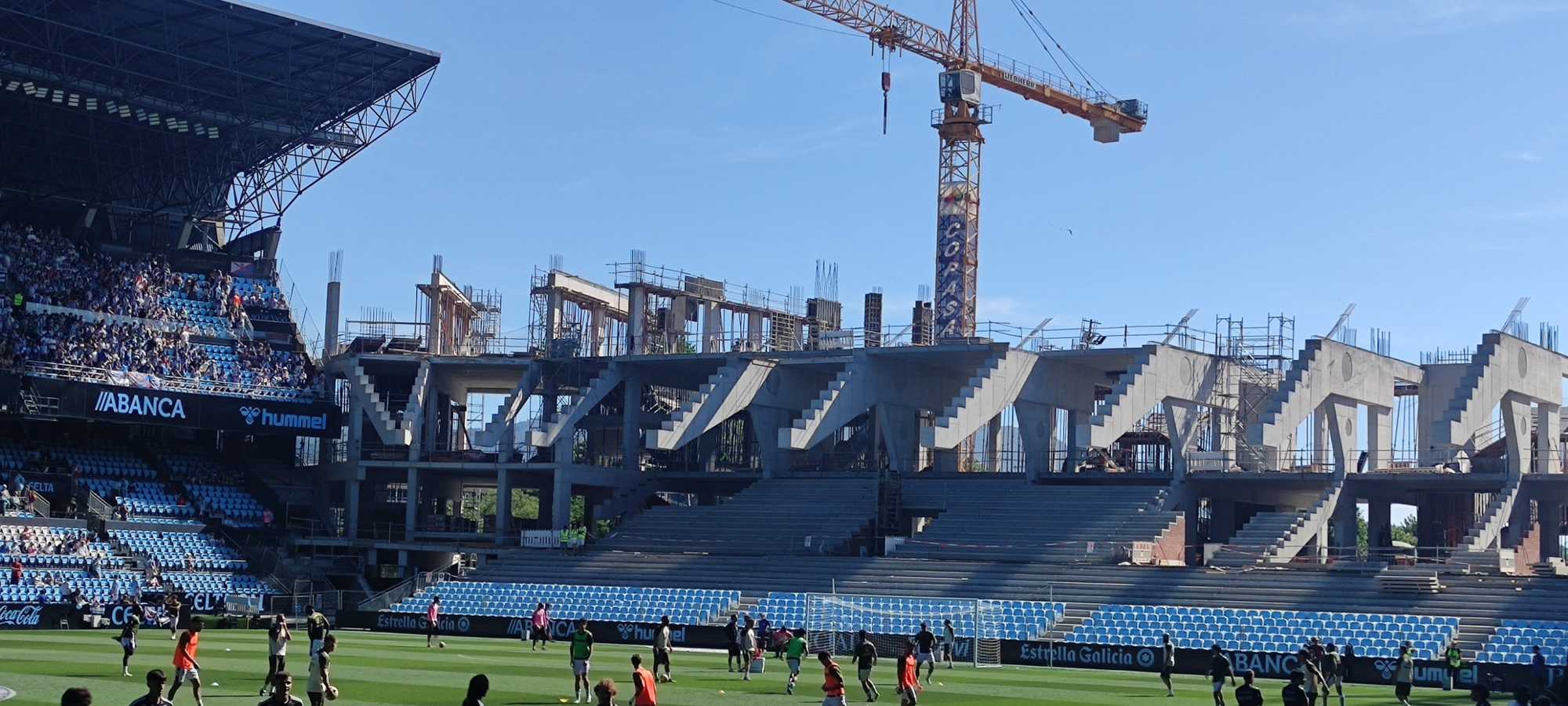

11.03.2023
11.03.2023 © La Cámara del Celta 11.03.2023 © La Cámara del Celta 11.03.2023 © La Cámara del Celta 11.03.2023 © La Cámara del Celta
02.03.2023
02.03.2023 © Alex 02.03.2023 © Alex 02.03.2023 © Alex 02.03.2023 © Alex 02.03.2023 © Alex 02.03.2023 © Alex
08.02.2023
08.02.2023 © Alex
26.01.2023
10.01.2023
10.01.2023 © Alex 10.01.2023 © Alex 10.01.2023 © Alex 10.01.2023 © Alex 10.01.2023 © Alex 10.01.2023 © Alex
27.12.2022
27.12.2022 © Alex 27.12.2022 © Alex 27.12.2022 © Alex 27.12.2022 © Alex 27.12.2022 © Alex 27.12.2022 © Alex 27.12.2022 © Alex 27.12.2022 © Alex
03.12.2022
19.11.2022
04.11.2022
13.10.2022
13.10.2022 © Alex 13.10.2022 © Alex 13.10.2022 © Alex 13.10.2022 © Alex 13.10.2022 © Alex 13.10.2022 © Alex
24.09.2022
12.09.2022
29.08.2022
02.08.2022
20.07.2022
12.07.2022
28.06.2022
09.06.2022
25.05.2022
18.05.2022
03.05.2022
25.04.2022
25.04.2022 © Alex 25.04.2022 © Alex 25.04.2022 © Alex 25.04.2022 © Alex 25.04.2022 © Alex 25.04.2022 © Alex
12.04.2022
05.04.2022
05.04.2022 © Alex 05.04.2022 © Alex 05.04.2022 © Alex 05.04.2022 © Alex 05.04.2022 © Alex 05.04.2022 © Alex
18.03.2022
10.03.2022
25.02.2022
18.02.2022
27.01.2022
27.01.2022 © Alex
01.12.2021
01.12.2021 © Alex
24.11.2021
24.11.2021 © Alex
08.11.2021
08.11.2021 © Alex
04.11.2021
04.11.2021 © Alex
04.10.2021
04.10.2021 © Alex
28.09.2021
20.09.2021
14.09.2021
14.09.2021 © Alex
27.08.2021
27.08.2021 © Alex
25.08.2021
18.08.2021
18.08.2021 © Alex
03.08.2021
03.08.2021 © Alex
16.10.2018
16.10.2018 © Preferencia Celeste (Twitter / Facebook) 16.10.2018 © Preferencia Celeste (Twitter / Facebook) 16.10.2018 © Preferencia Celeste (Twitter / Facebook)
06.05.2018
06.05.2018 © Preferencia Celeste (Twitter / Facebook) 06.05.2018 © Preferencia Celeste (Twitter / Facebook) 06.05.2018 © Preferencia Celeste (Twitter / Facebook)
16.03.2018
16.03.2018 © Preferencia Celeste (Twitter / Facebook) 16.03.2018 © Preferencia Celeste (Twitter / Facebook) 16.03.2018 © Preferencia Celeste (Twitter / Facebook) 16.03.2018 © Preferencia Celeste (Twitter / Facebook)
06.02.2018
06.02.2018 © Preferencia Celeste (Twitter / Facebook) 06.02.2018 © Preferencia Celeste (Twitter / Facebook) 06.02.2018 © Preferencia Celeste (Twitter / Facebook) 06.02.2018 © Preferencia Celeste (Twitter / Facebook)
04.01.2018
04.01.2018 © Preferencia Celeste (Twitter / Facebook) 04.01.2018 © Preferencia Celeste (Twitter / Facebook) 04.01.2018 © Preferencia Celeste (Twitter / Facebook) 04.01.2018 © Preferencia Celeste (Twitter / Facebook)
07.08.2017
07.08.2017 © RC Celta
05.02.2017
05.02.2017 © DelCelta.com
22.12.2016
22.12.2016 © DelCelta.com 22.12.2016 © DelCelta.com 22.12.2016 © DelCelta.com
06.11.2016
06.11.2016 © A. Frigole
04.11.2016
04.11.2016 © DelCelta.com
18.10.2016
05.10.2016
23.09.2016
19.09.2016
19.09.2016 © ImagenesDeVigo.com 19.09.2016 © ImagenesDeVigo.com 19.09.2016 © ImagenesDeVigo.com
09.08.2016
09.08.2016 © ImagenesDeVigo.com 09.08.2016 © ImagenesDeVigo.com 09.08.2016 © ImagenesDeVigo.com
12.05.2016
12.05.2016 © ImagenesDeVigo.com 12.05.2016 © ImagenesDeVigo.com
17.03.2016
17.03.2016 © CeltaVigo.net 17.03.2016 © CeltaVigo.net
21.05.2015
21.05.2015 © ImagenesDeVigo.com 21.05.2015 © ImagenesDeVigo.com 21.05.2015 © ImagenesDeVigo.com
11.05.2015
11.05.2015 © ImagenesDeVigo.com 11.05.2015 © ImagenesDeVigo.com 11.05.2015 © ImagenesDeVigo.com
17.04.2015
17.04.2015 © DelCelta.com
