Spotify Camp Nou
Updated: 18.11.2024
Target capacity | 105 000 |
---|---|
Capacity before works | 99 354 |
Country | Spain |
City | Barcelona |
Clubs | FC Barcelona |
Category | Construction in progress |
Construction | 2022–2025 |
Cost | €1.07 B ($1.16 B) |
Design | IDOM, b720, Nikken Sekkei |
Advertisement
Spotify Camp Nou – construction description
Why is there a plan to upgrade Camp Nou?
Camp Nou opened on September 24, 1957, as the seventh stadium in FC Barcelona's history. Initially, the venue had two levels of stands. Between 1980 and 1982, before the Spanish World Cup, the auditorium was extended with a third tier. Between 1993 and 1994, the lower ring was rebuilt and the pitch was lowered. The last standing areas were also removed.
In this form, the facility has remained to this day, although minor renovations and modernisations have been carried out on it. With a capacity of 99,354 spectators, it is the largest stadium in Europe and ranks among the world's top in this respect. At the same time, FC Barcelona is one of the most recognisable football clubs with a worldwide fan base, so it is not surprising that since the beginning of the 21st century there have been plans to expand Camp Nou once again.
How did the vision for the extension of Camp Nou unfold?
A contest for the architectural concept of the expansion was held in 2007, and the vision by Foster + Partners won. Due to the global financial crisis, the project ultimately failed to materialise.
In 2014, a referendum was held among club members in favour of the Espai Barça project, a vision for the redevelopment of FC Barcelona's sporting facilities, including the modernisation of Camp Nou as a major investment. In 2016, another competition was held for the concept of the stadium upgrade, with the vision prepared by Nikken Sekkei and Joan Pascual - Ramon Ausió Arquitectes winning (the eventual design was prepared by architects from IDOM, b720 and Nikken Sekkei).
What are the main features of Camp Nou expansion design?

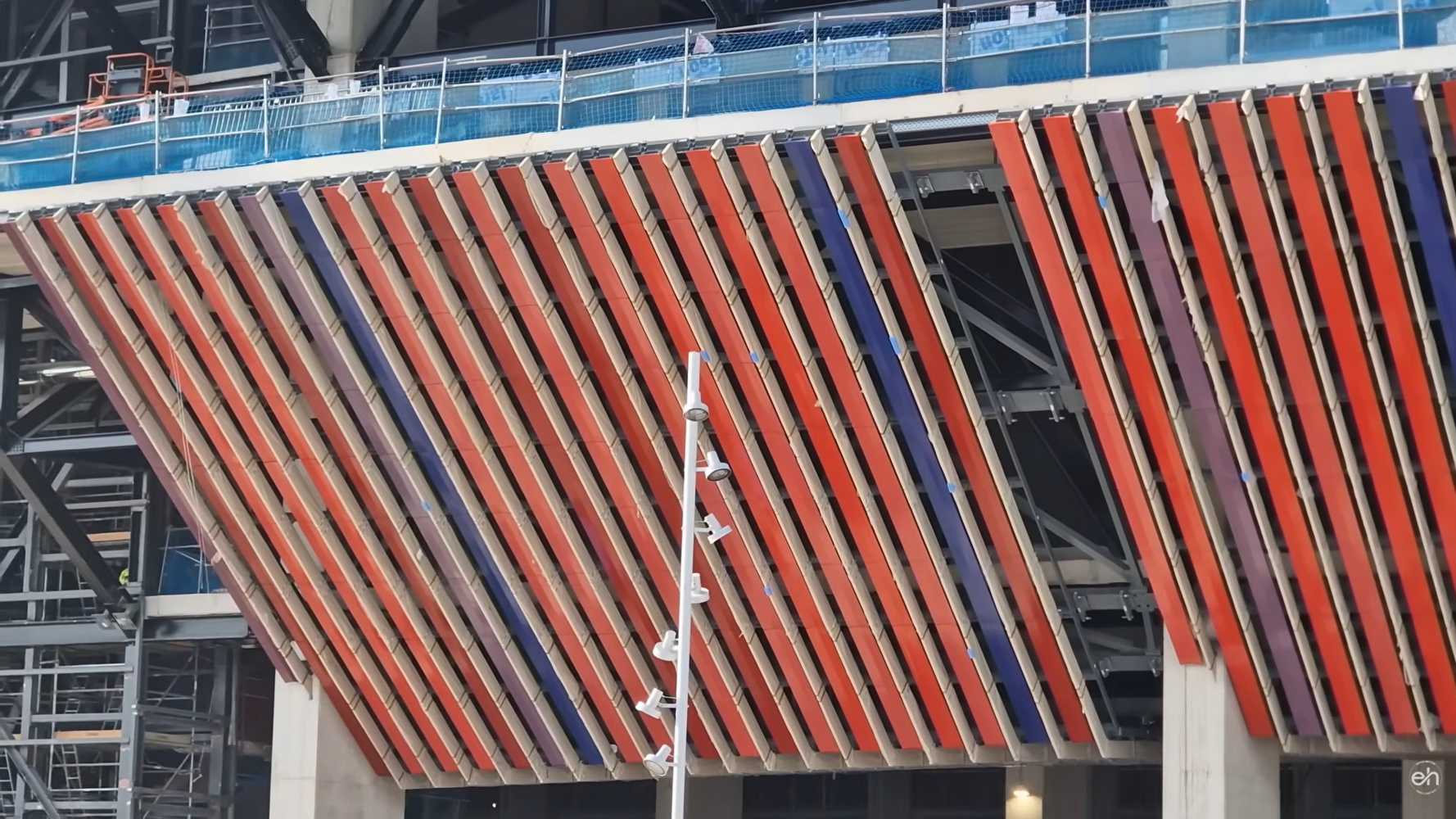

The main features of the new design are: the construction of a new third tier from scratch with a uniform height along the entire external perimeter and thus increasing the capacity of the stadium to more than 105,000 spectators, the creation of a VIP ring between the second and third tiers of the stands and the roofing of all spectator seats in the stadium. Three large video screens will be built under the roof. Externally, the venue will be given an open feel with wide terraces.
What costs are involved in the expansion design of Camp Nou?
With investment costs rising exponentially, another internal referendum was held at the end of 2021, in which the club's members agreed to carry out Espai Barça on a budget of no more than €1.5 billion (of which €900 million was to go towards upgrading Camp Nou). The stadium redevelopment is to be completed between 2022 and 2025.
When did the initial works for upgrading Camp Nou start and what was the extent of them?
The first preparatory works started as early as July 2022. It is worth mentioning that a sponsorship agreement has also been in place since July 2022, under which the name of the venue has been changed to Spotify Camp Nou.
Since September 1, 2022, the demolition of a section of the stand behind the south gate has been underway. The scope of work included the removal of elements in the rear of this stand, along with the dismantling of the central section of the top floor of the auditorium. This was to be followed by the construction of new stairs and escape routes to restore the use of the seats not included in the remodelling on the first and second floors.
Work began with the de-installation of the scoreboard and the removal of seats. This resulted in the disposal of 3,782 seats, most of which were occupied by pass holders who were offered a move to similar areas elsewhere in the venue or a temporary deferral of payment.

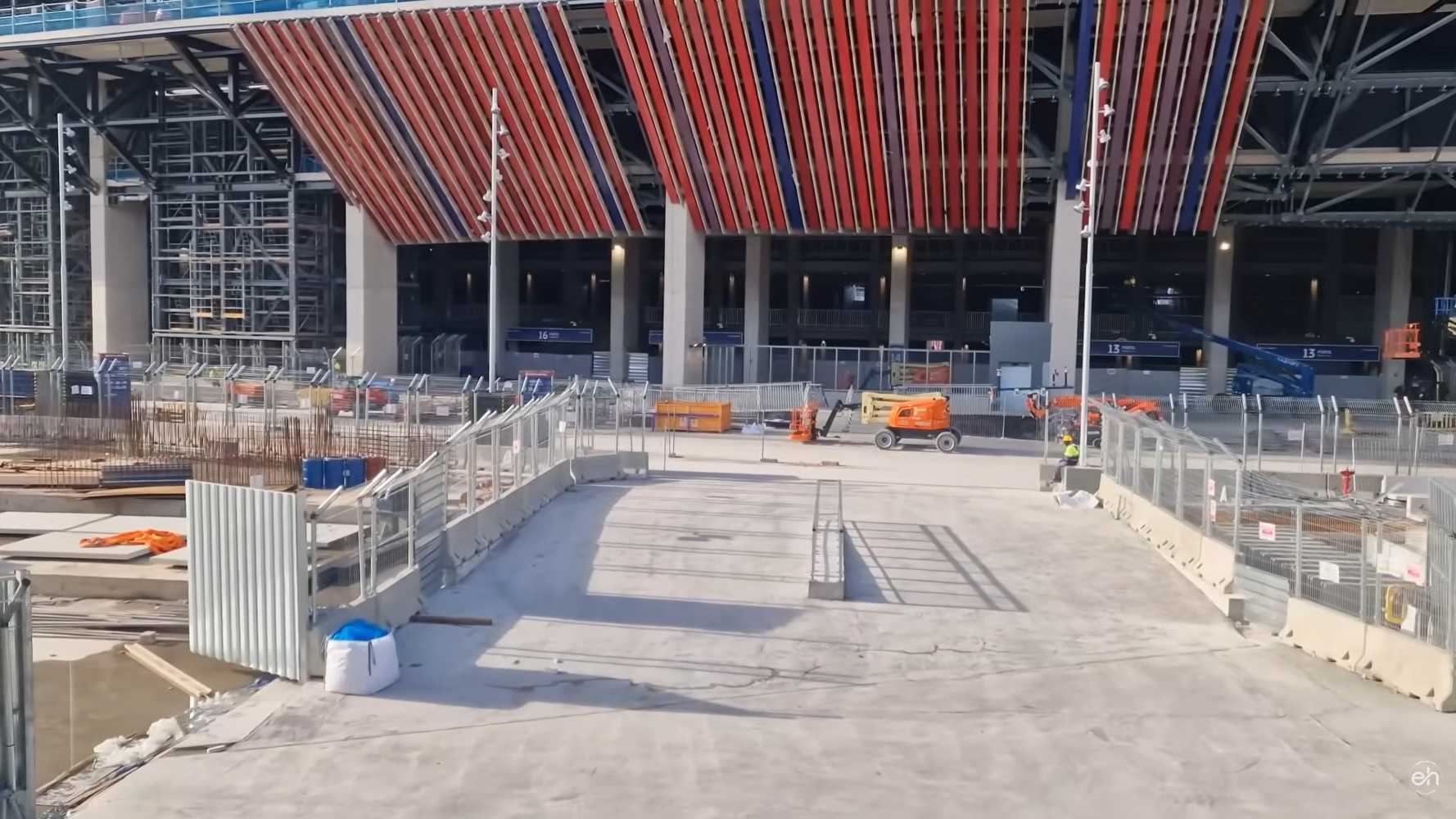

Demolition gathered pace in November 2022, after the start of the league break associated with the Qatar World Cup. The dismantling of the reinforced concrete elements of the stand then began. The entire work was completed by the end of 2022 and cost €4.6 million. The company Erri Berri was contracted for the demolition.
The decision to partially demolish the third level of the Gol Sud already in the 2022/23 season was taken in view of the possibility of taking advantage of the World Cup break, originally the work was planned to be carried out later.
The partial demolition of this part of Camp Nou was a priority, as it is the place where all the technological connections will be installed. Carrying out this work earlier was to help with scheduling and save time when the main construction work would start.
When will the main works for Camp Nou expansion be carried out?

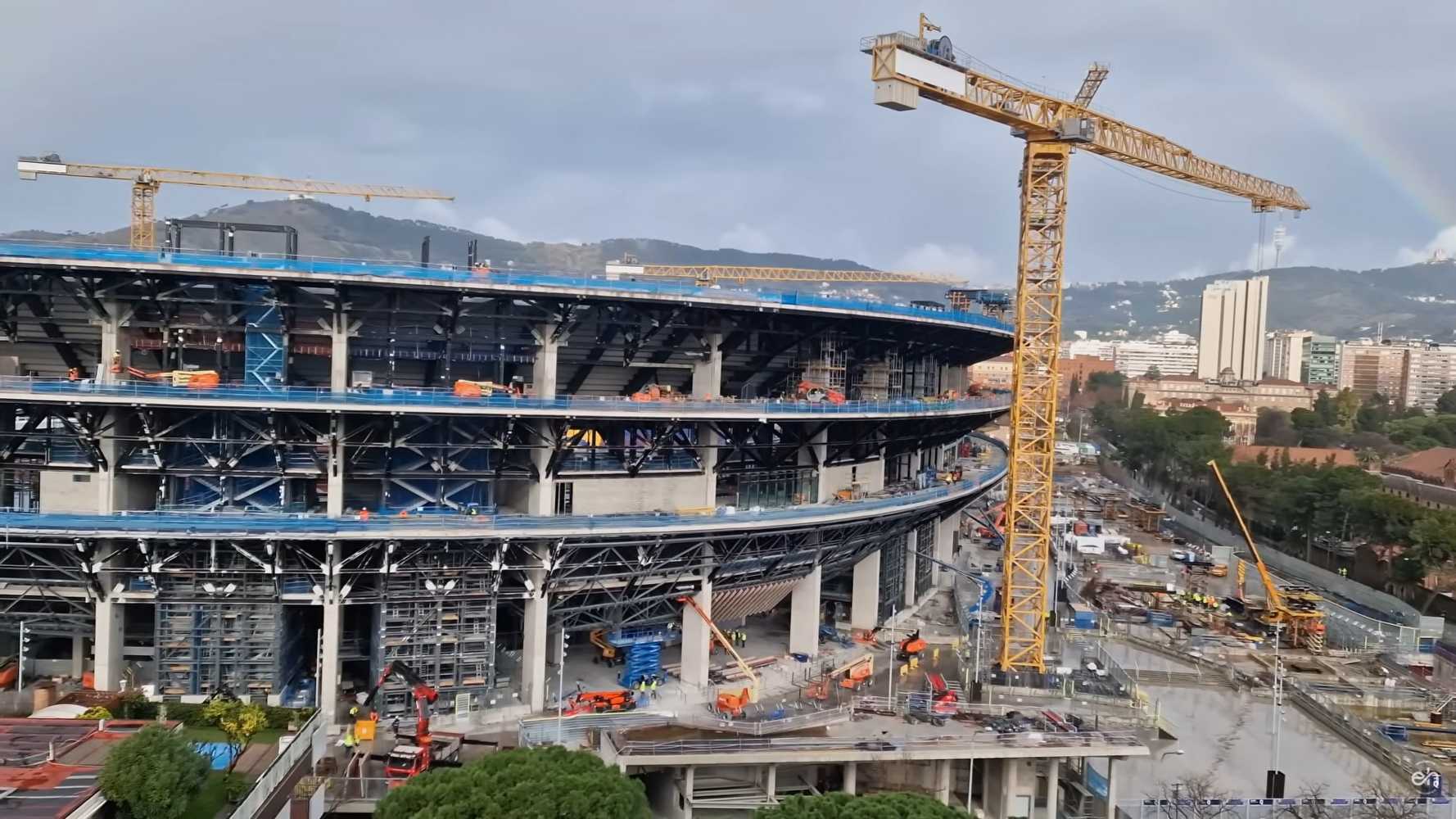

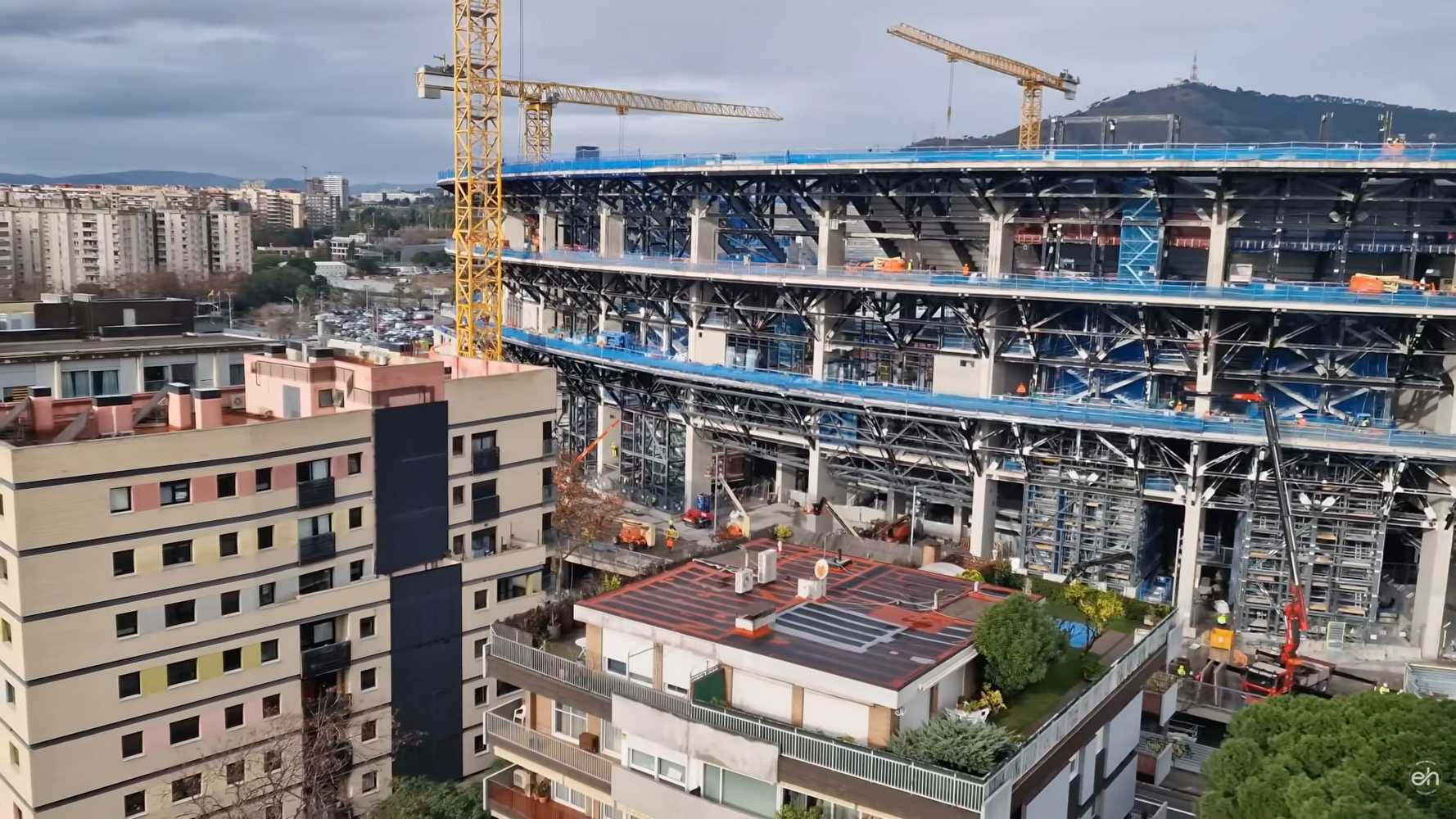

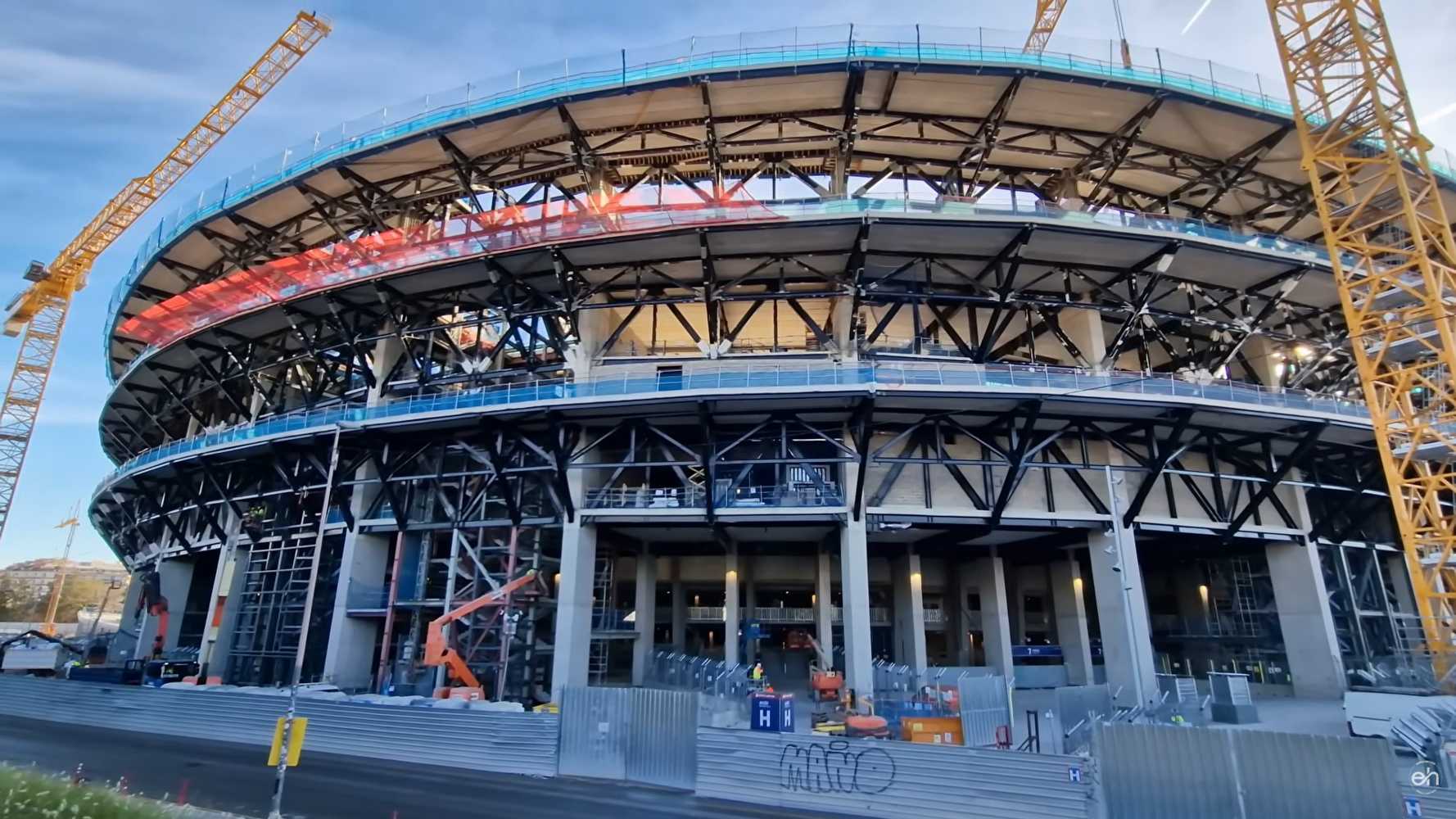

However, the work on the south stand was only a prelude to the full start of FC Barcelona's stadium expansion operations. The work started in full force after the 2022/23 season. In early 2023, it was announced that the main contractor for the works would be Turkish company Limak Construction.
In connection with the construction the club will temporarily move to the Estadi Olímpic Lluís Companys, located about 4 km to the south-east, during the 2023/24 season. As it can hold noticeably fewer spectators than Camp Nou (less than 56,000), for a significant number of club pass holders this will mean that they will have to cancel their season tickets.

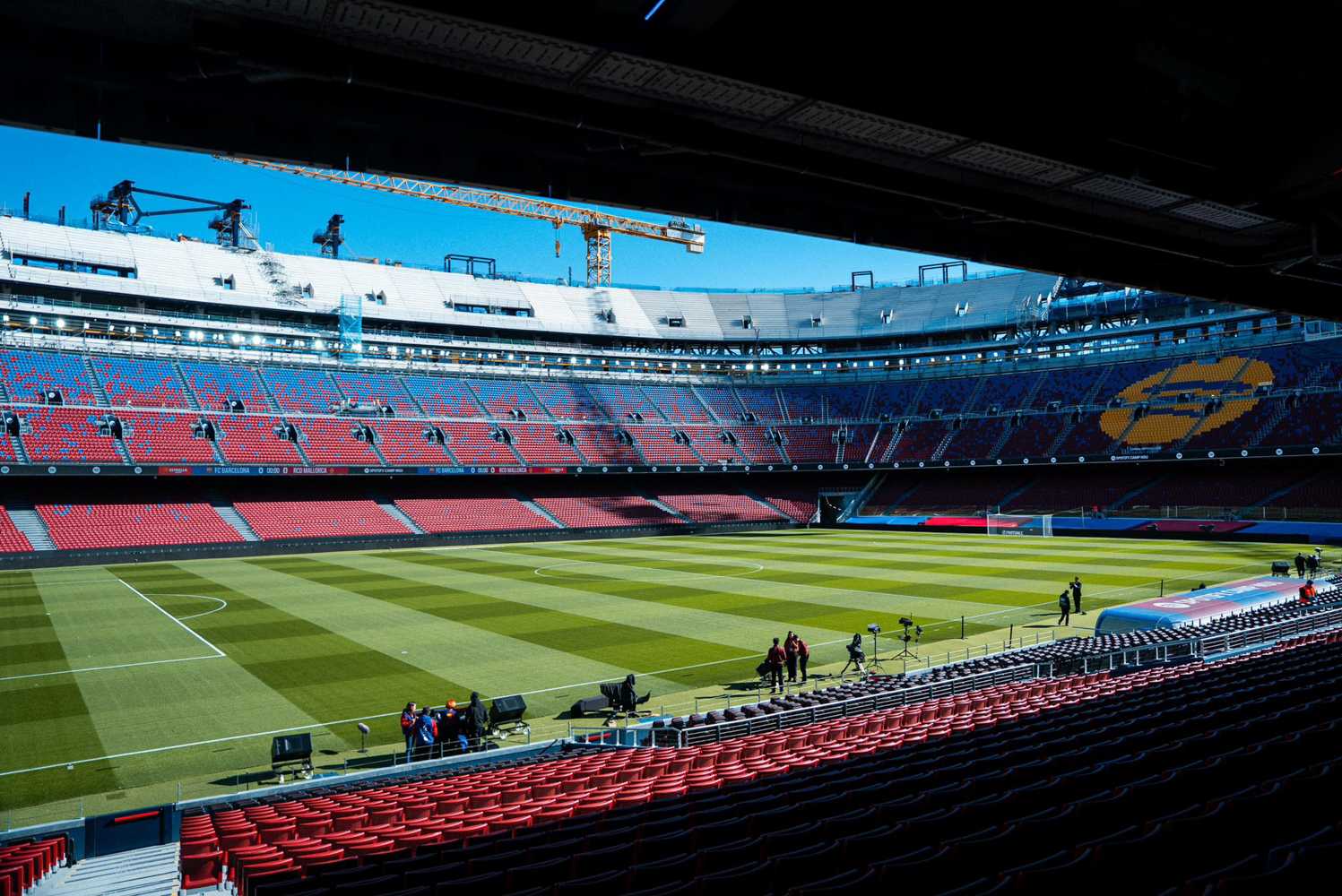

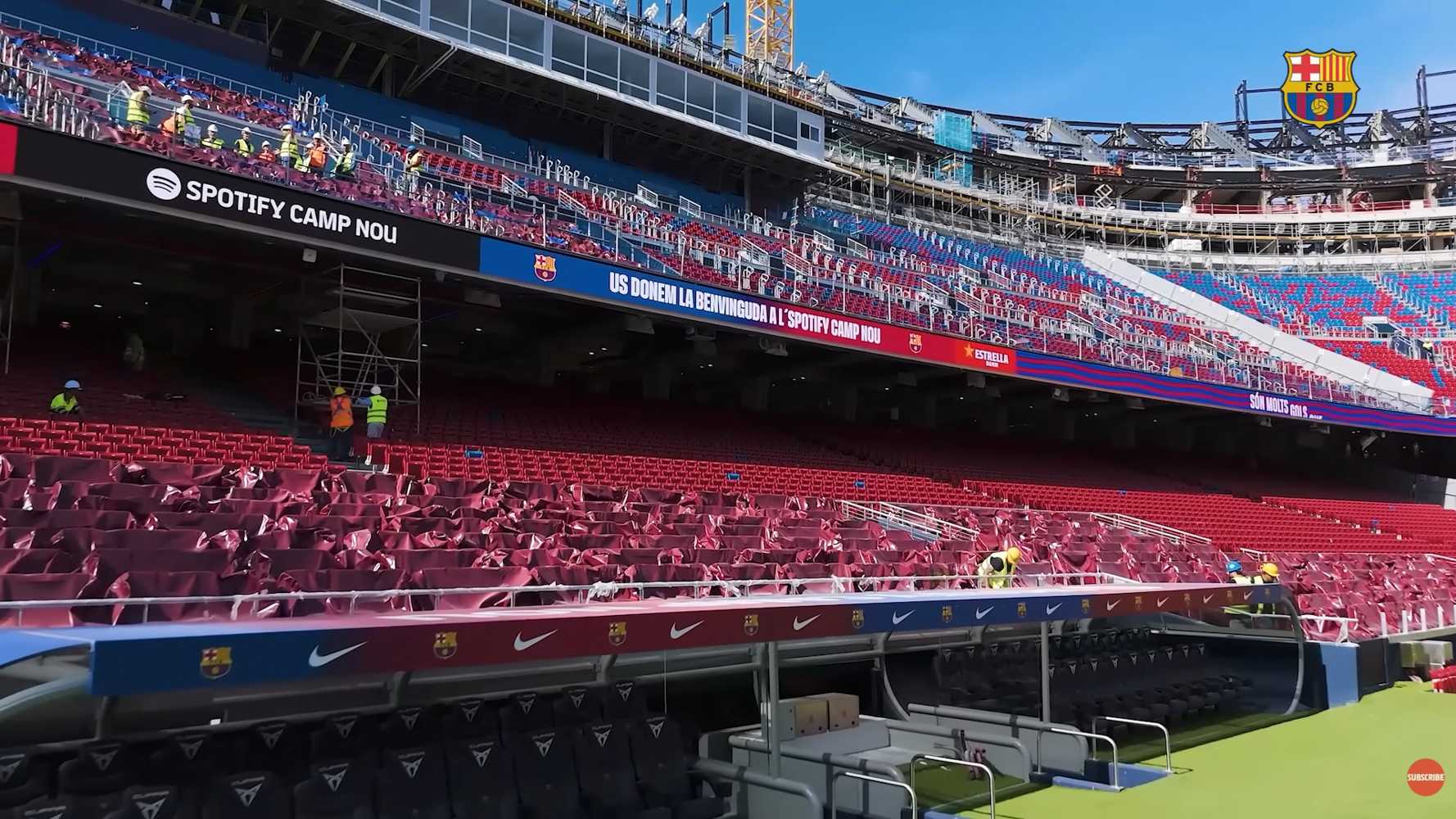

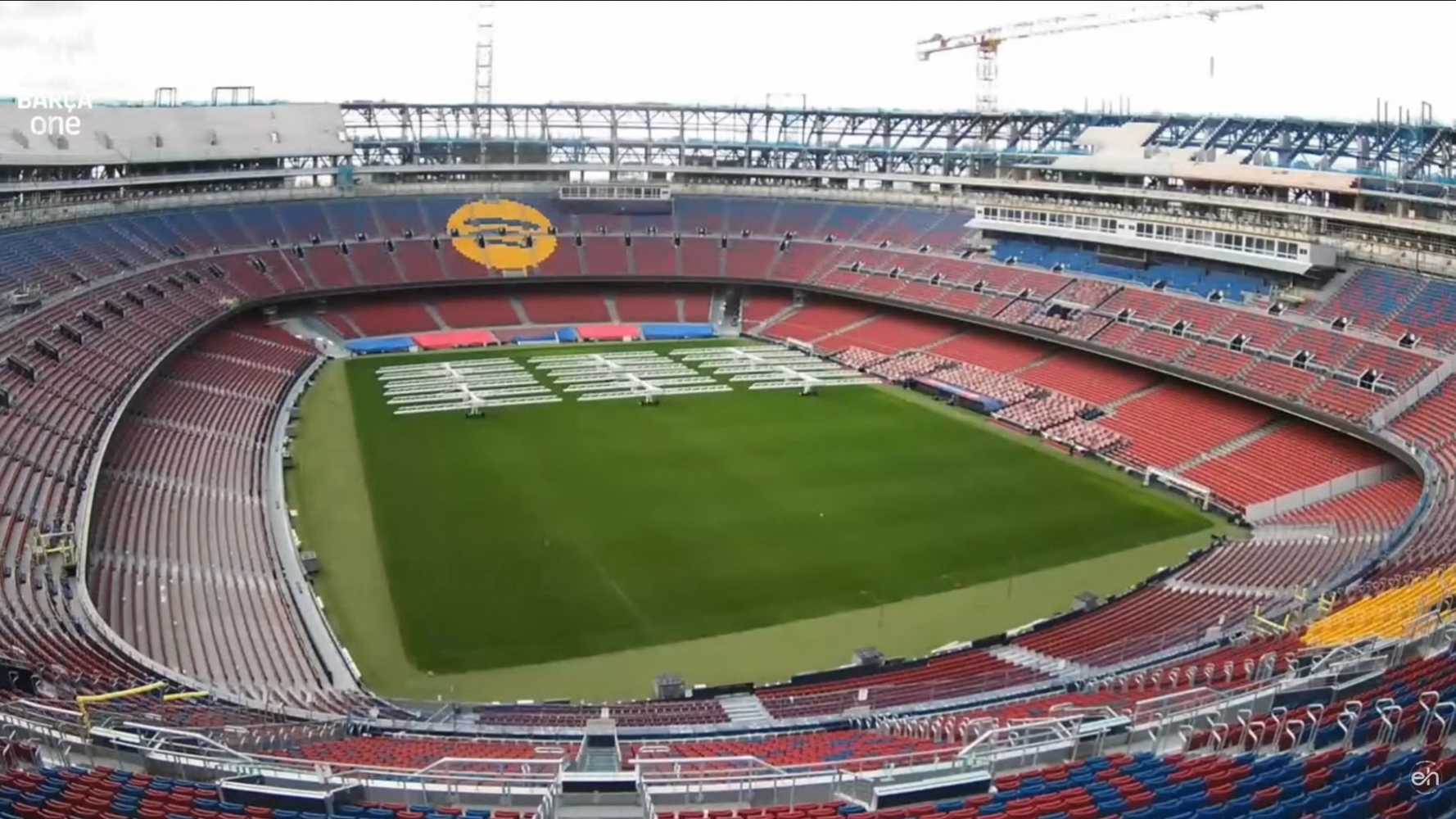

FC Barcelona will return to its stadium in the 2024/25 season, although its capacity is initially expected to be severely limited. Full completion of expansion work at Camp Nou is scheduled for 2026.
Advertisement

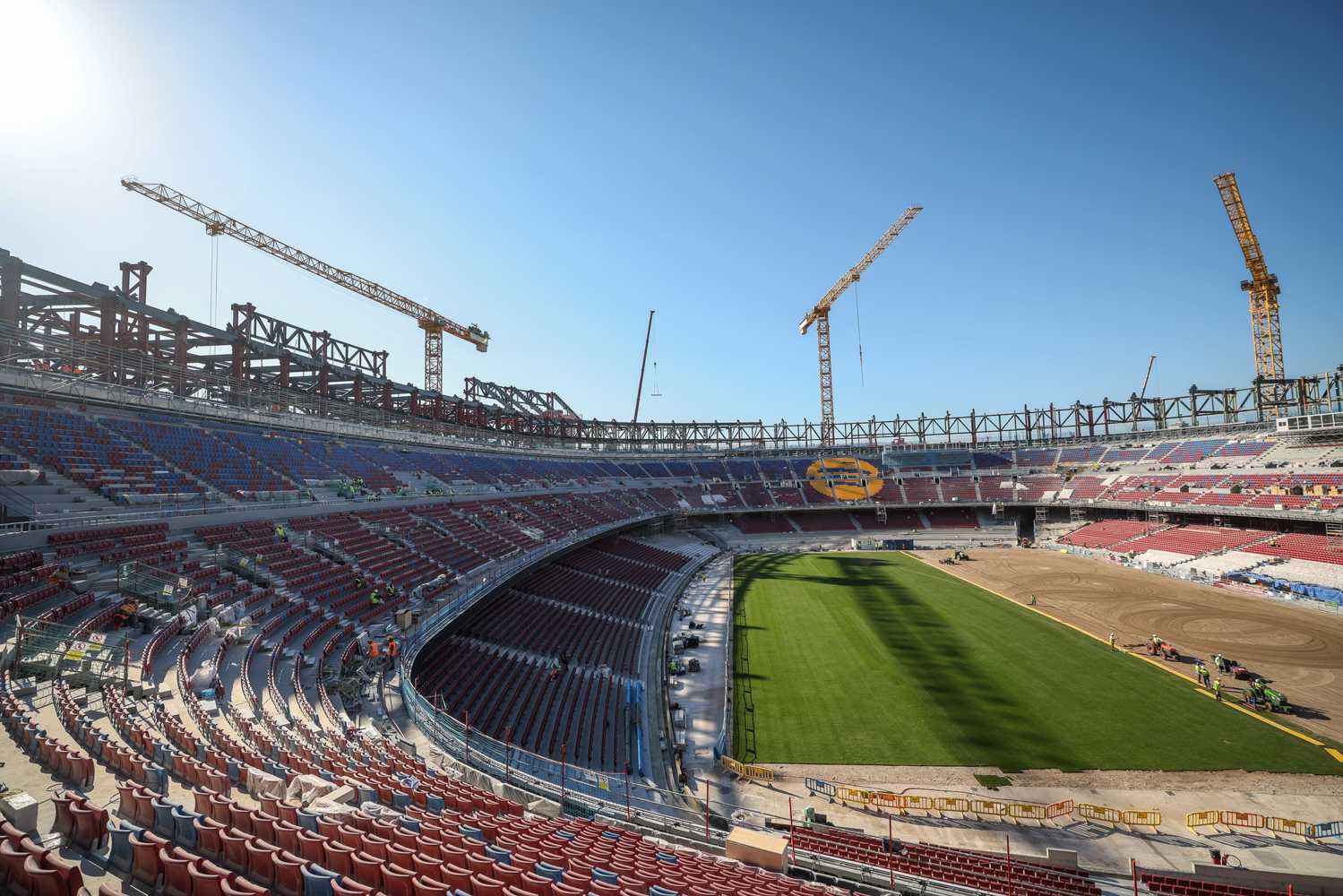

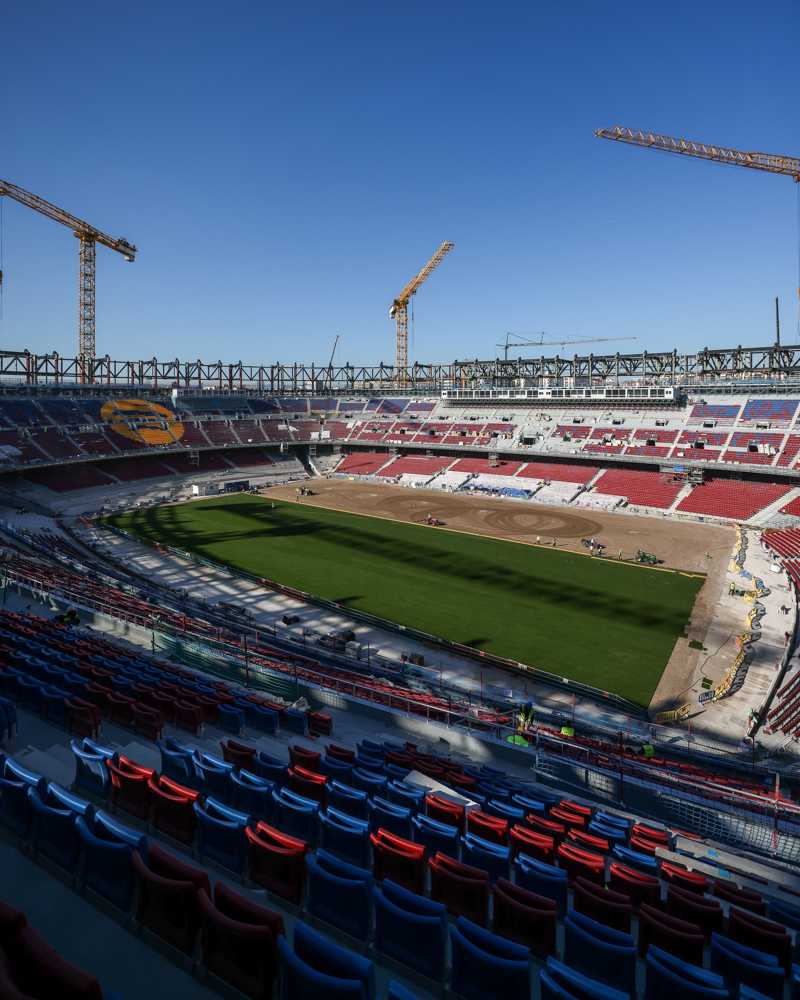

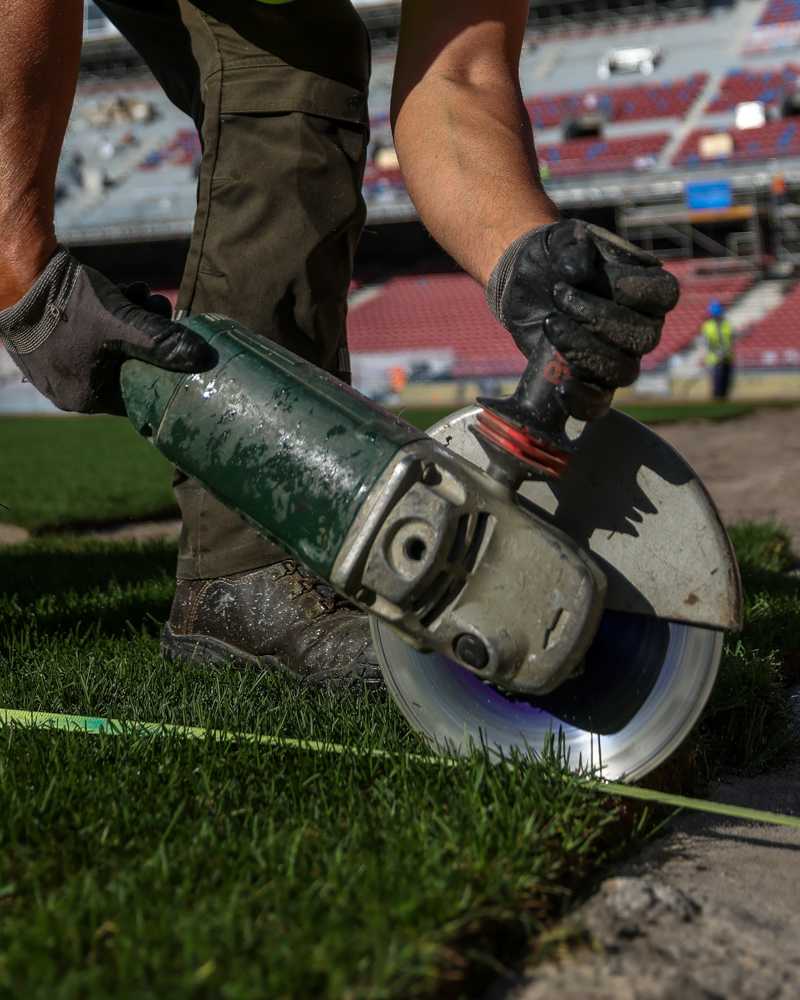

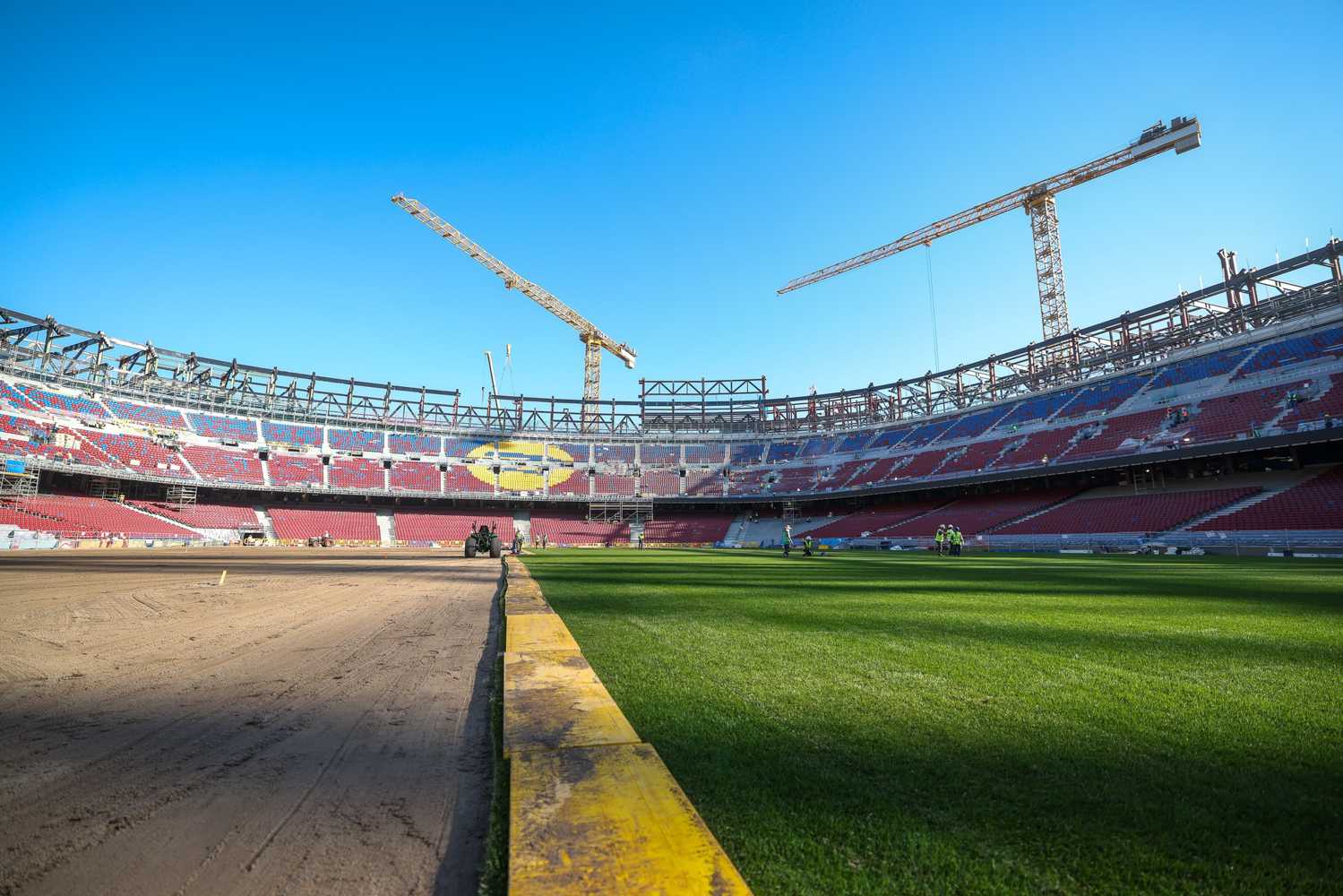

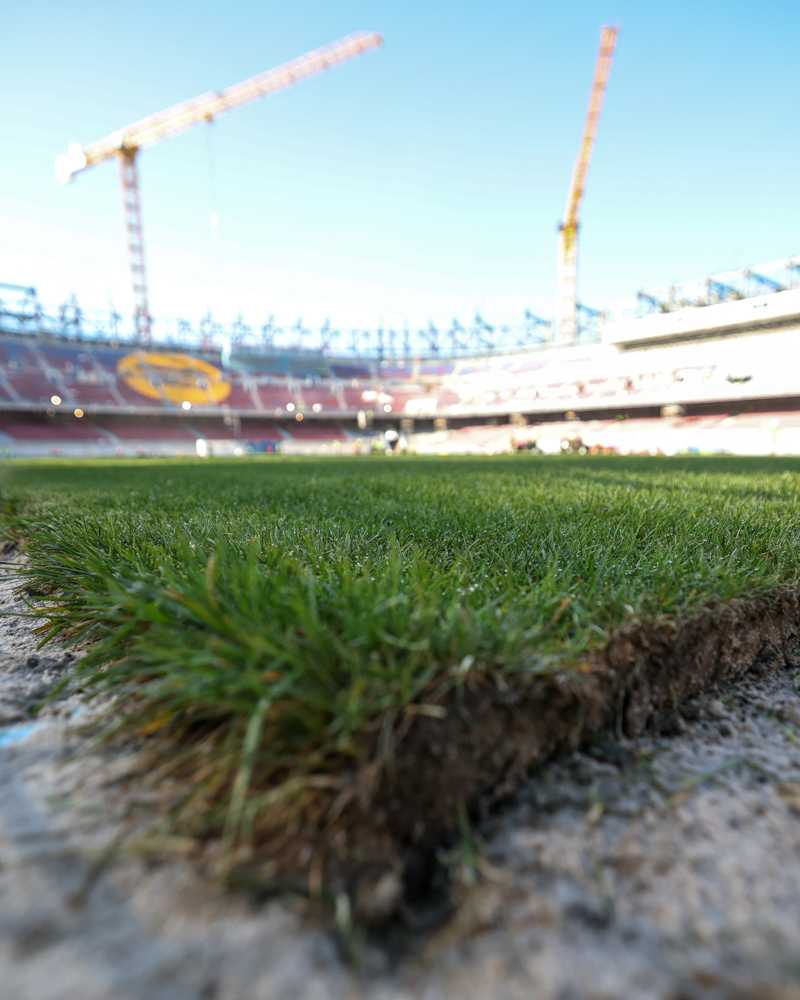

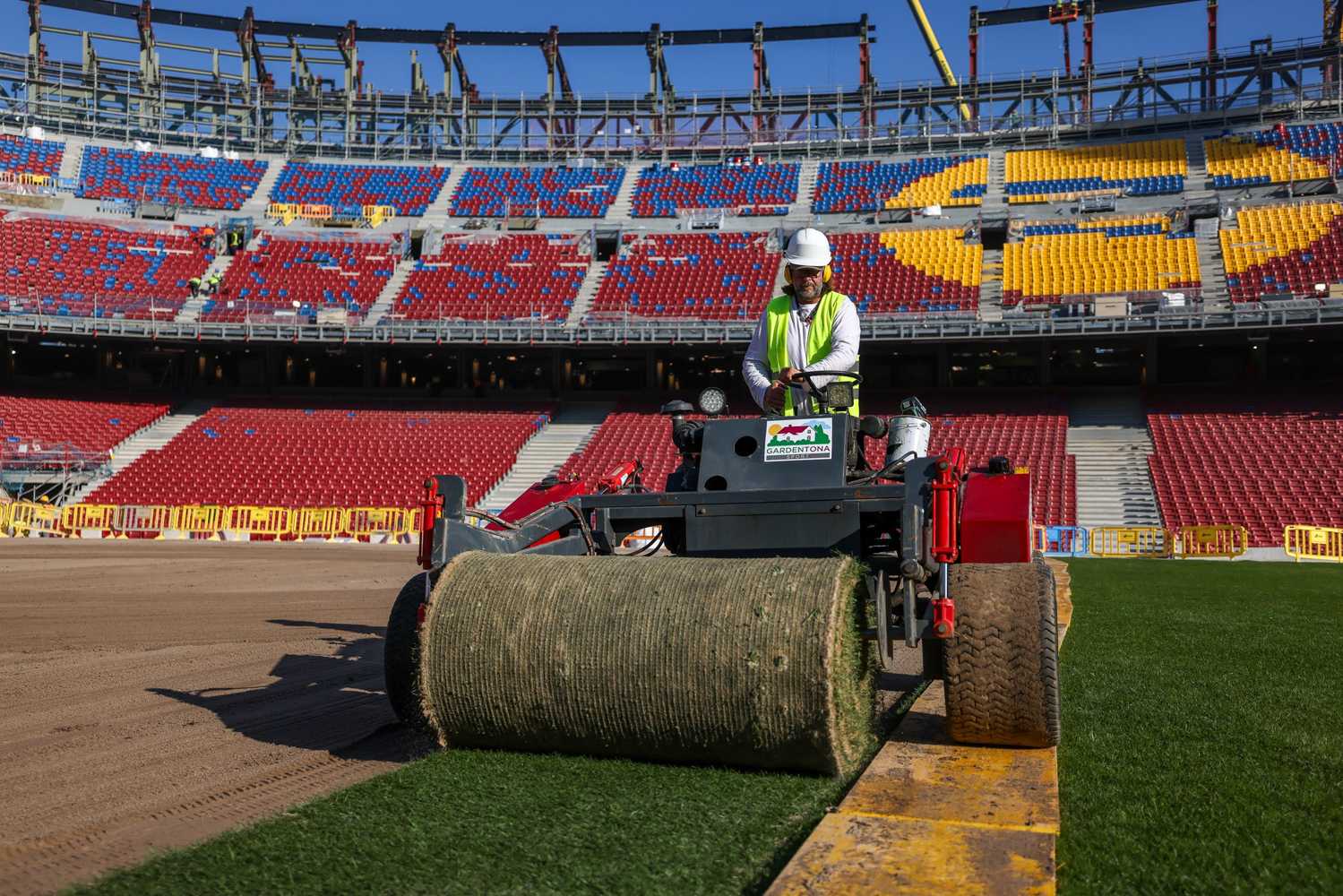

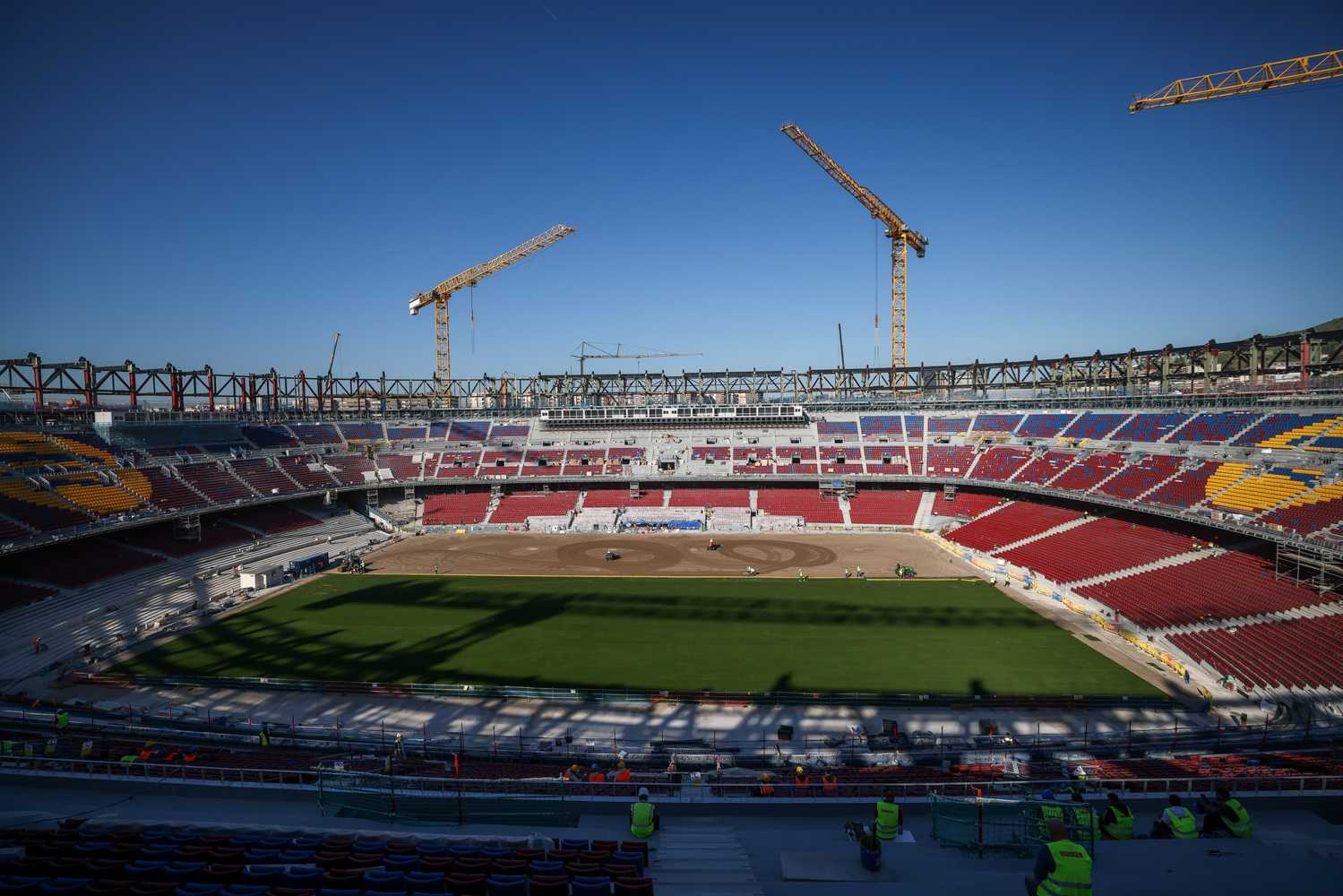

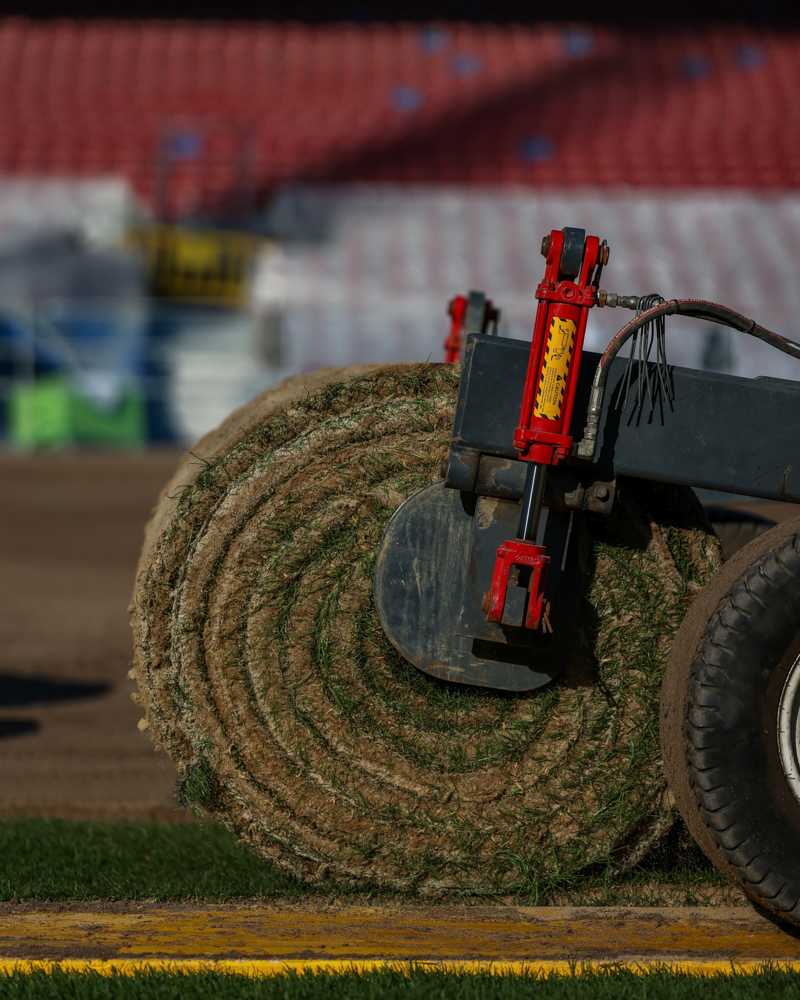

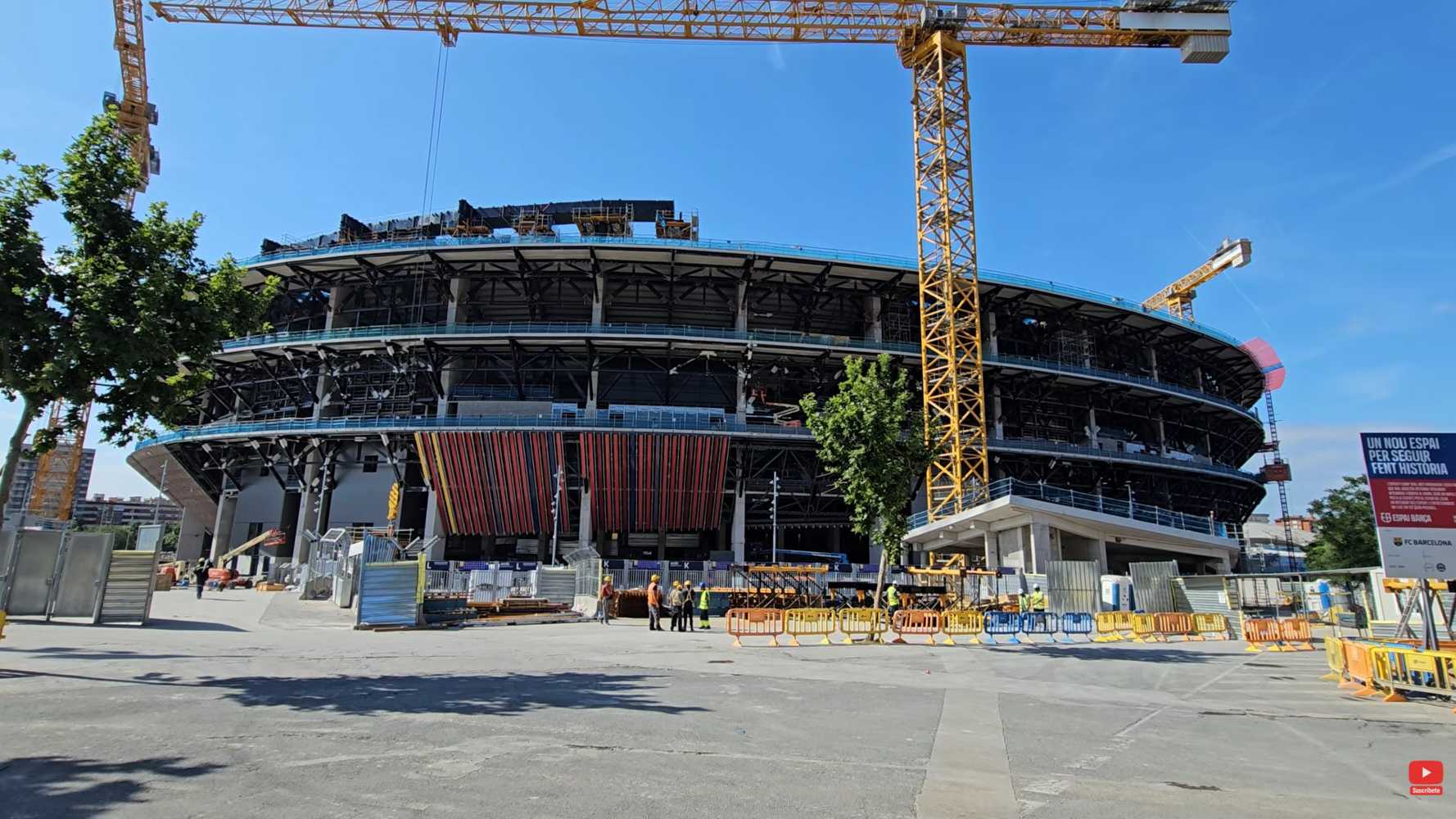

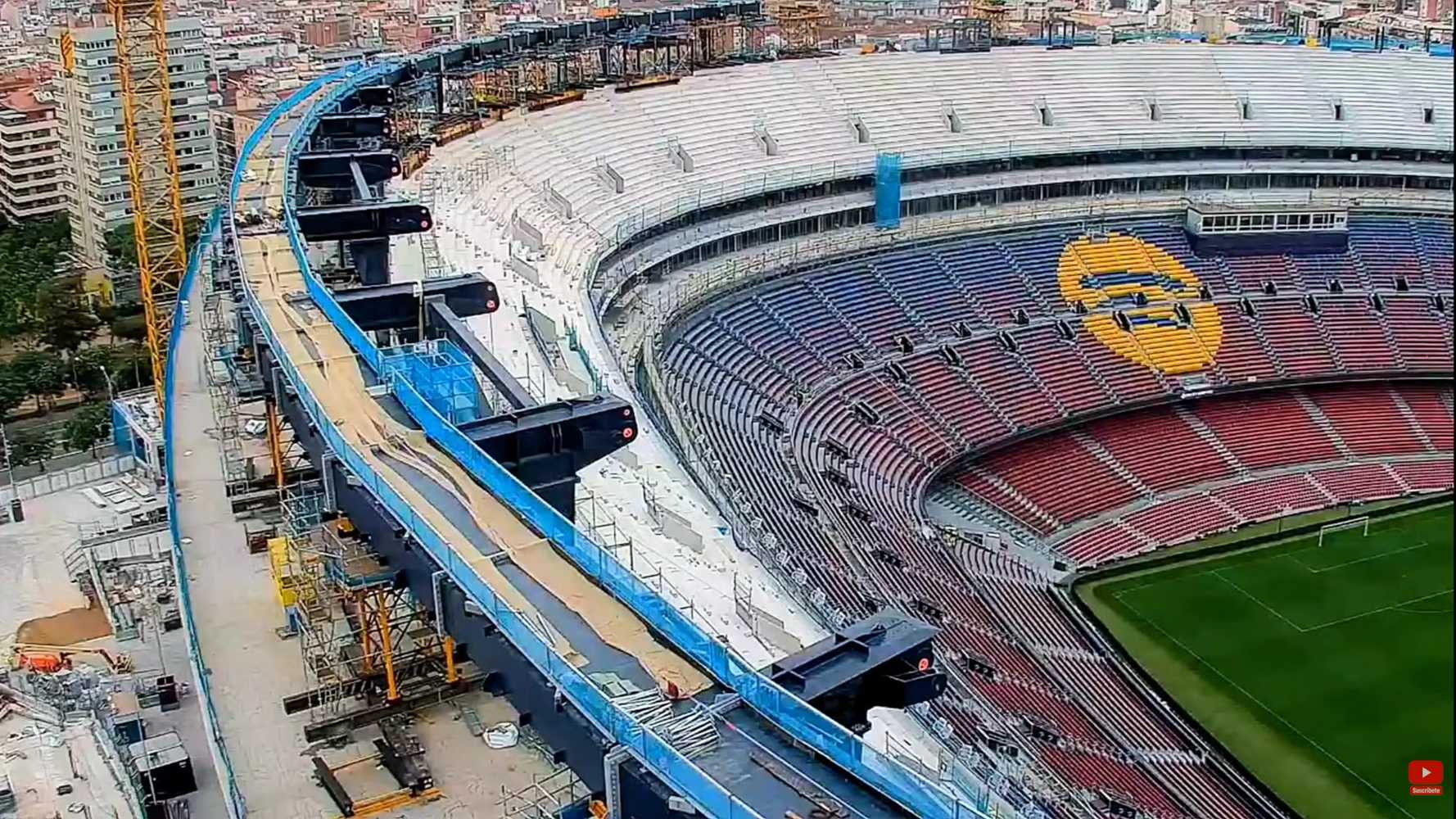

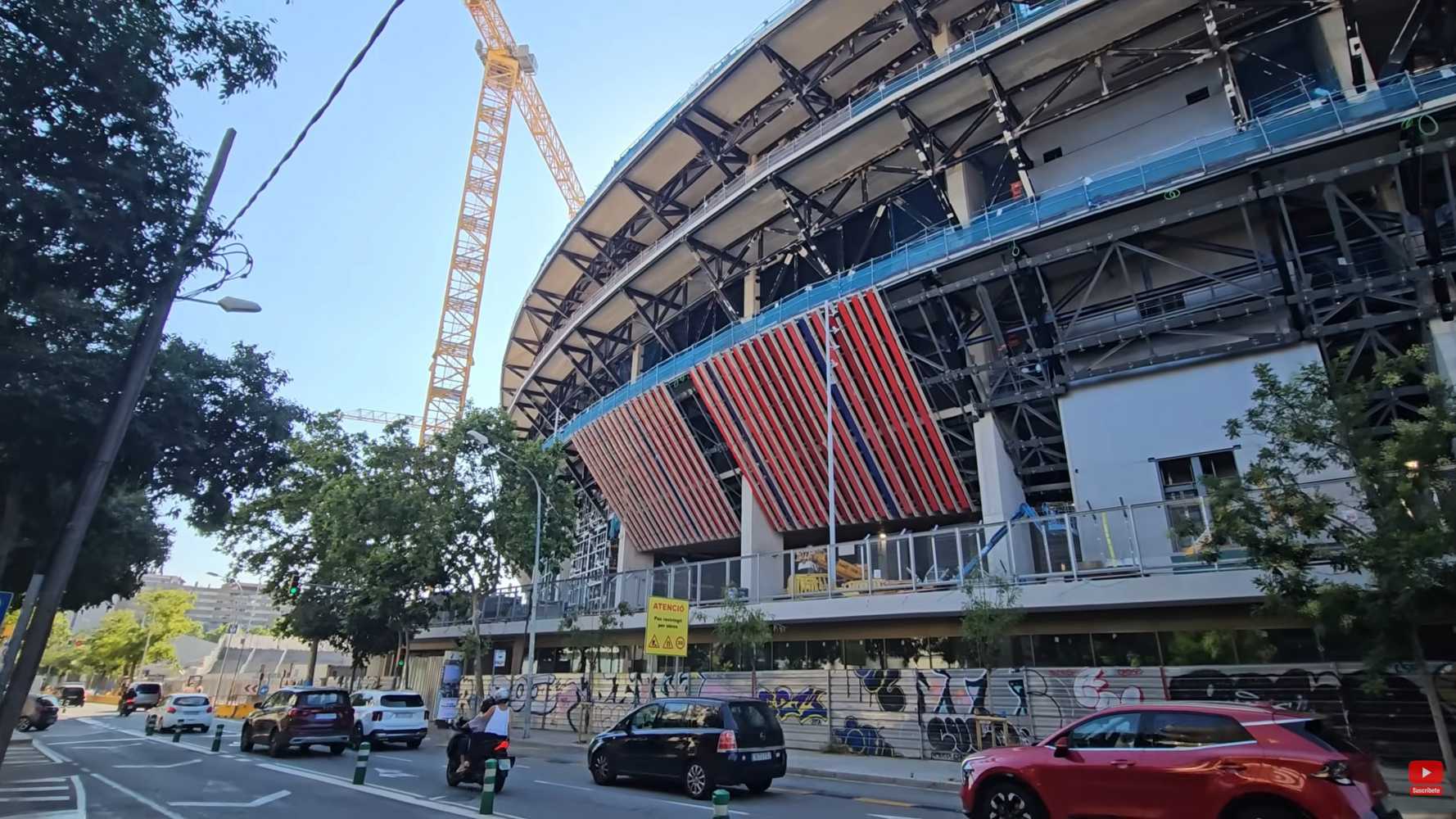

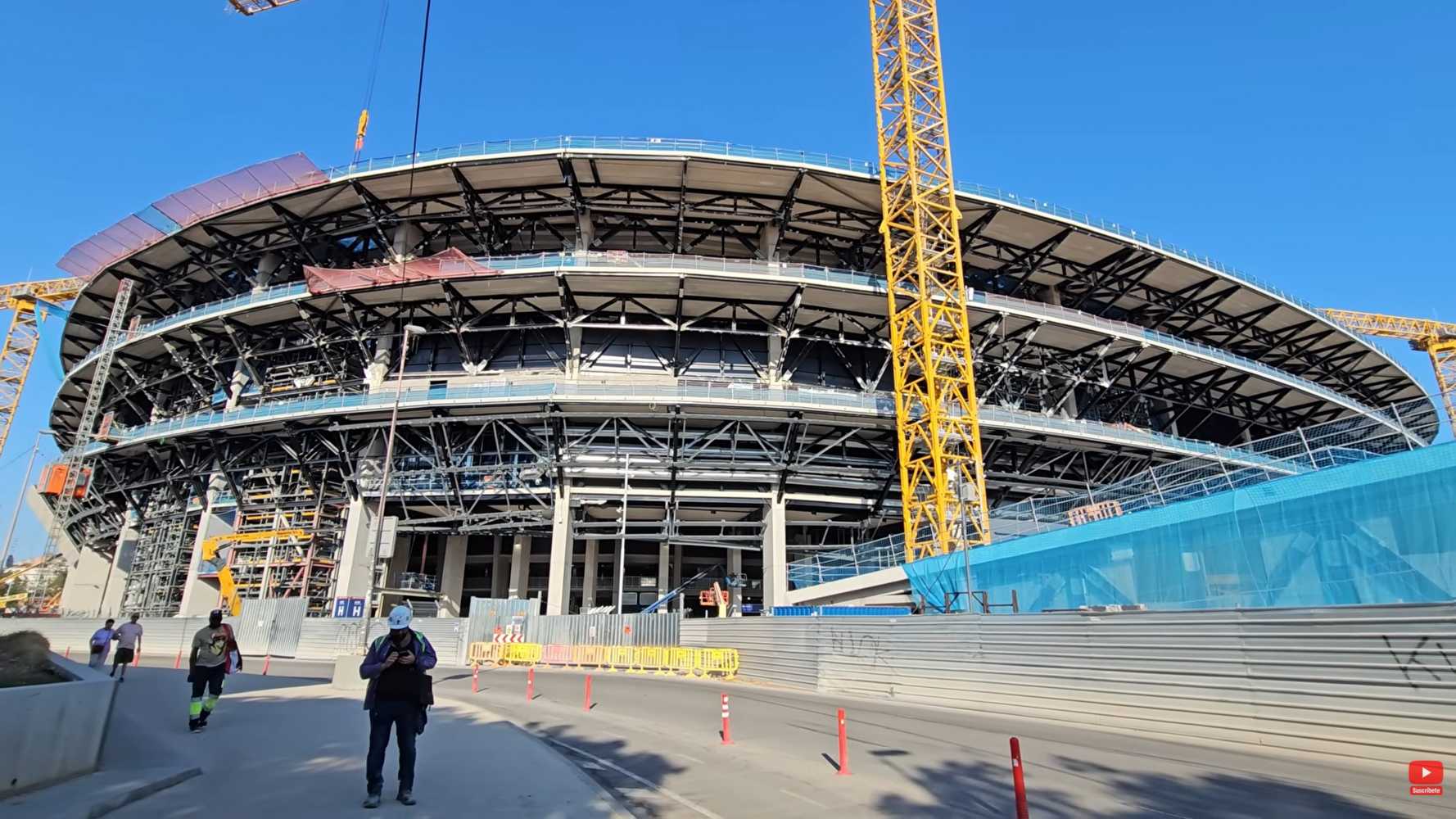

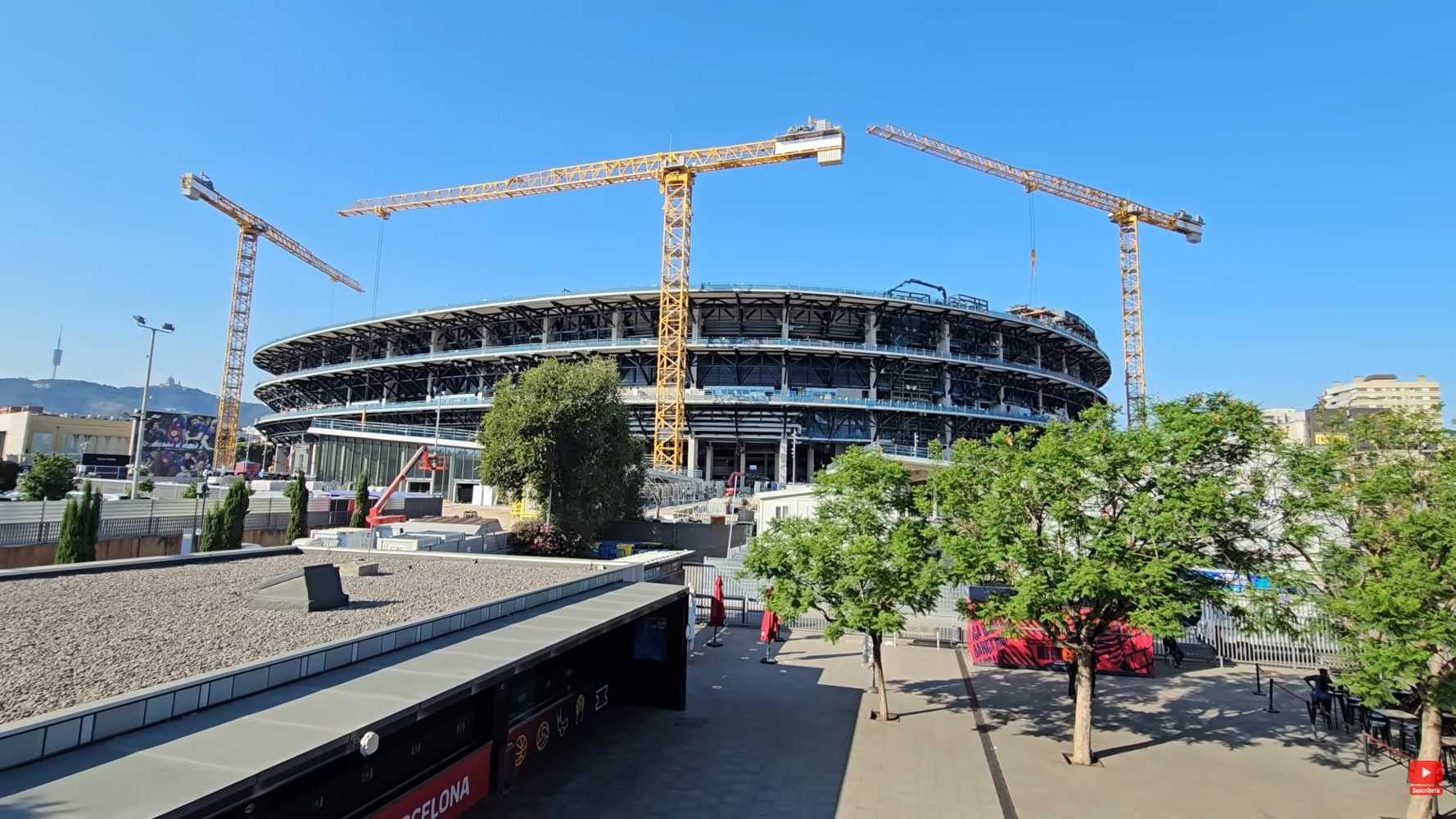

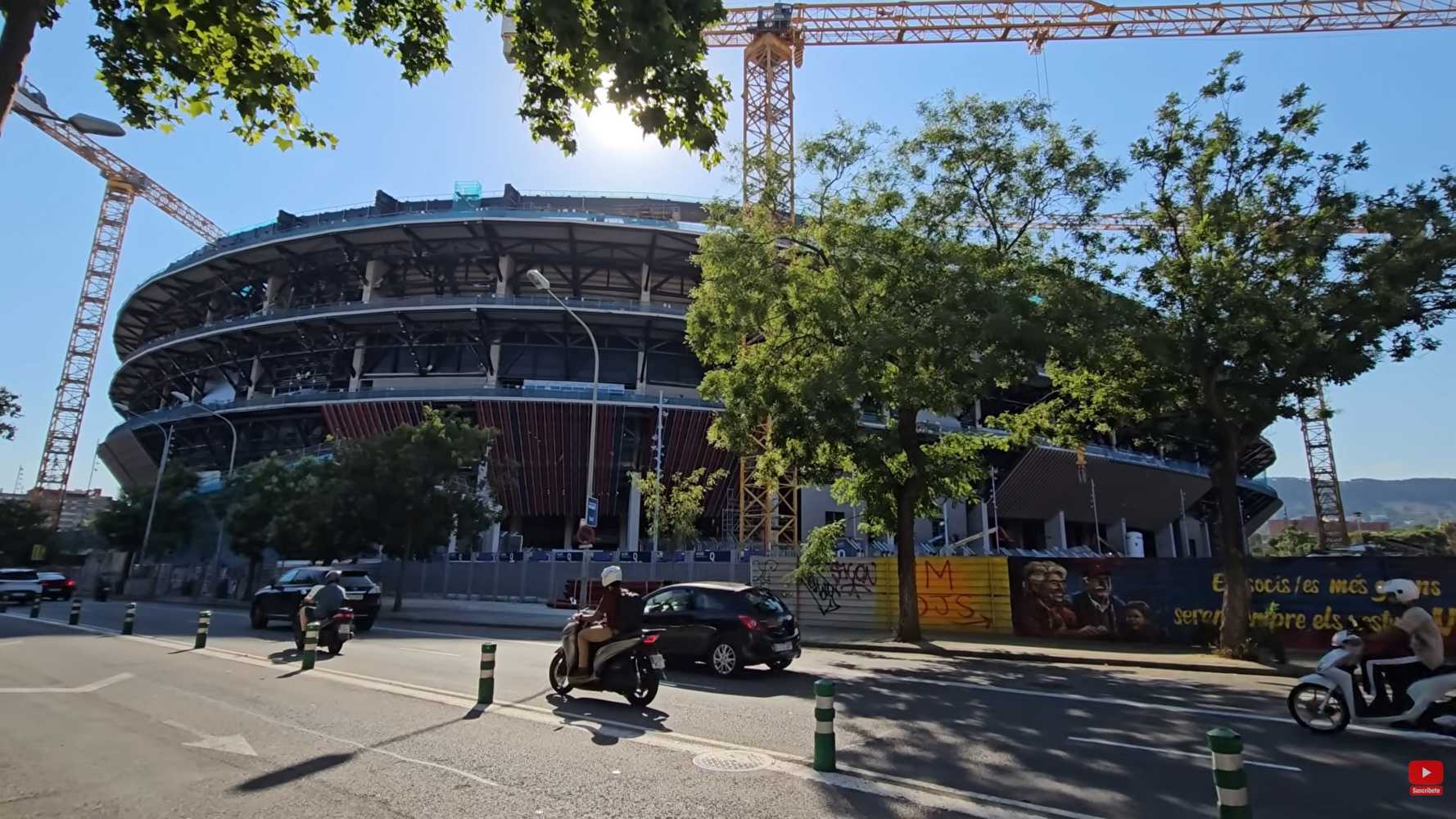

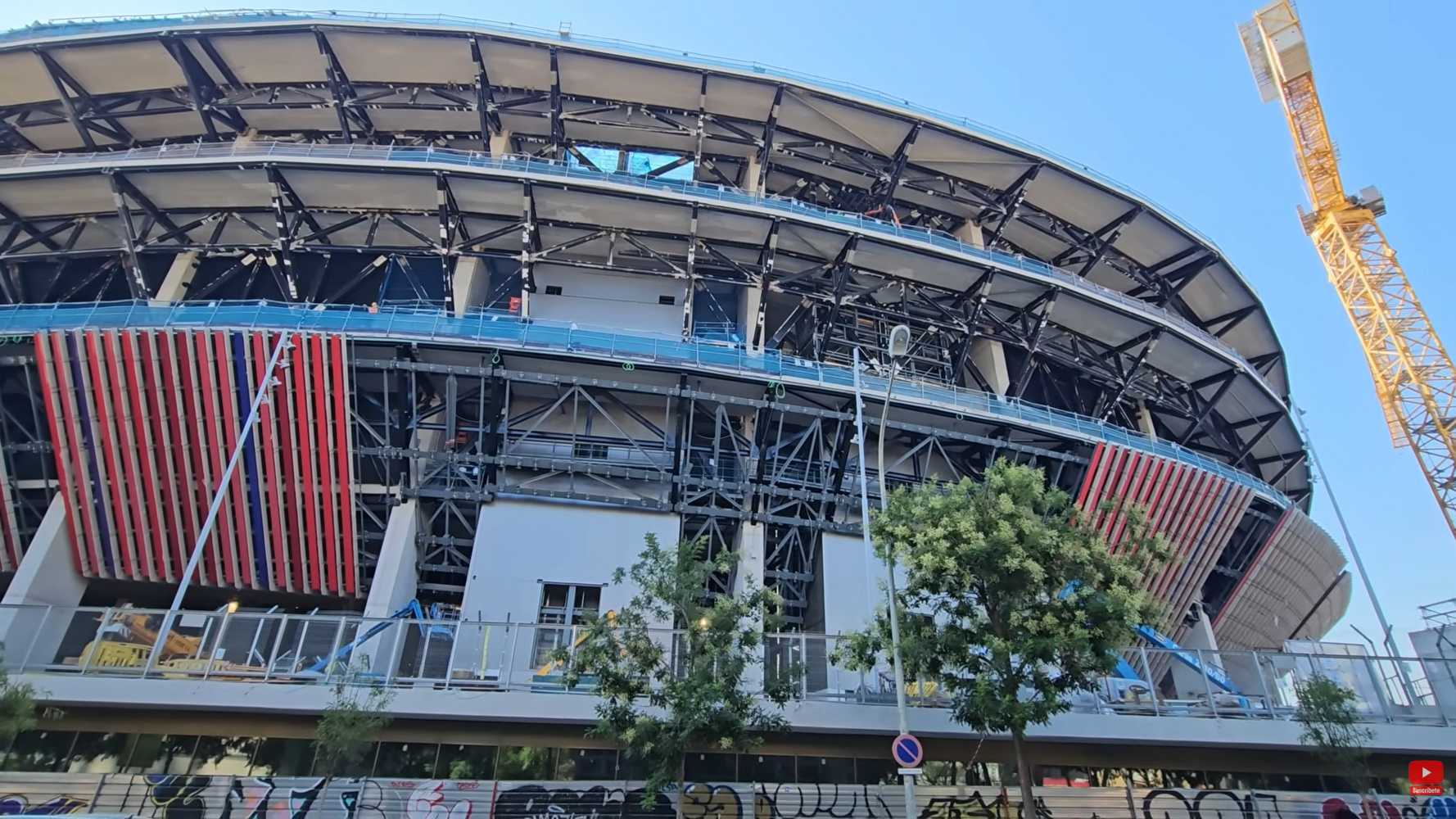

Pictures
-

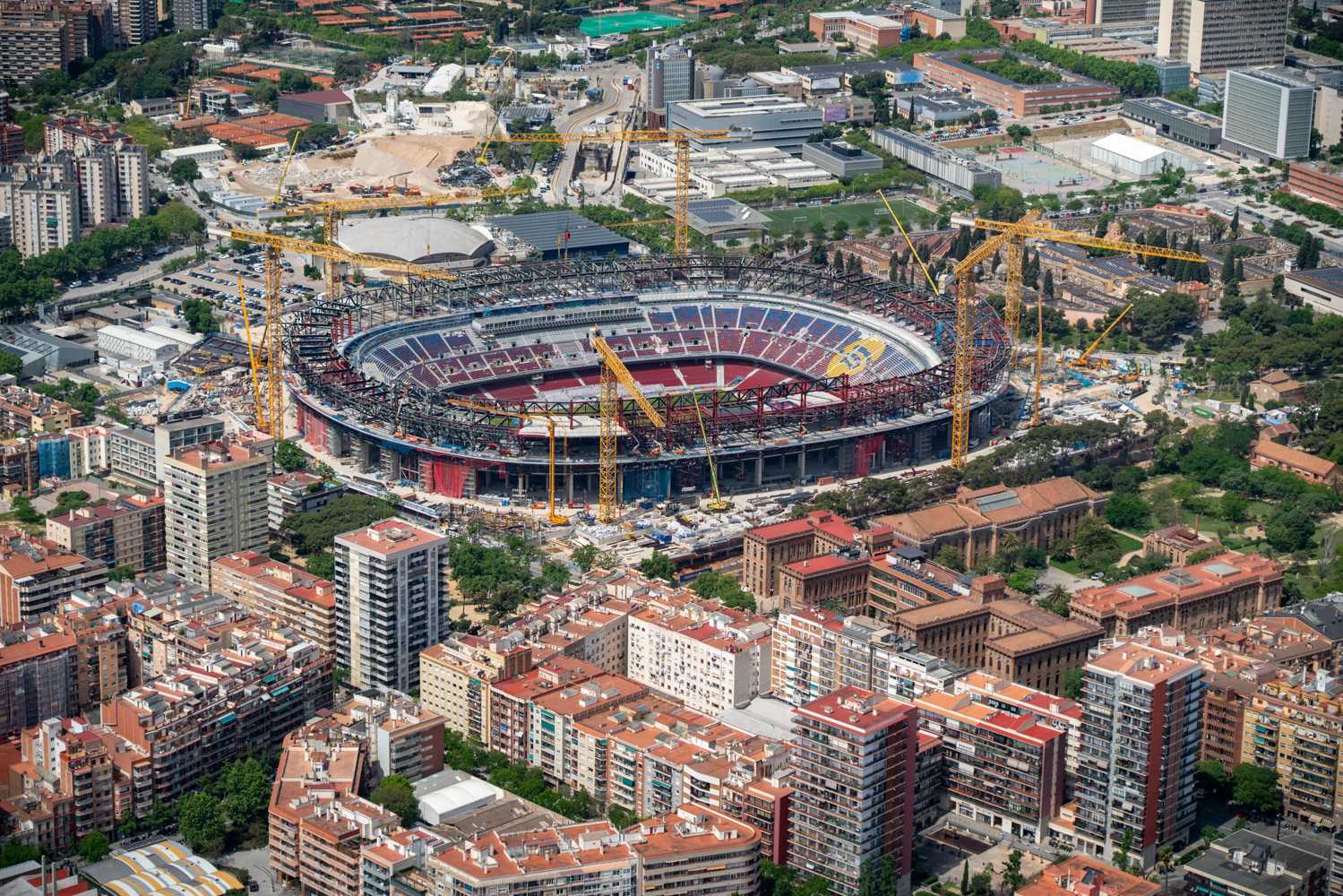

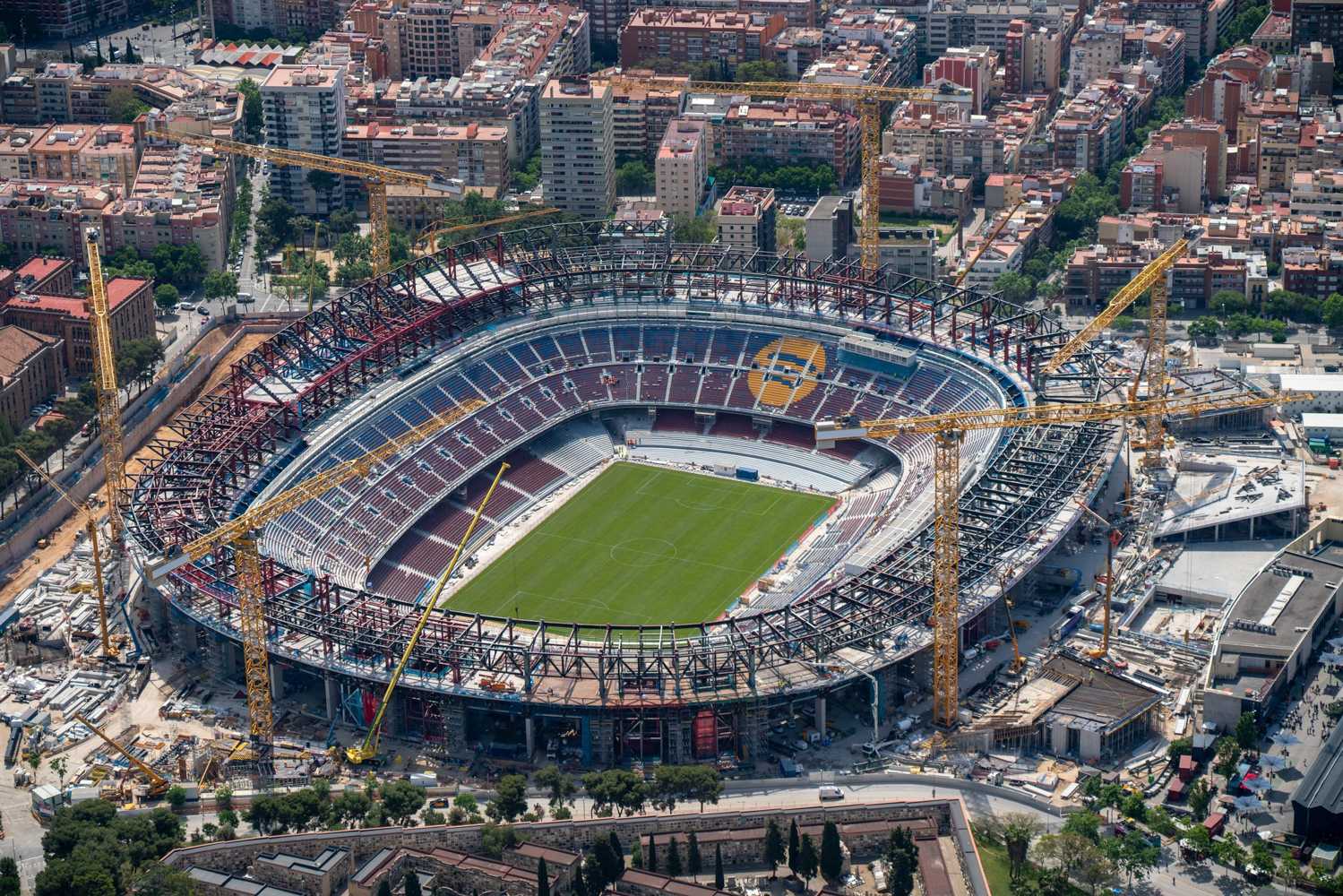

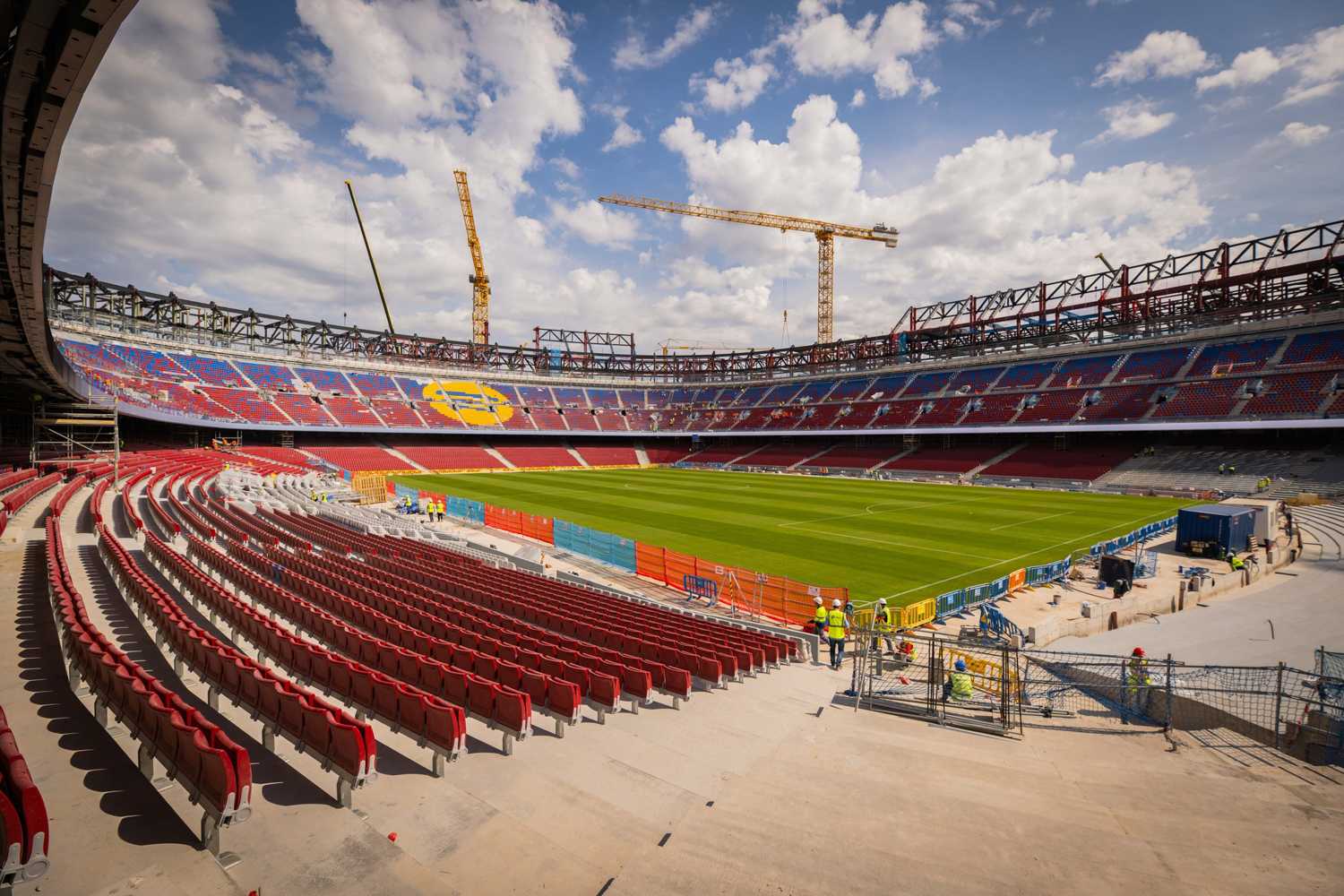

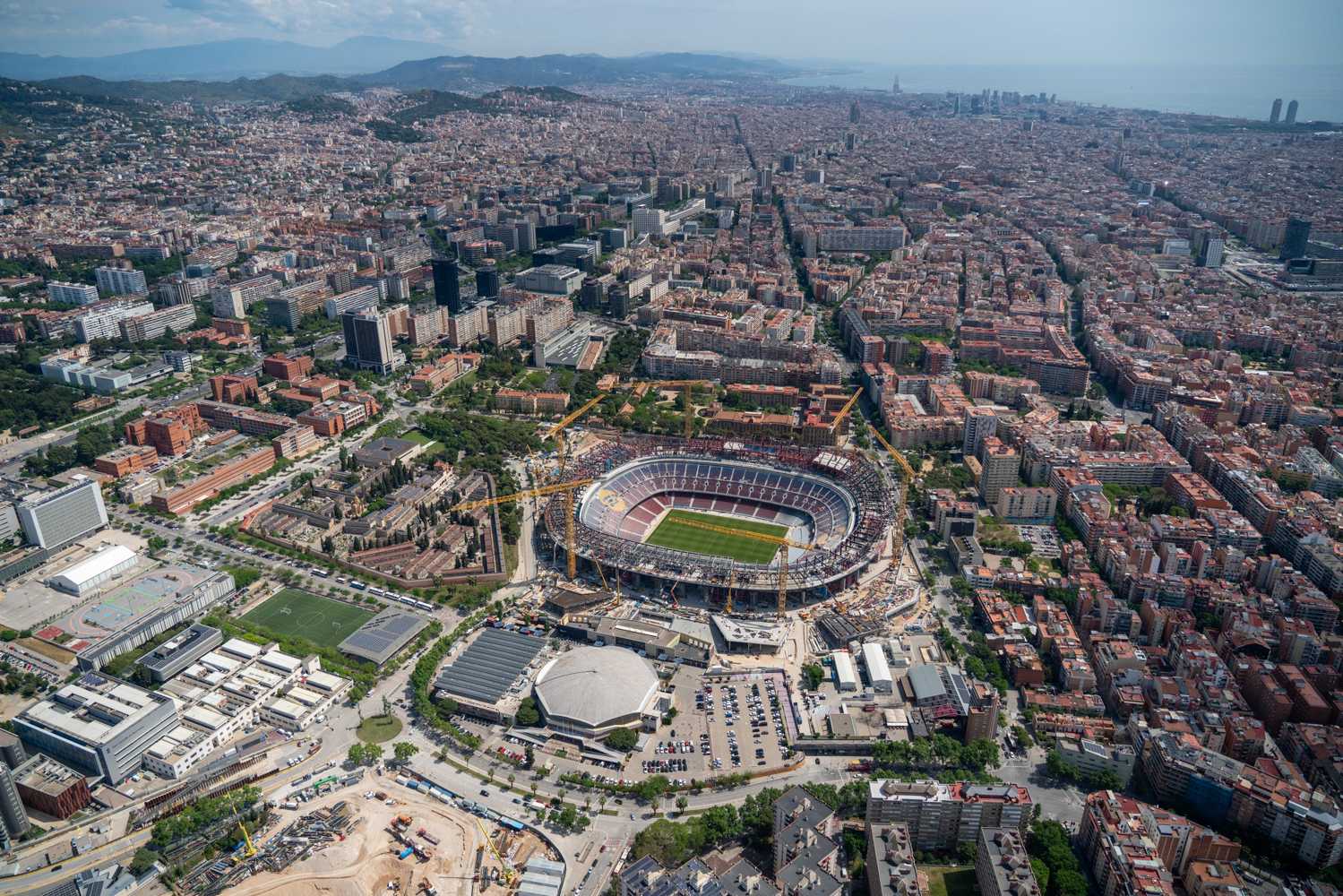

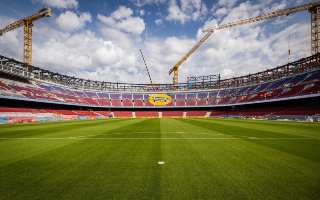

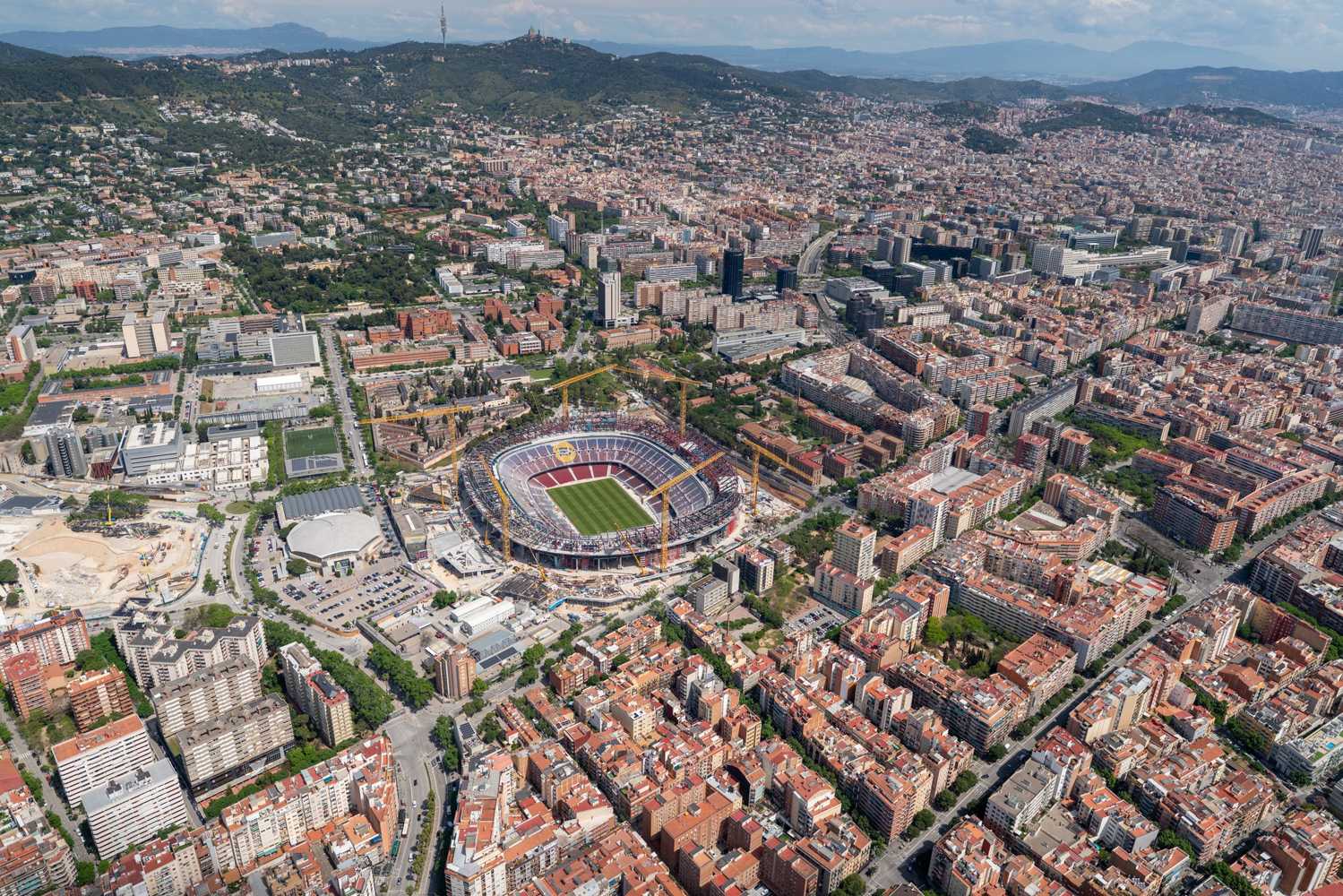

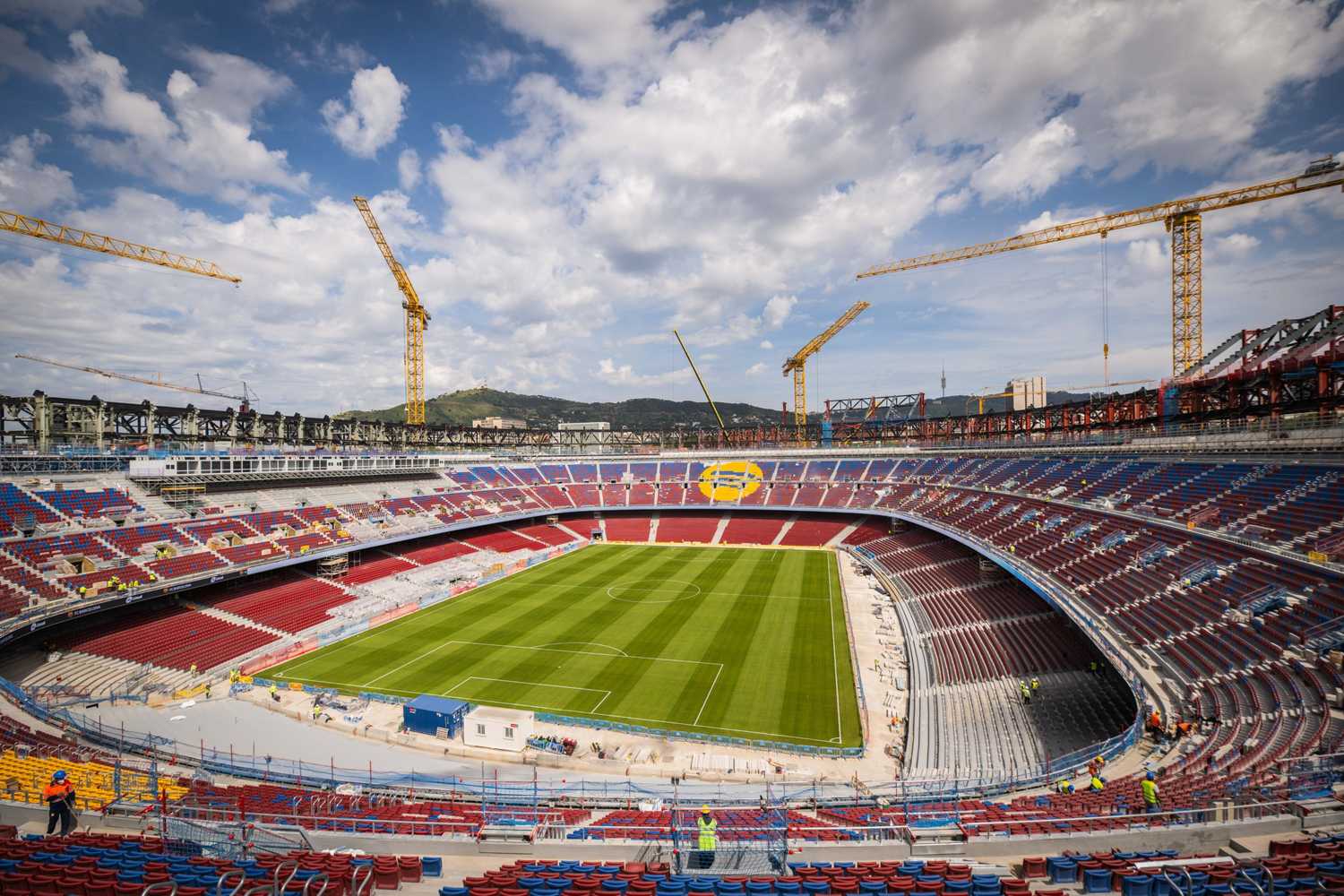

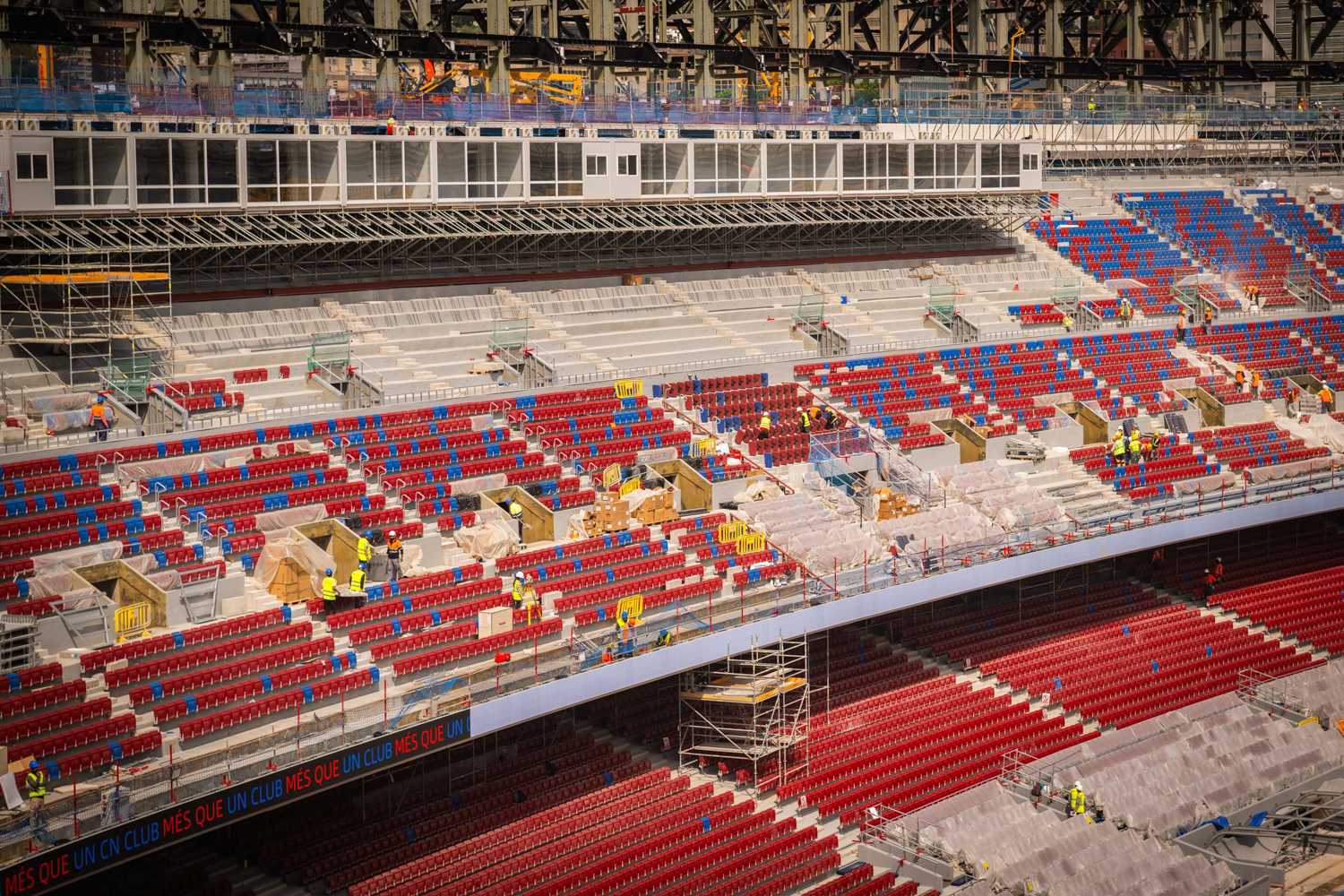

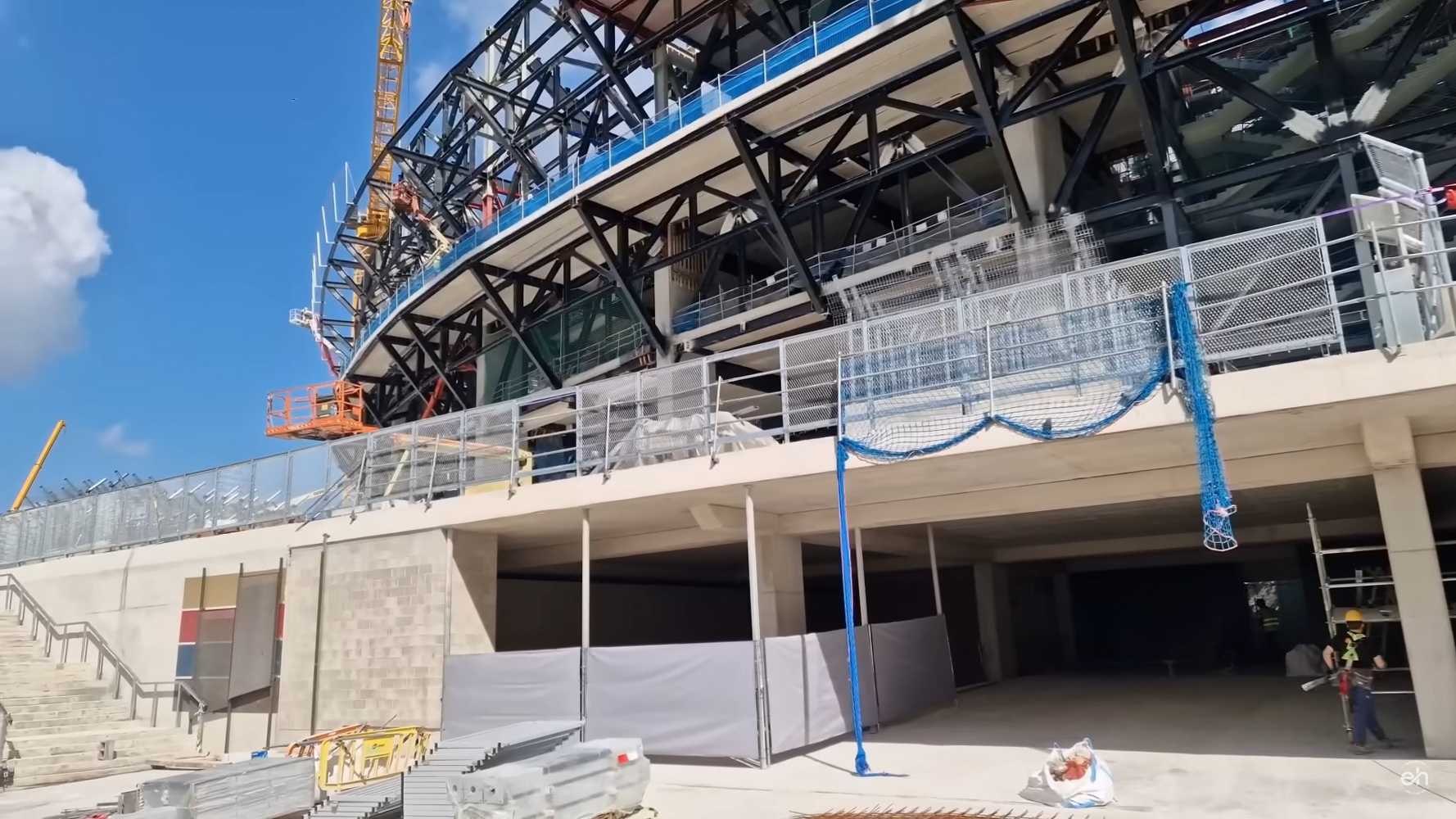

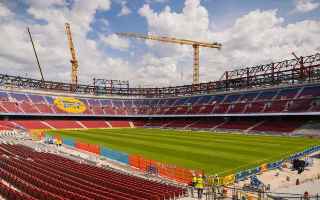

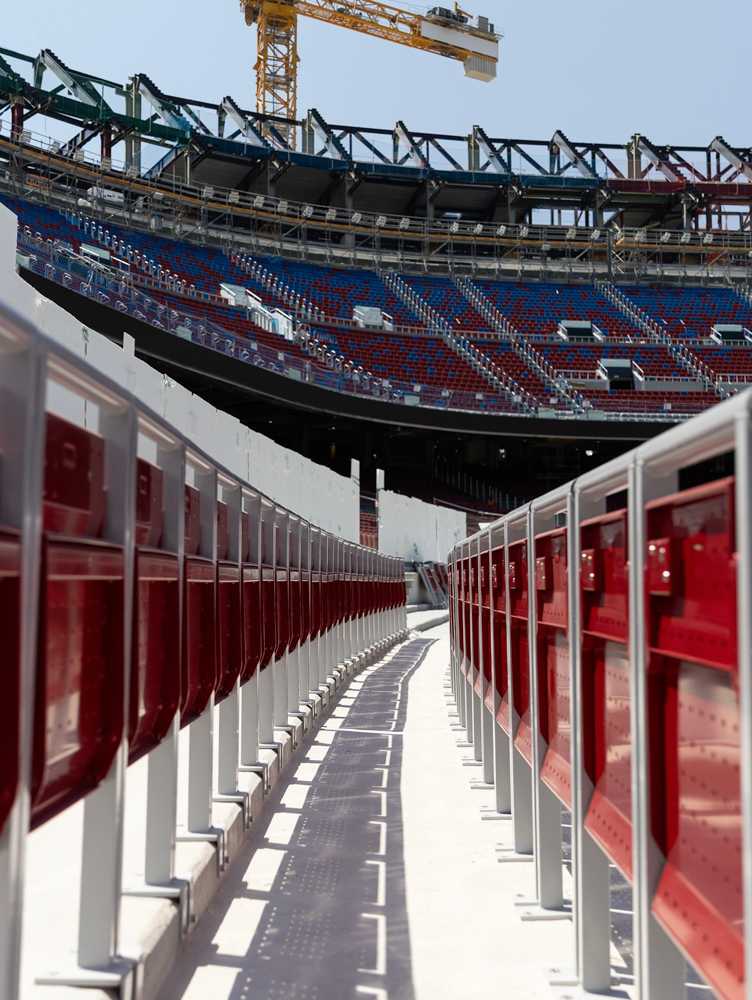

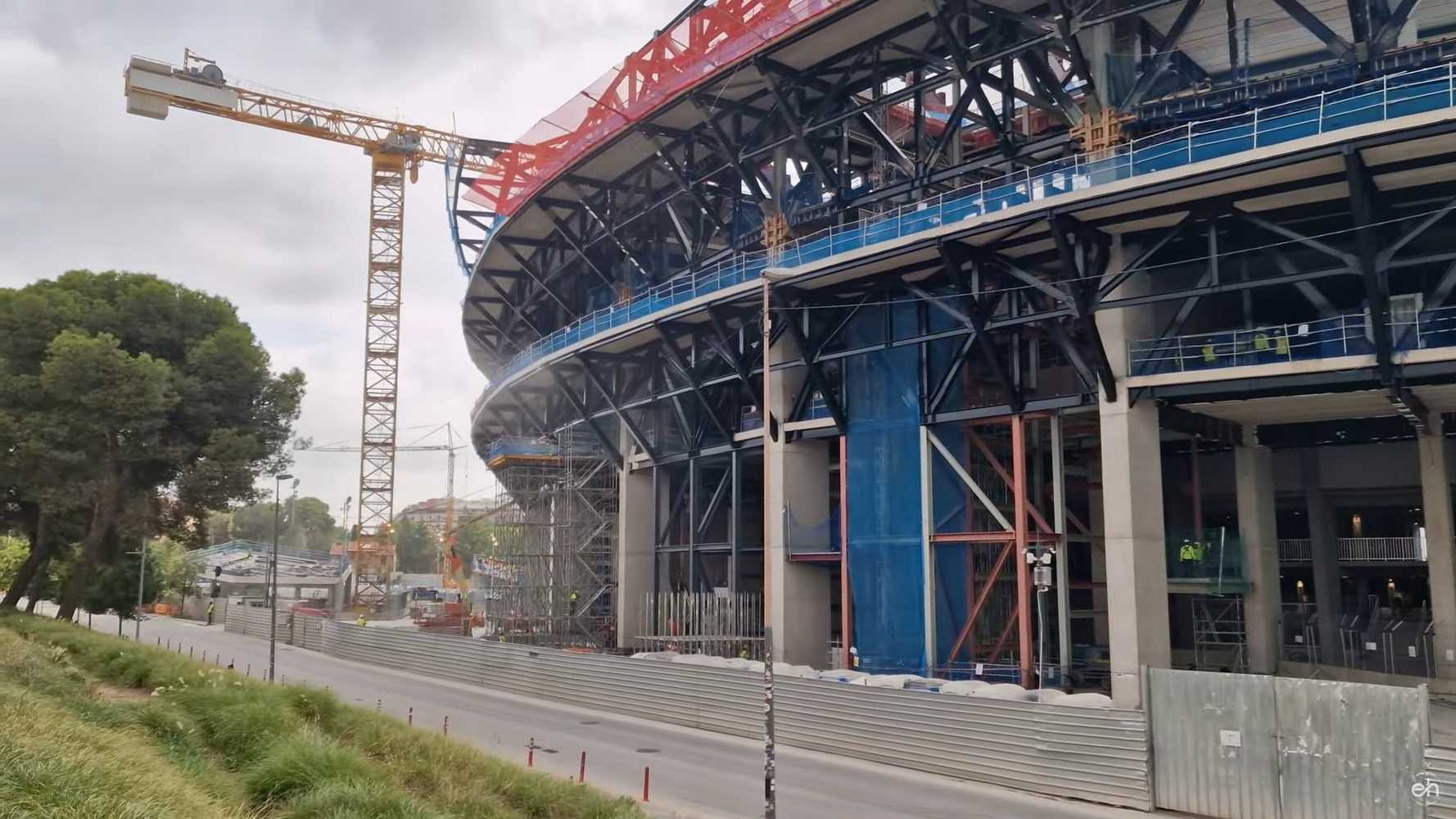

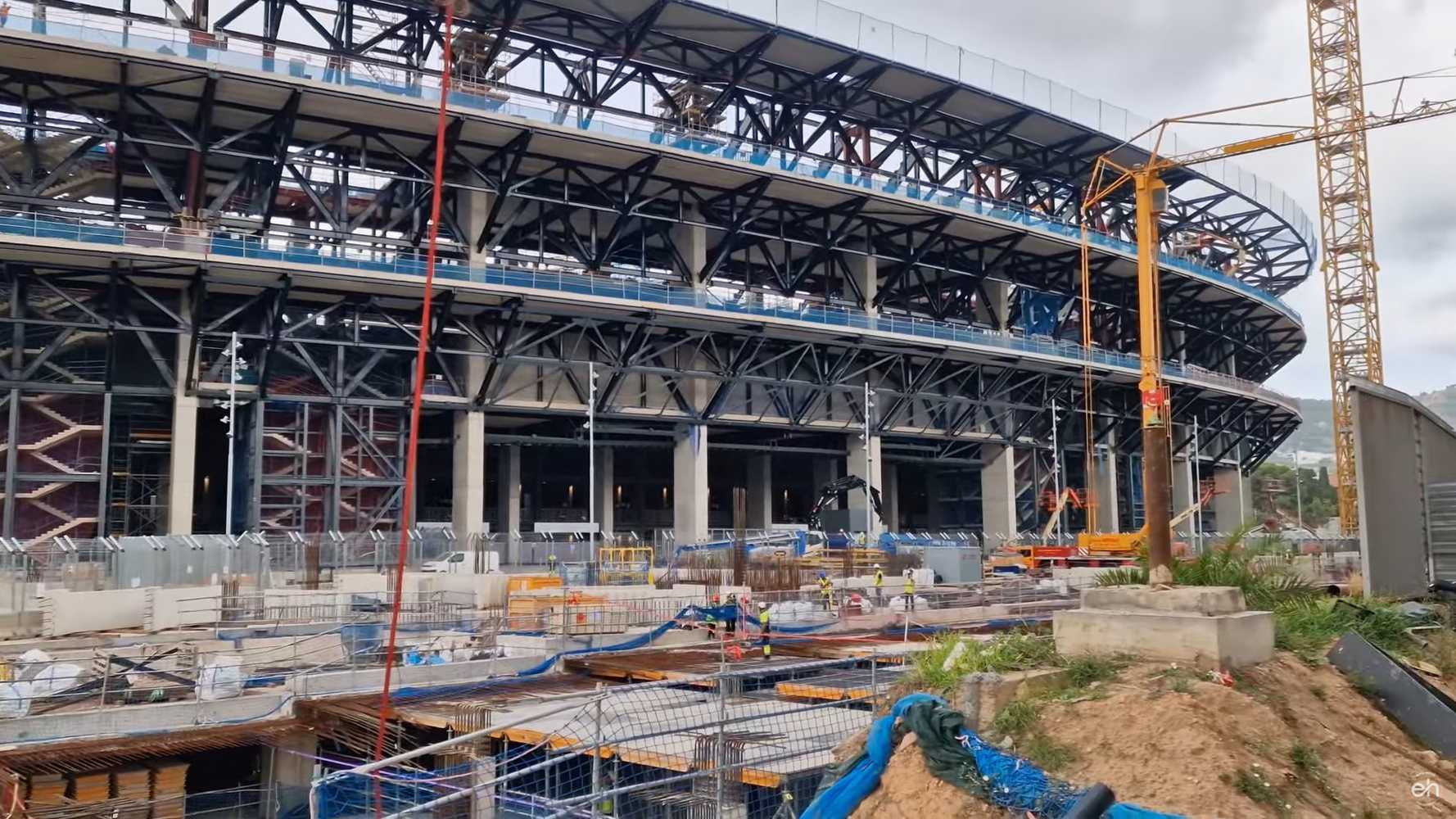

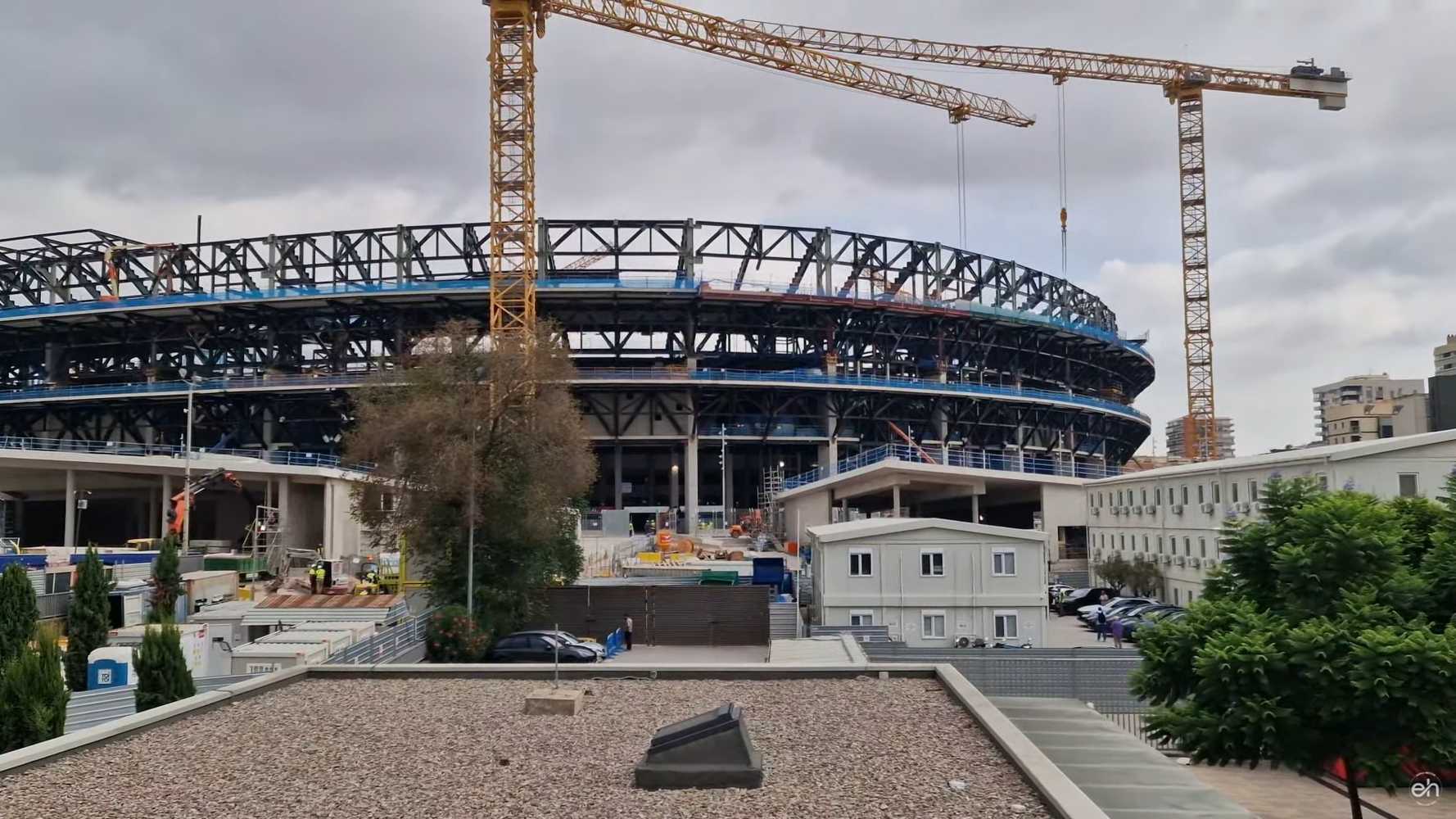

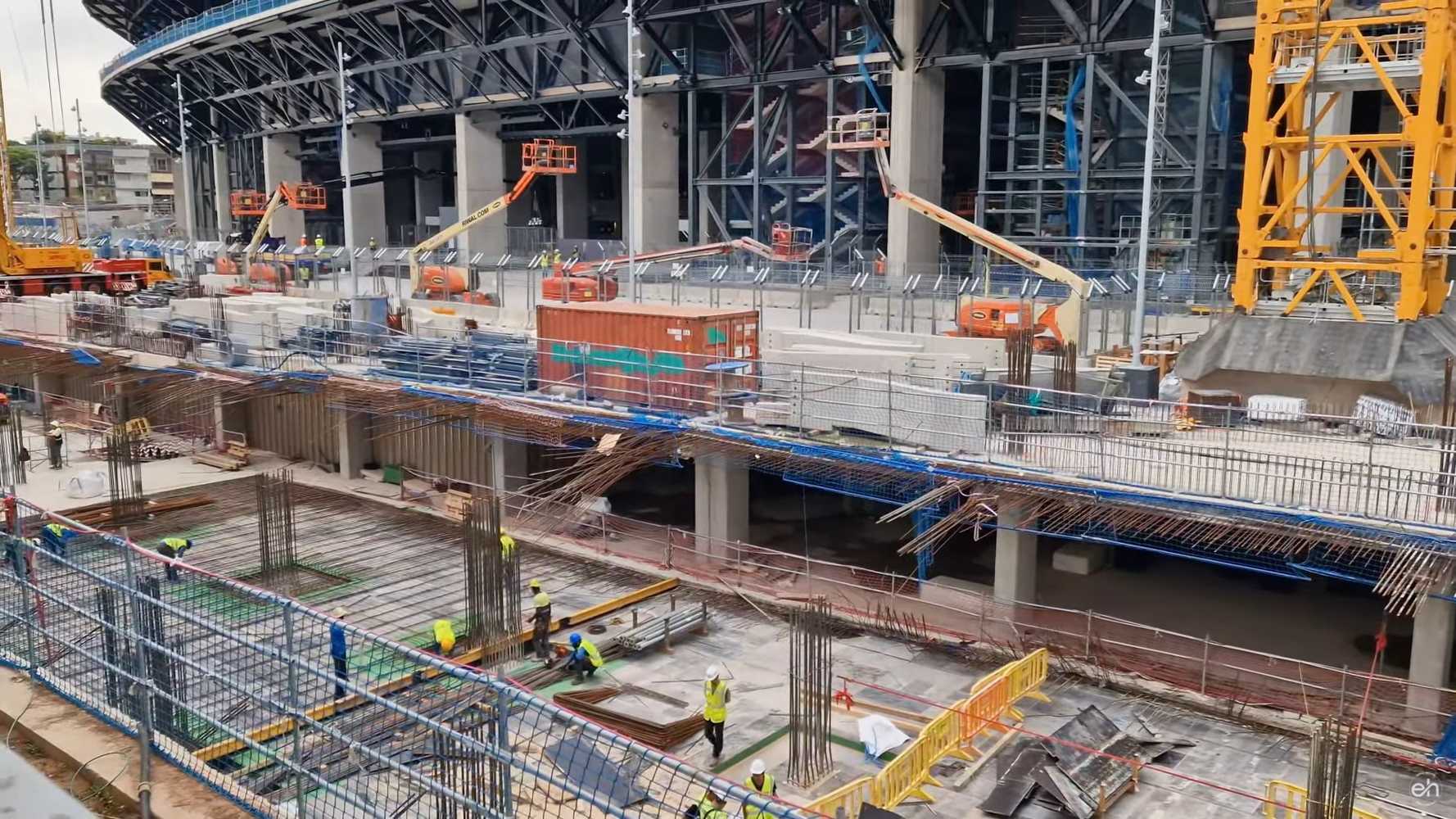

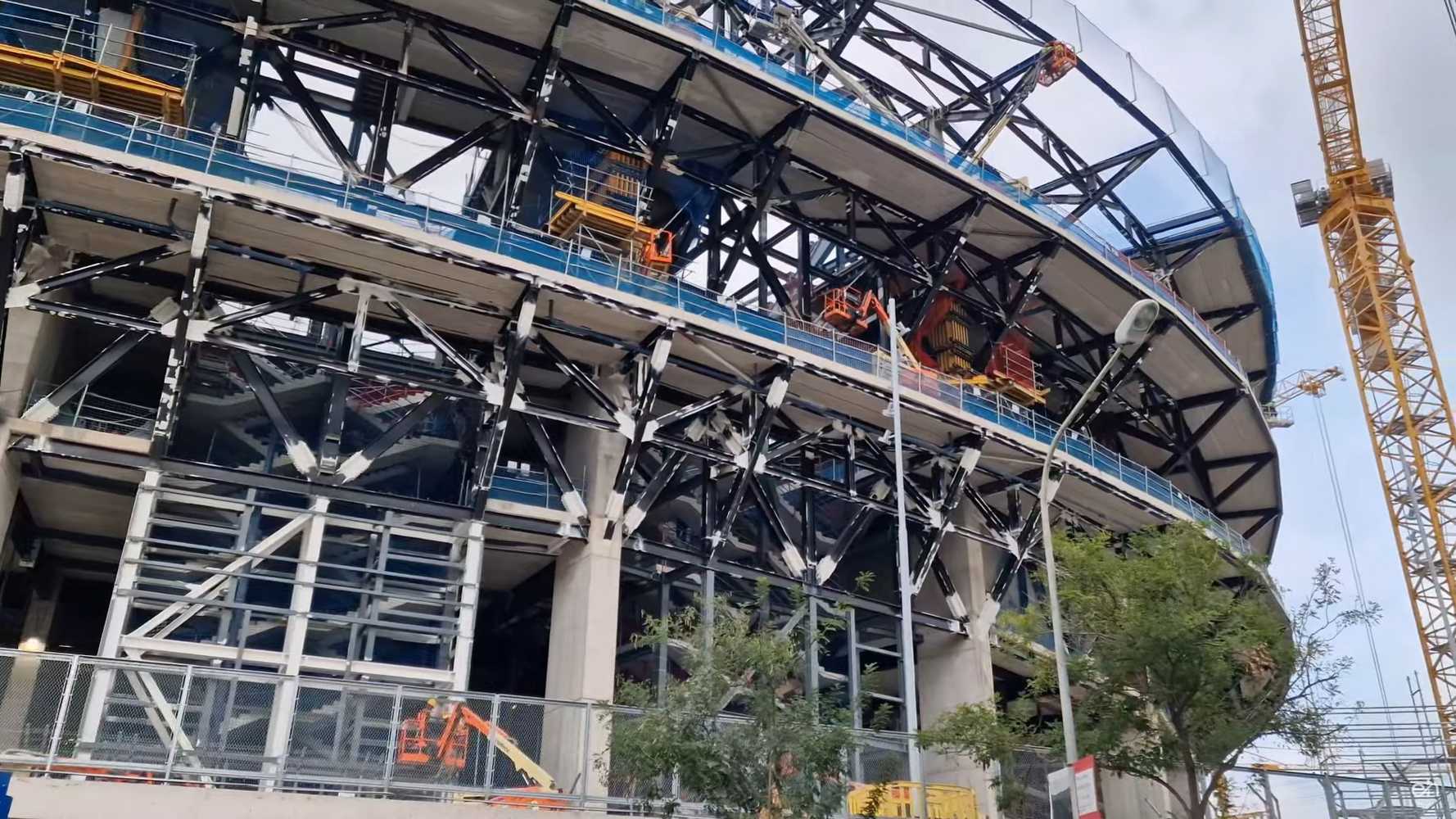

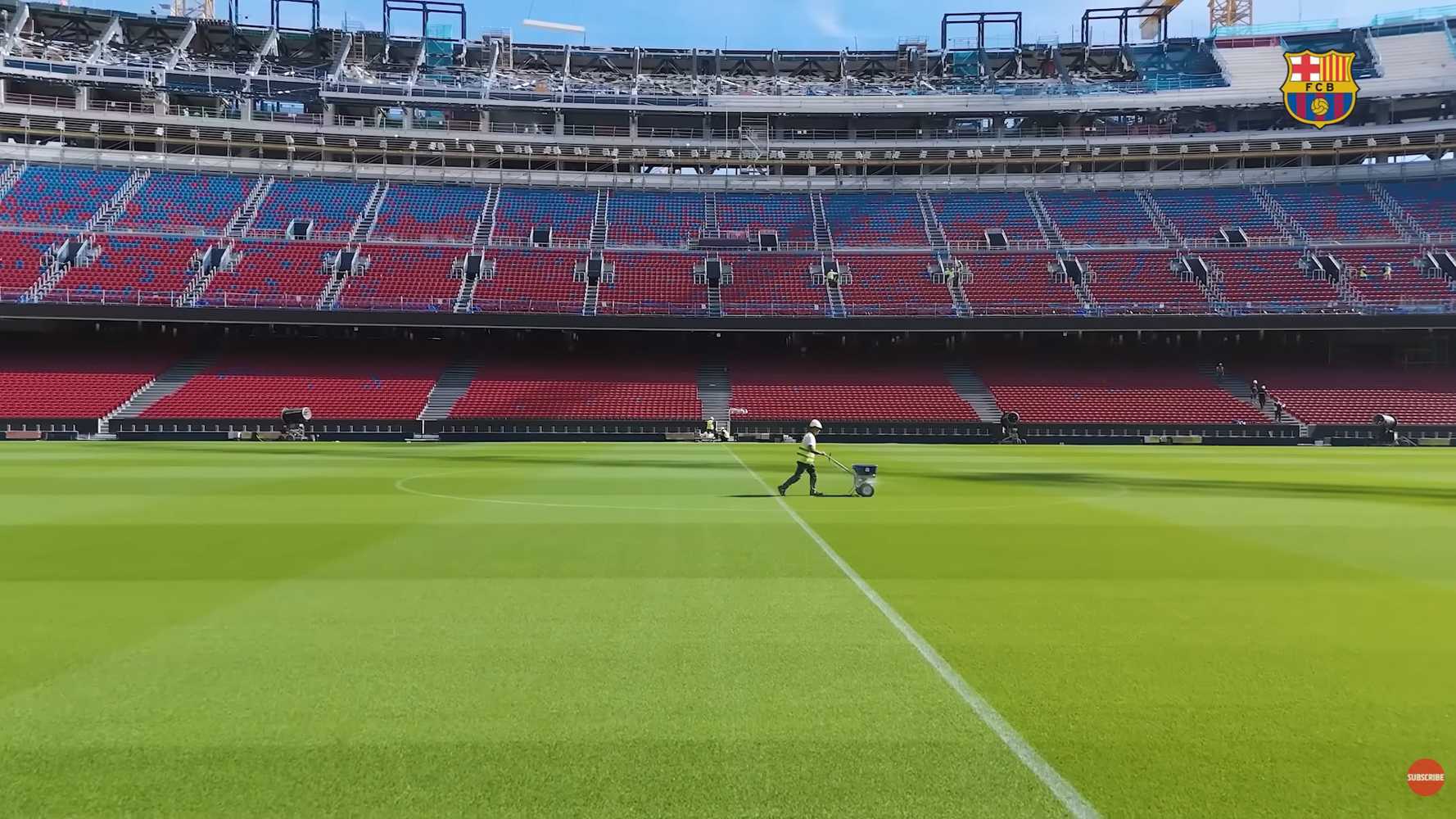

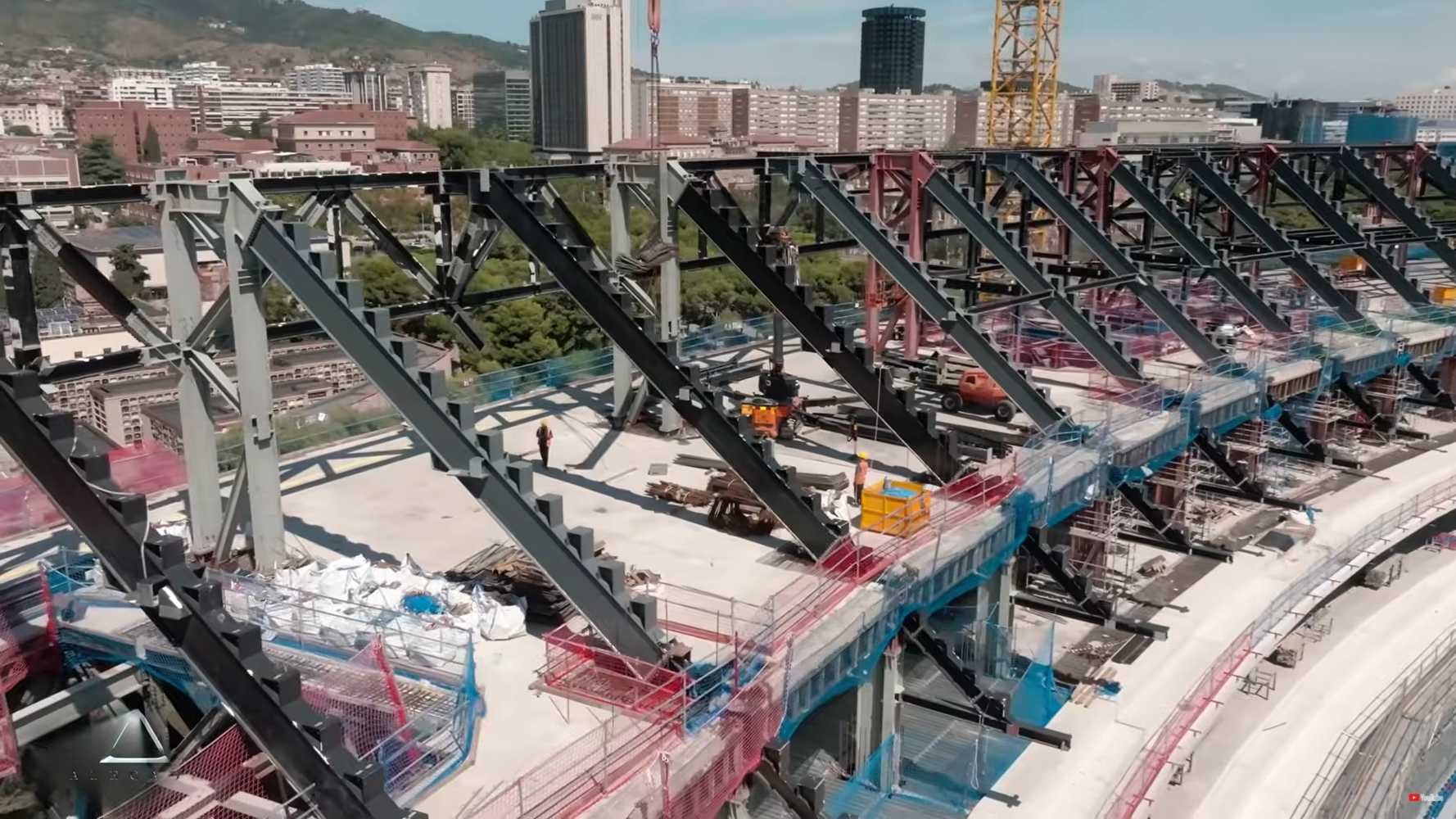

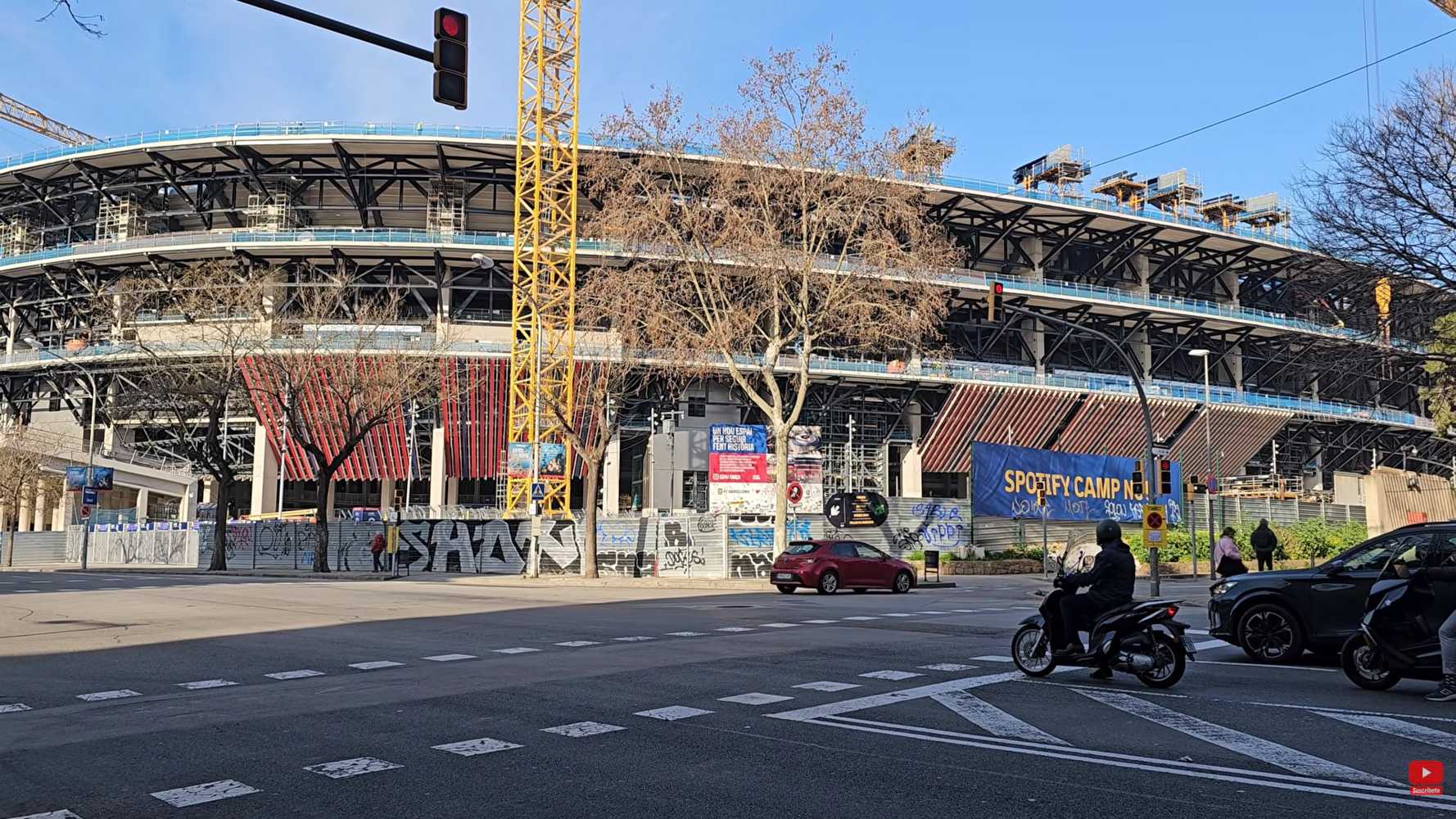

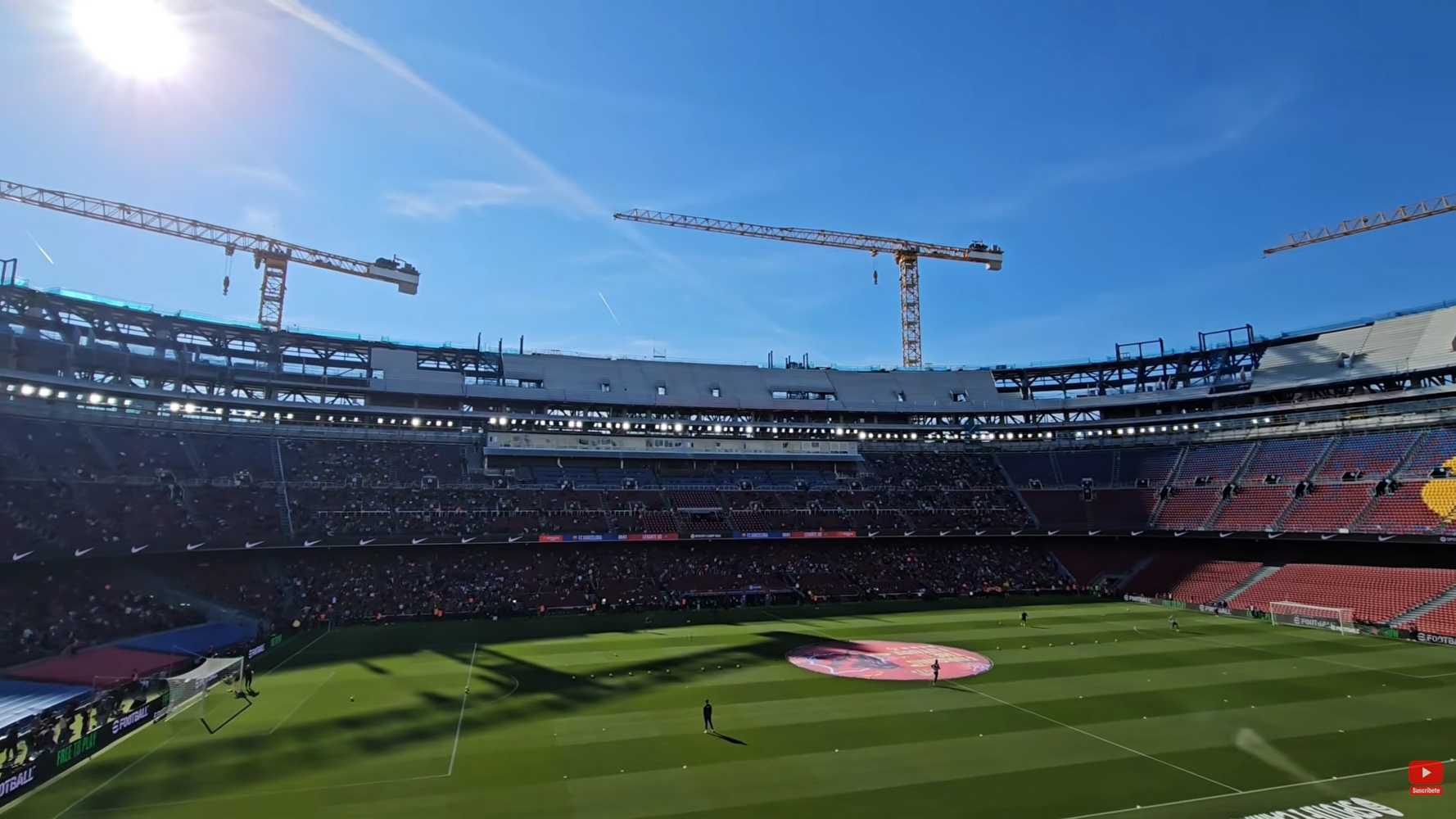

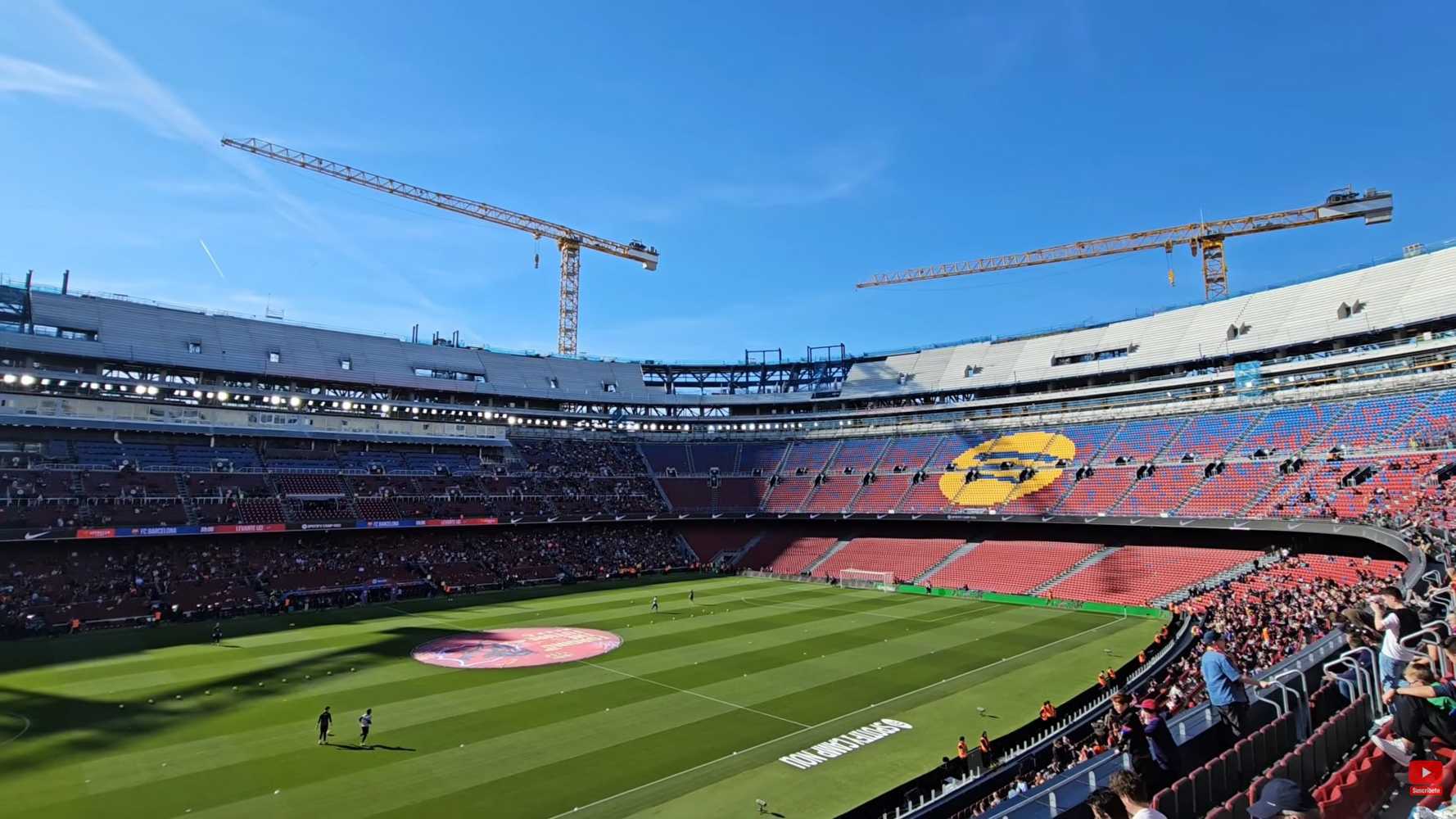

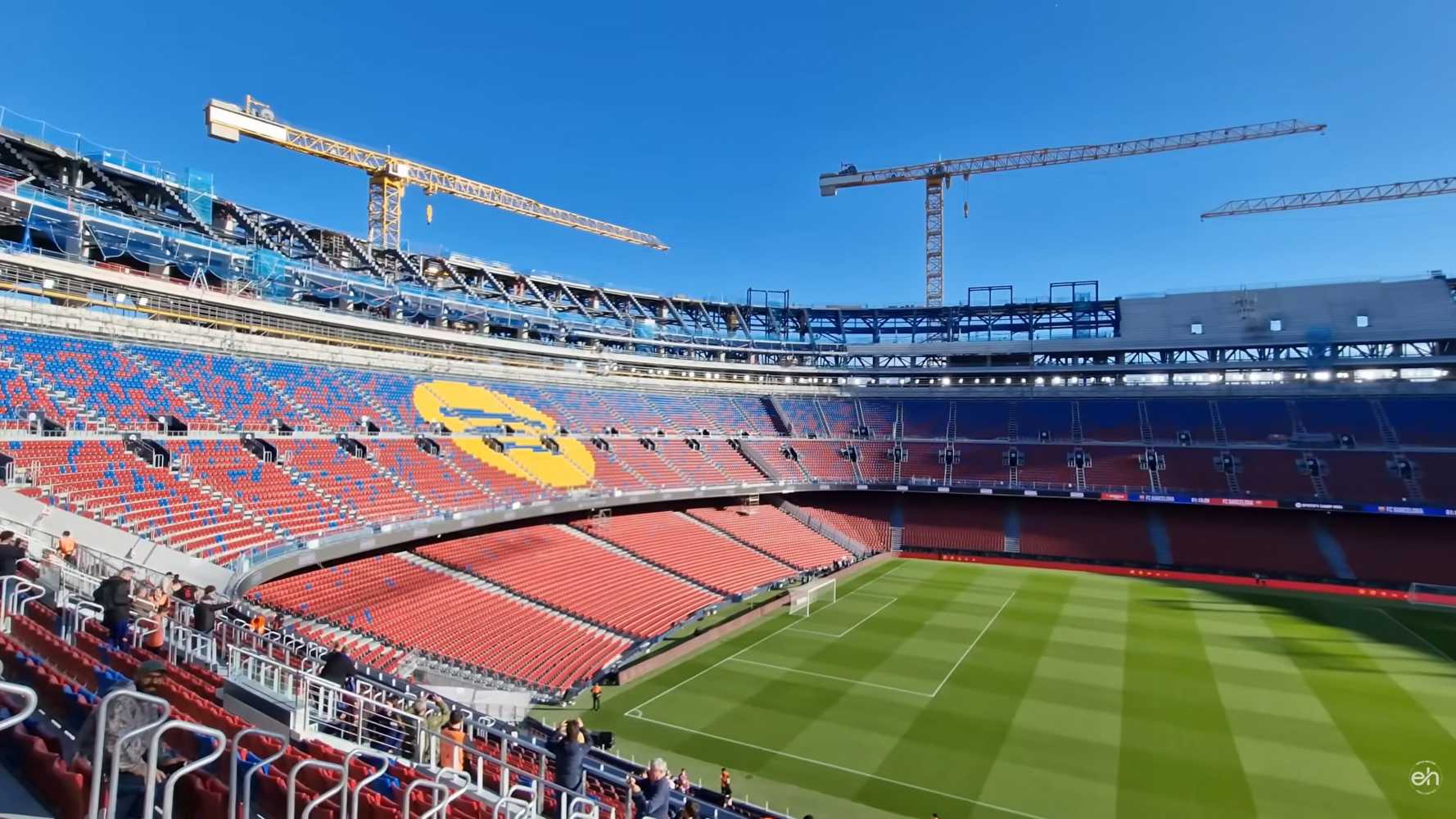

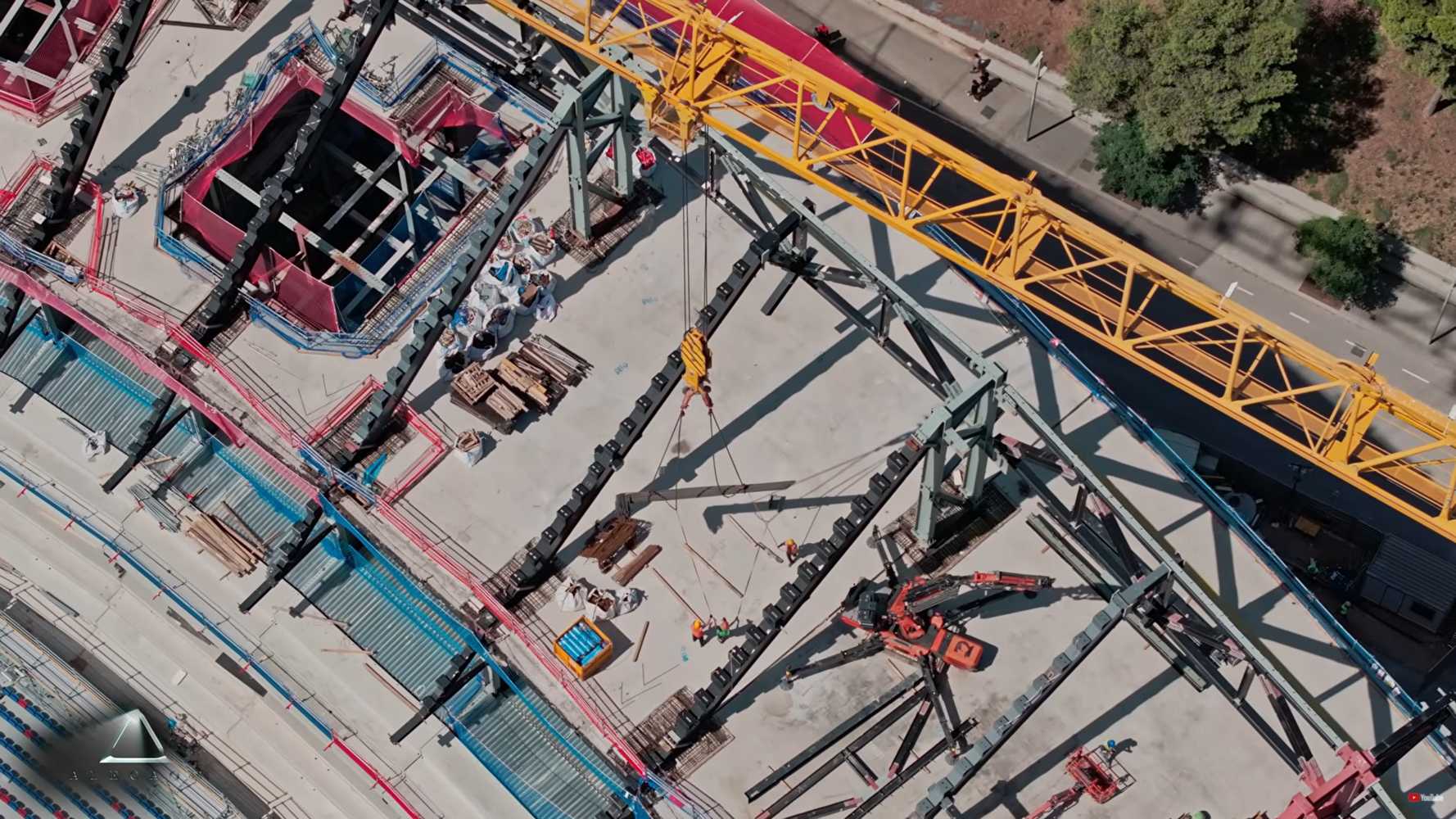

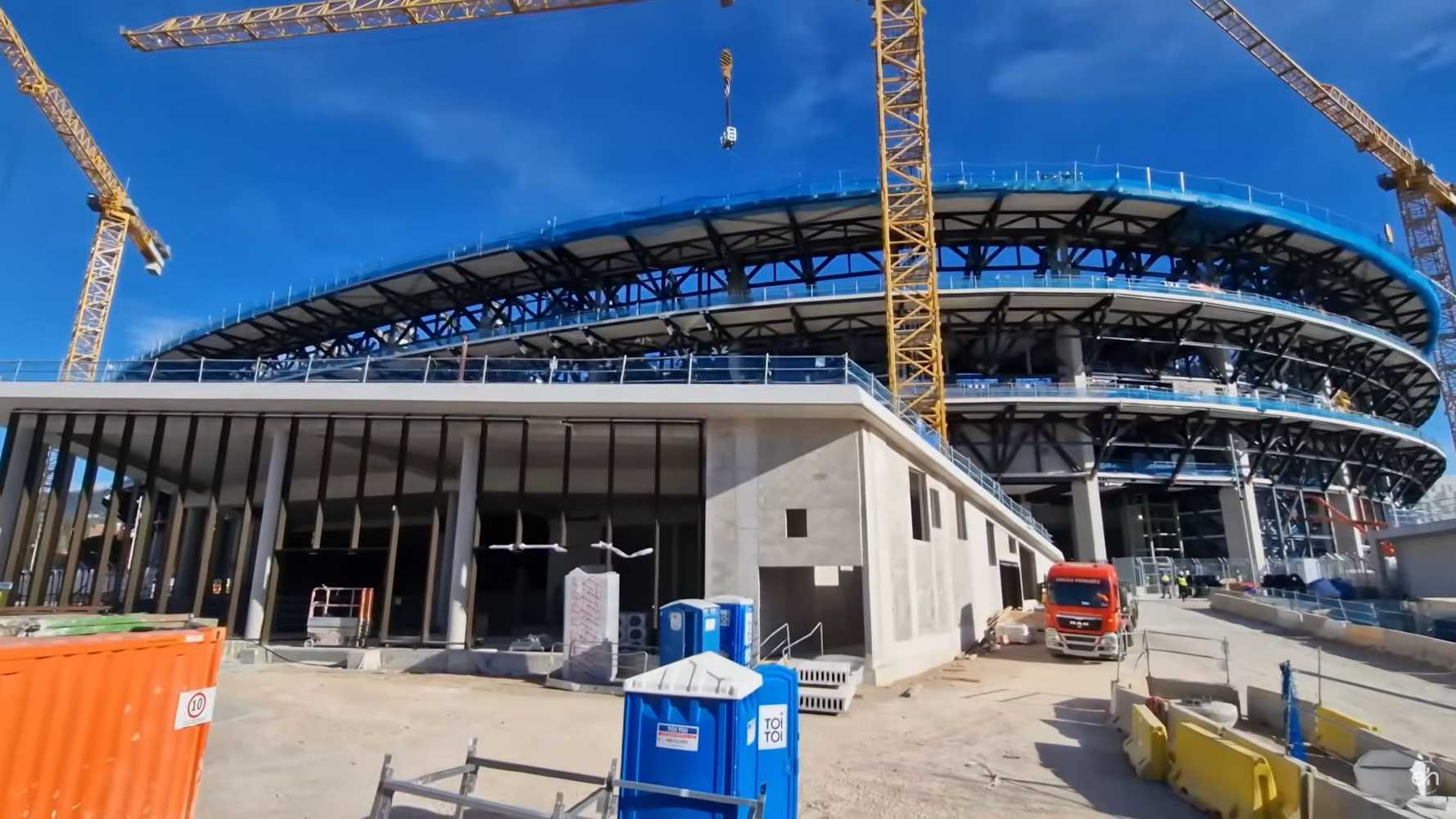

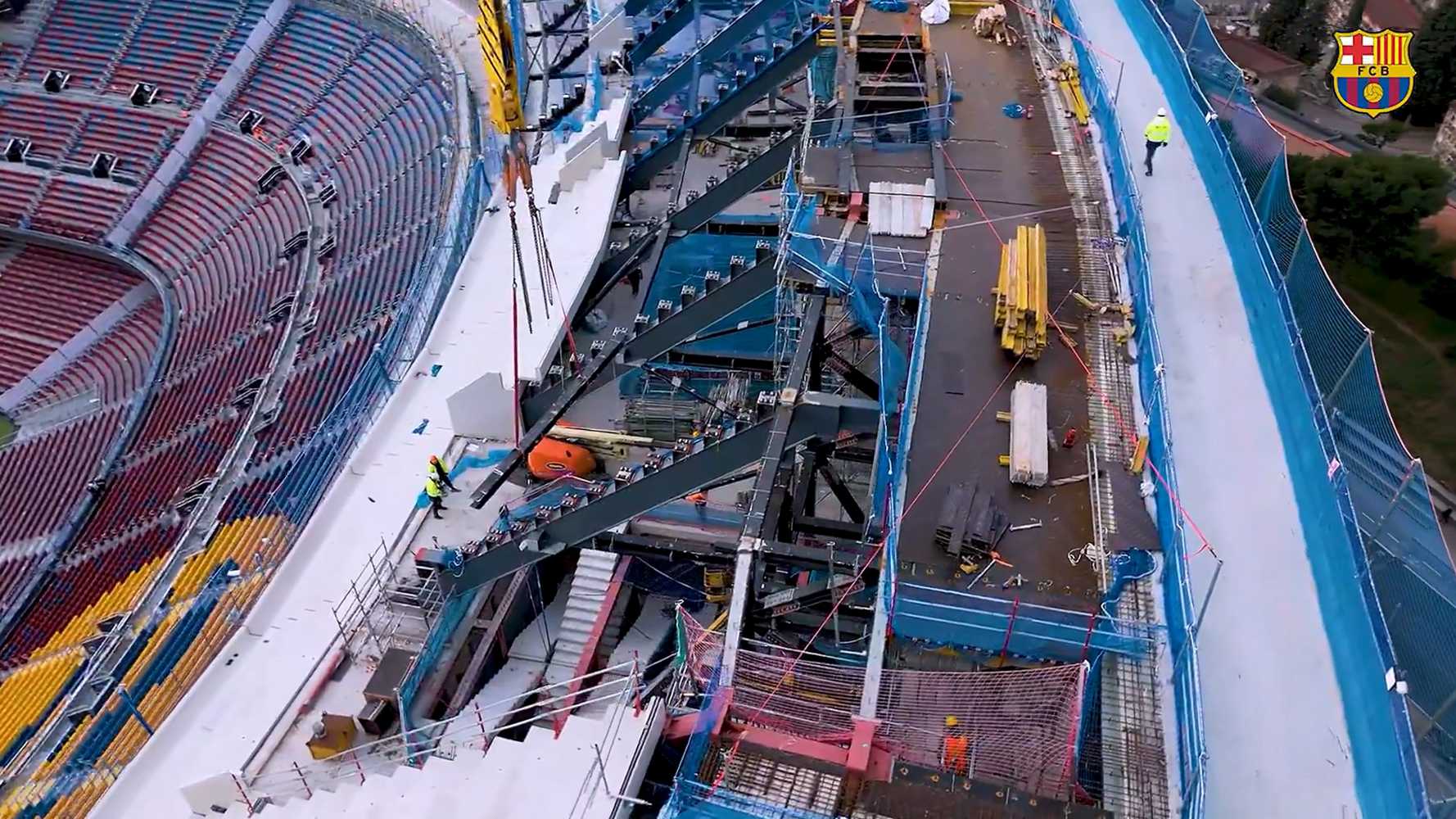

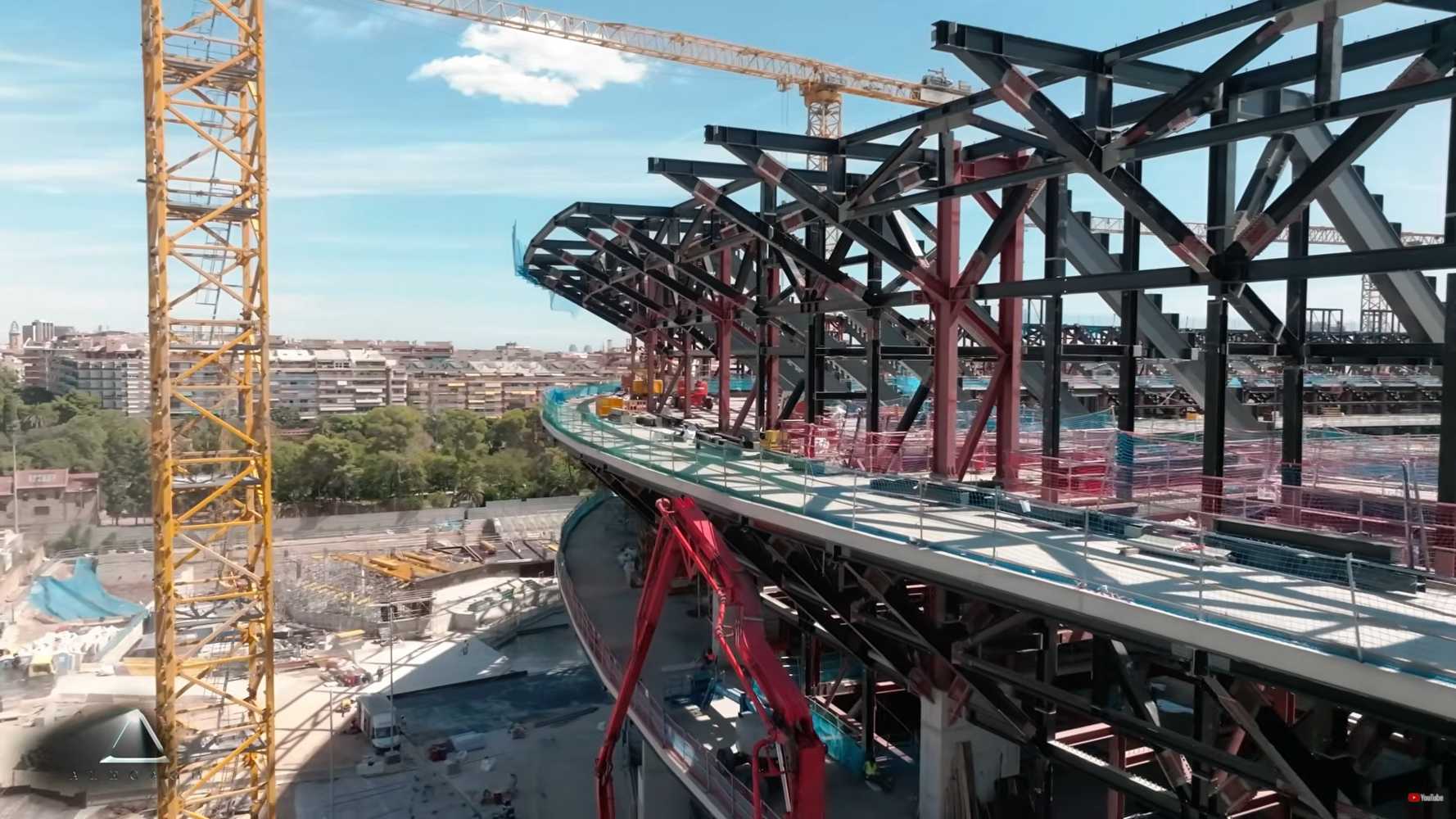

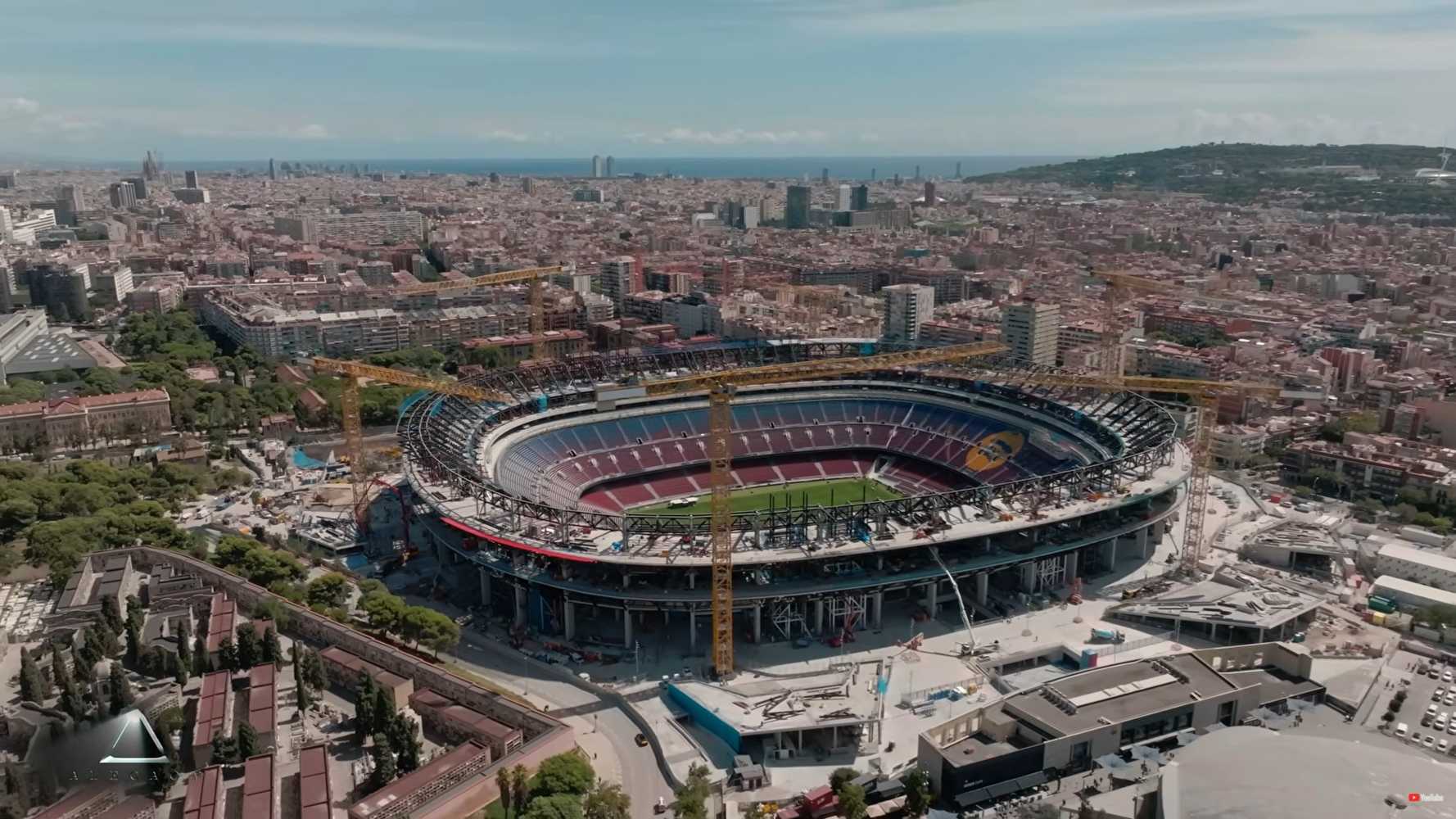

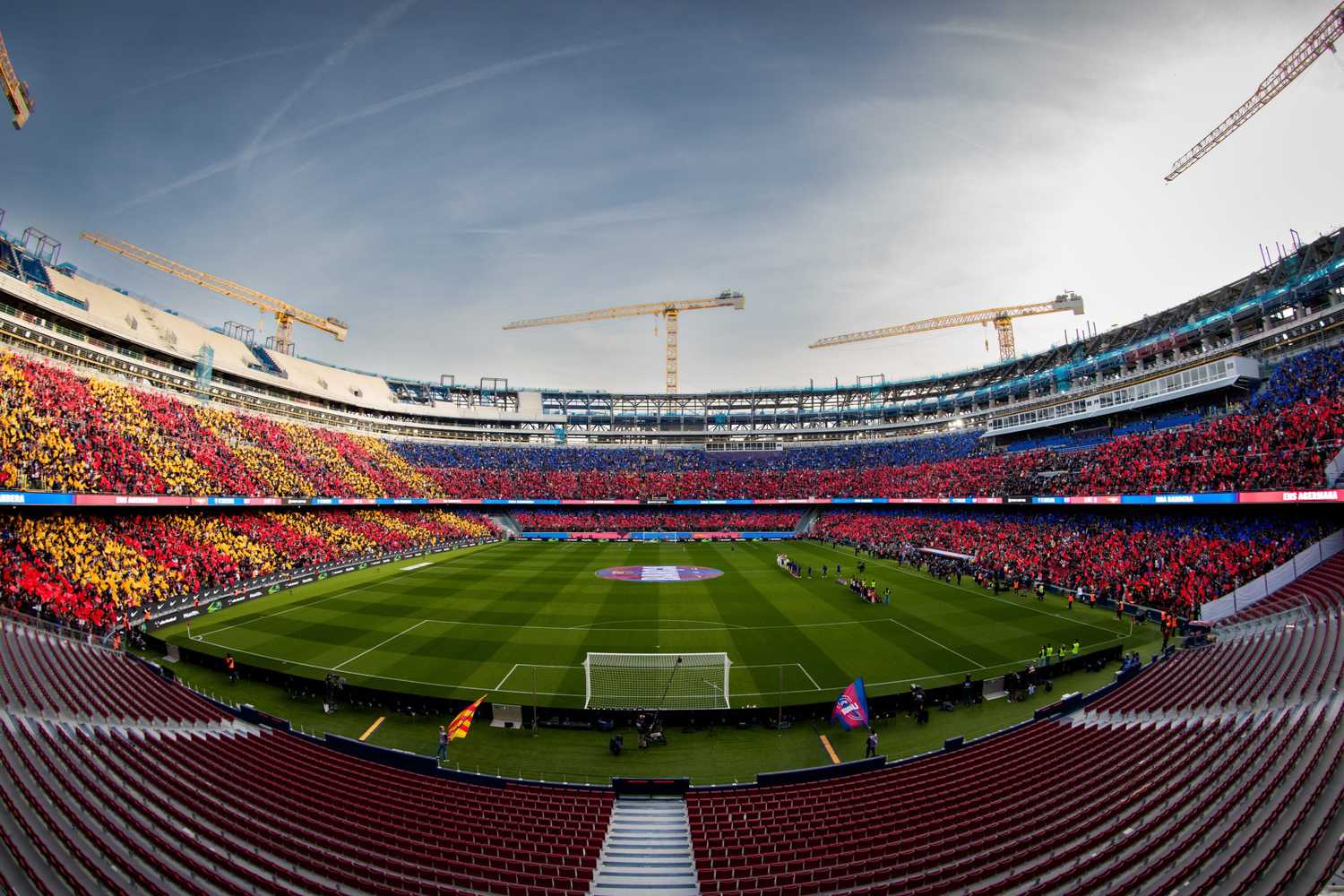

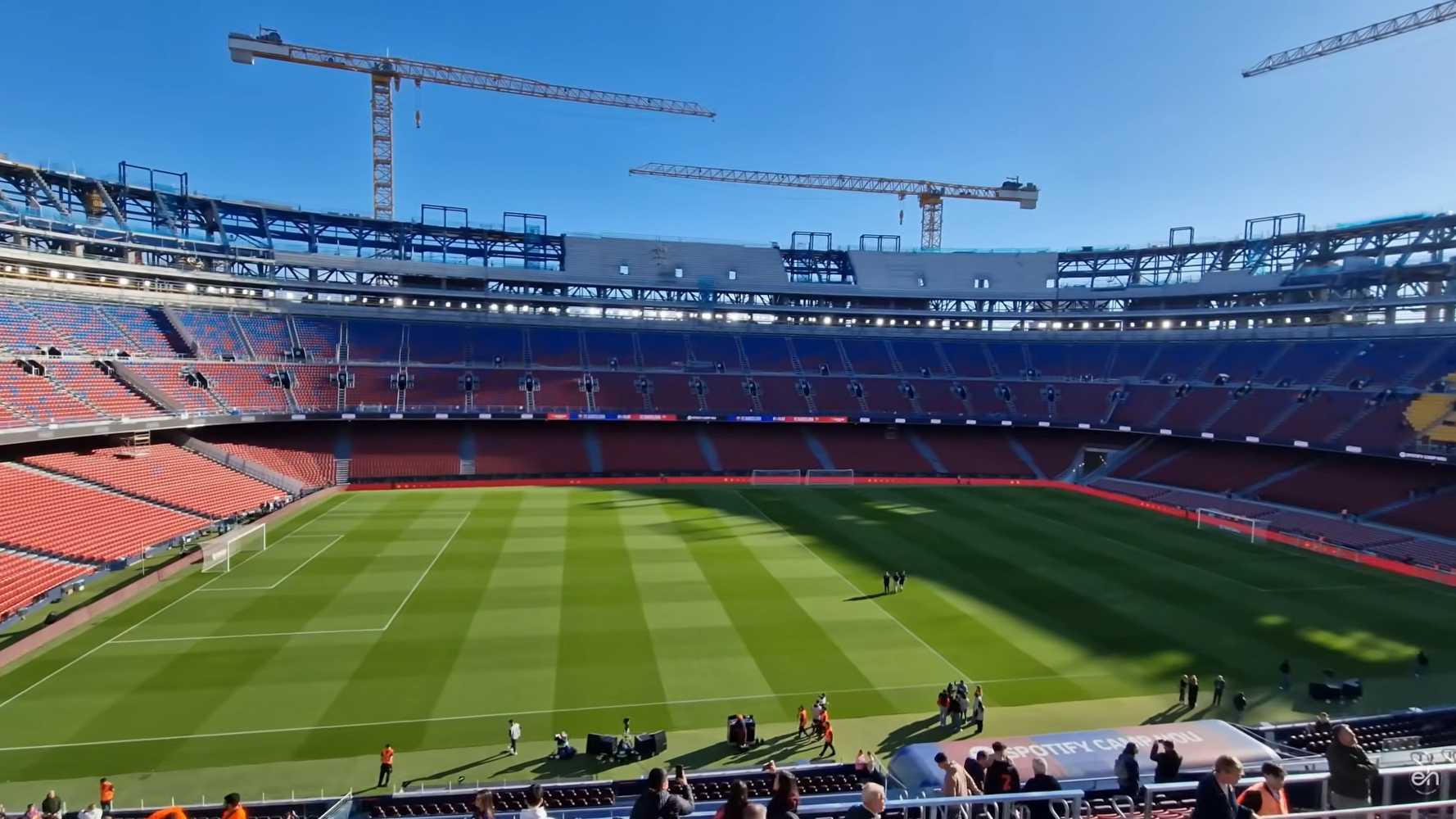

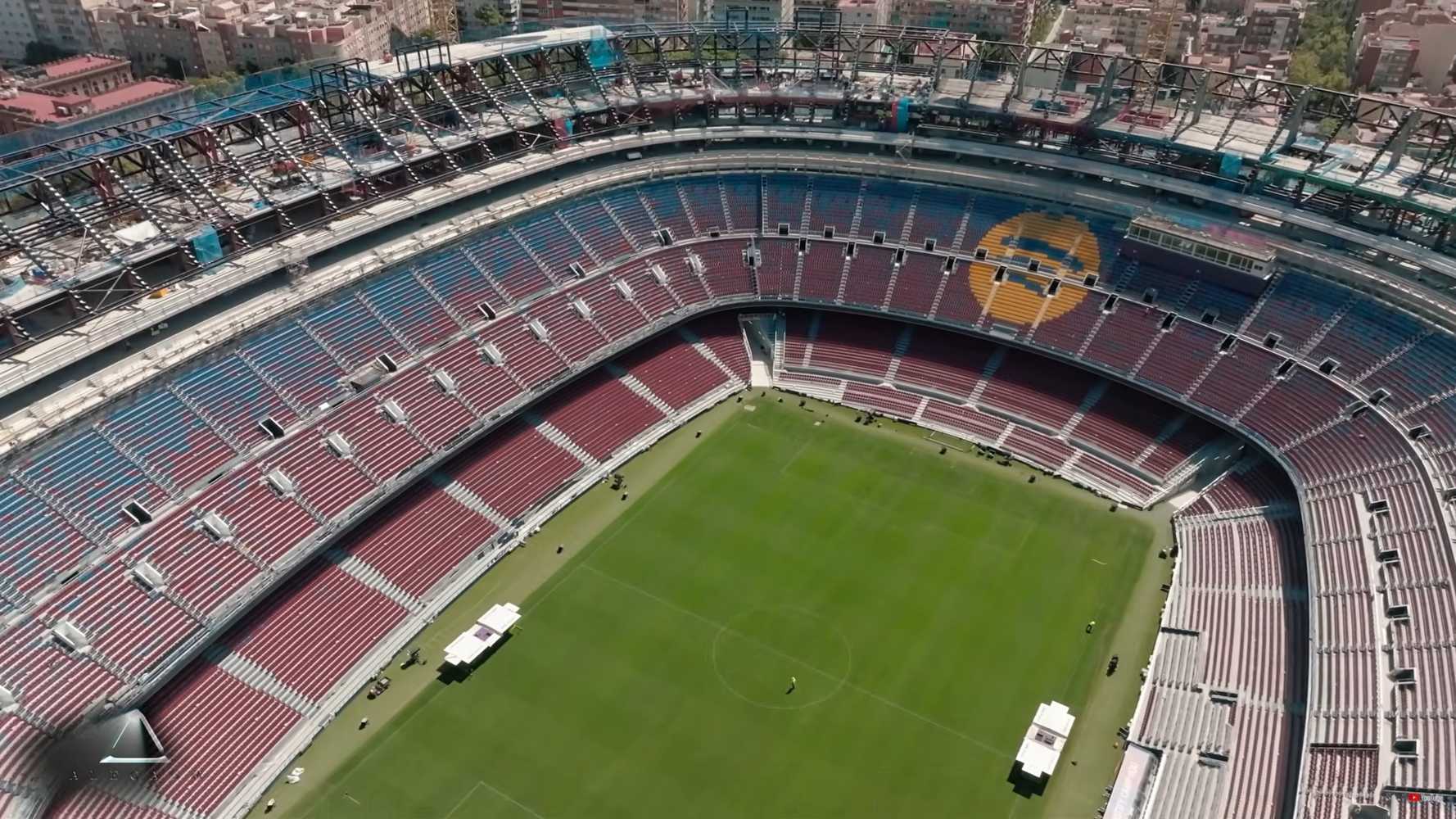

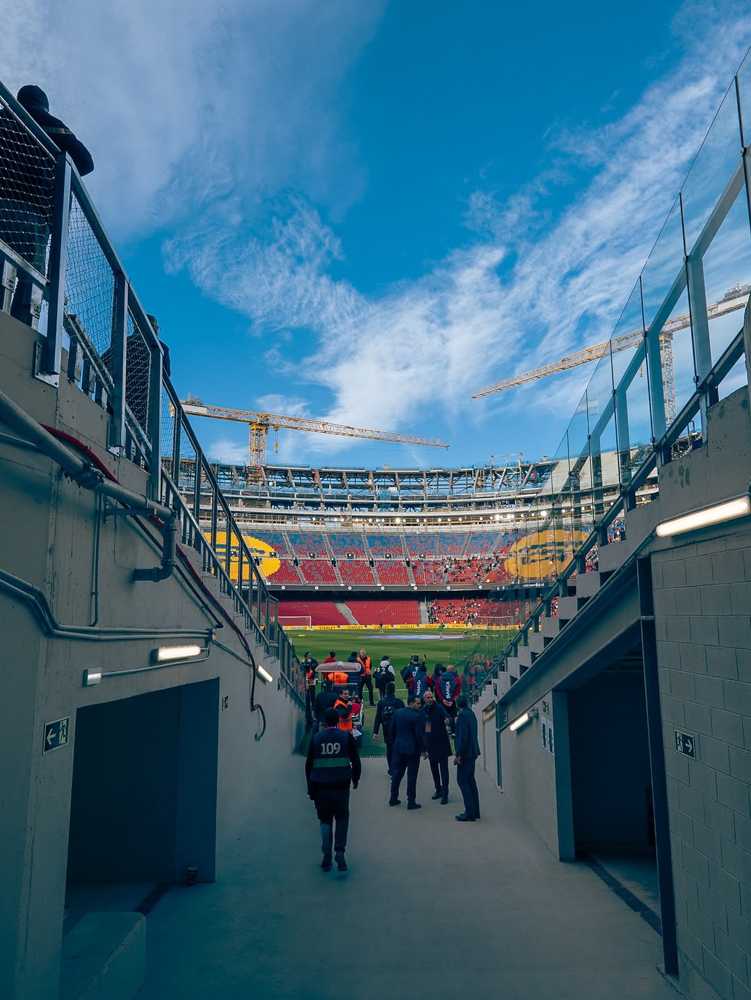

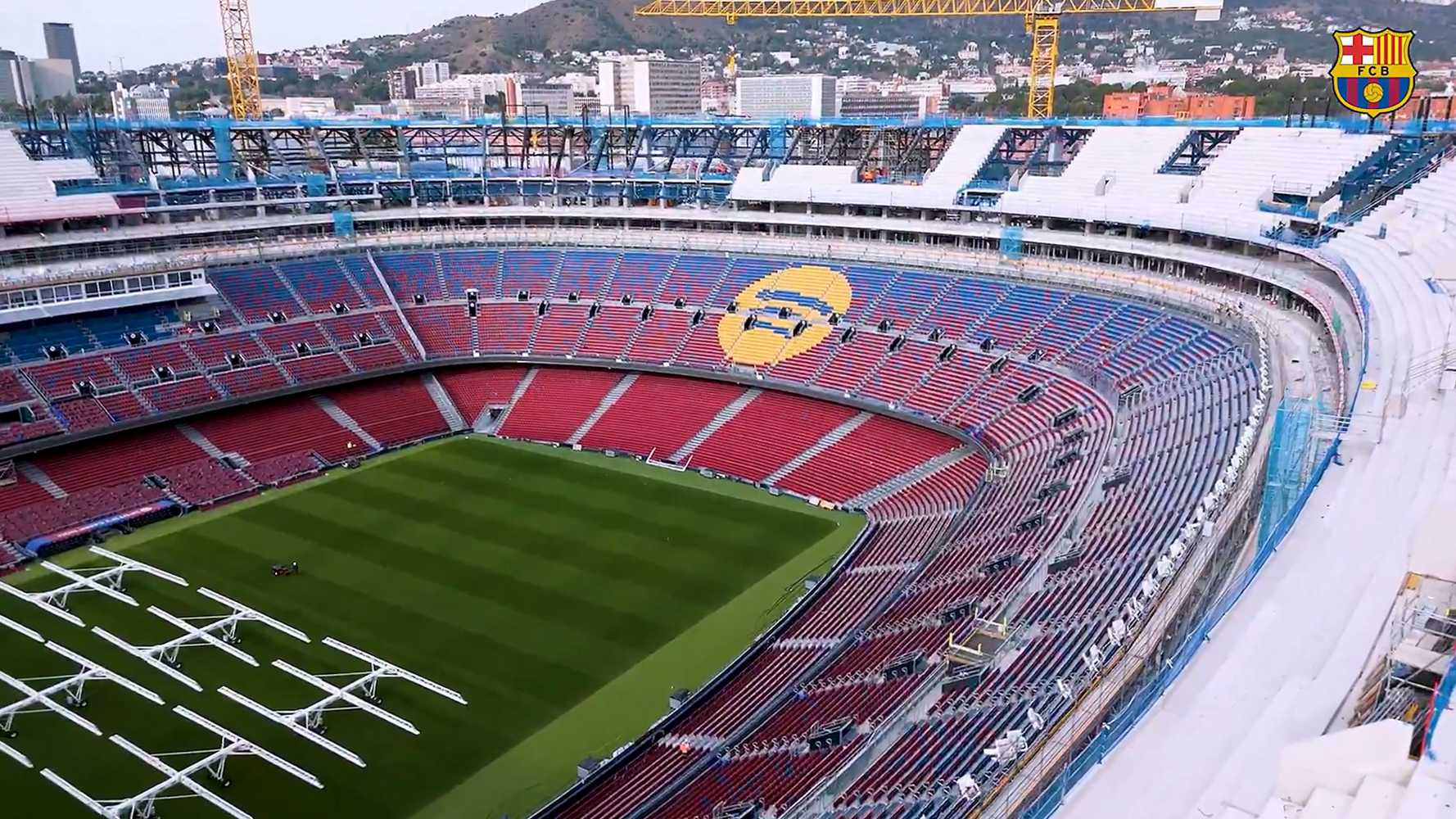

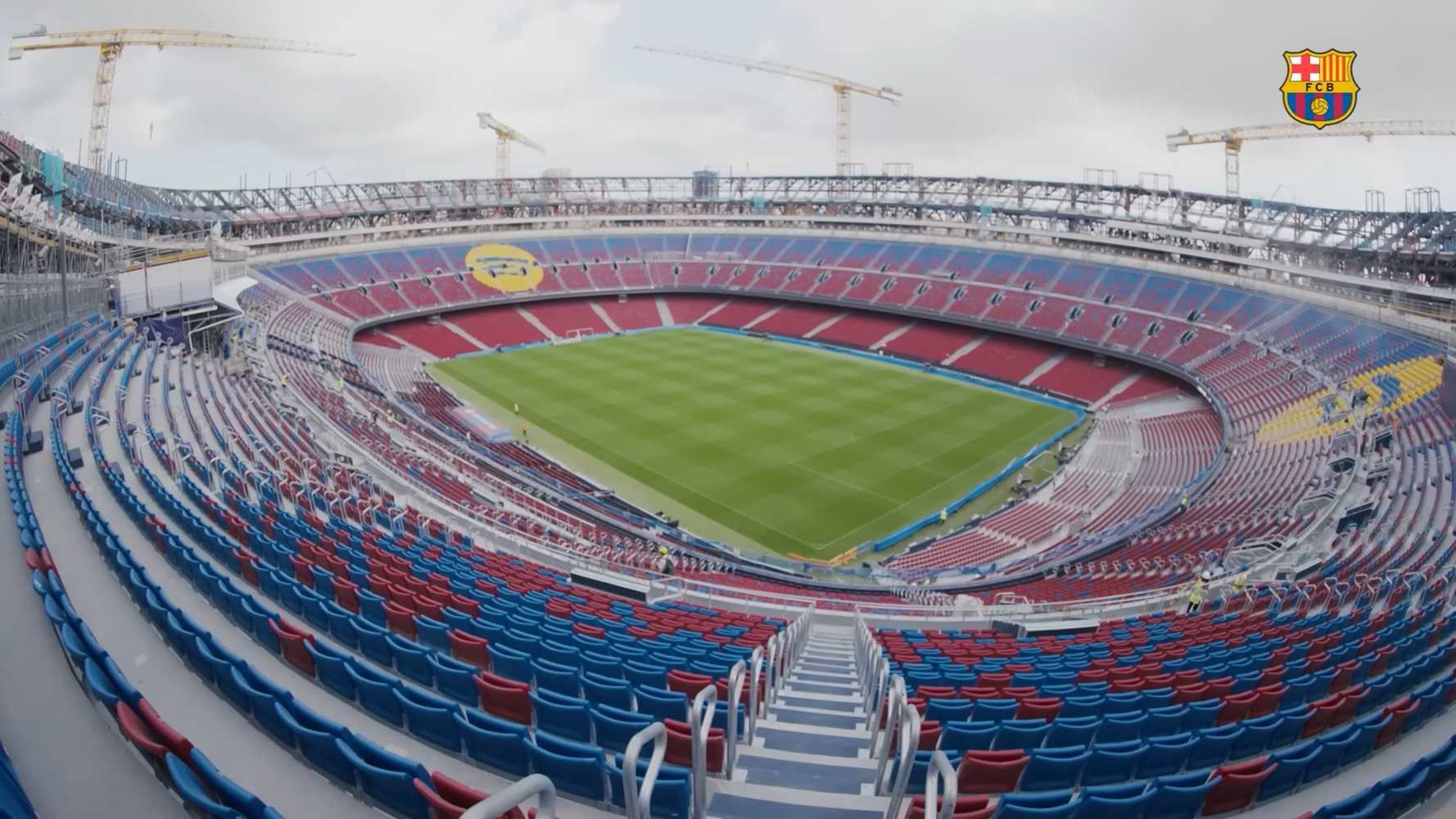

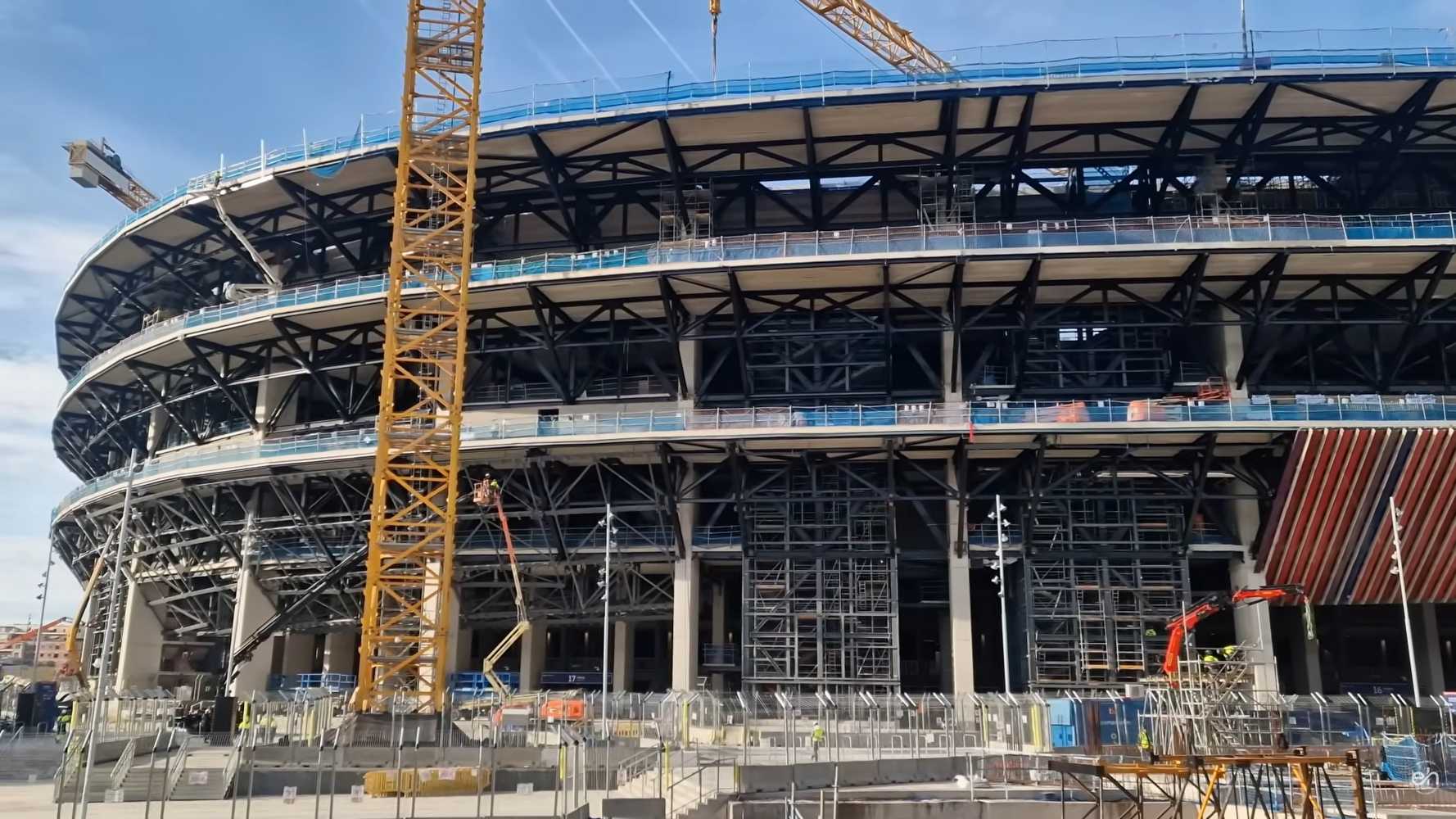

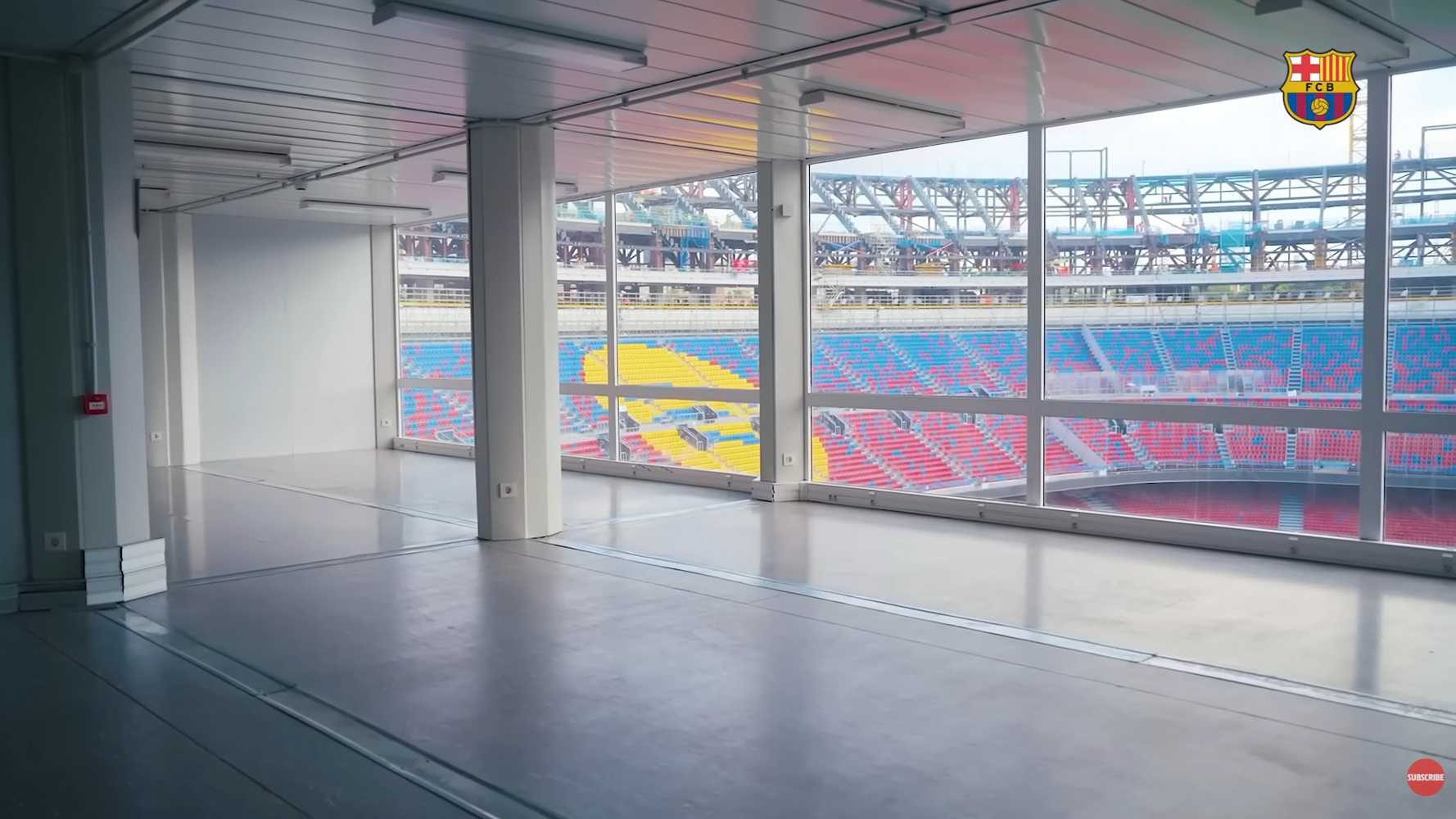

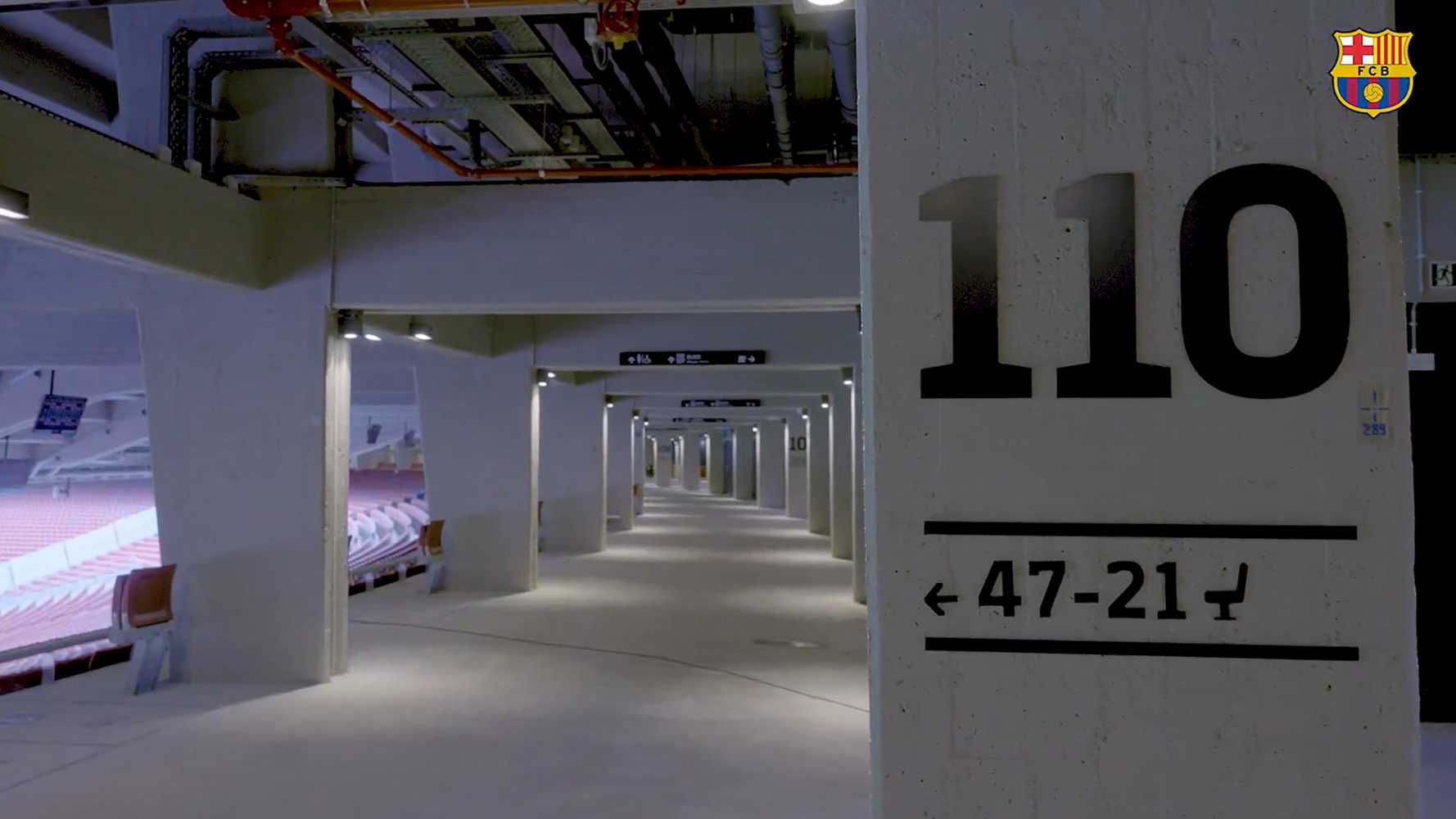

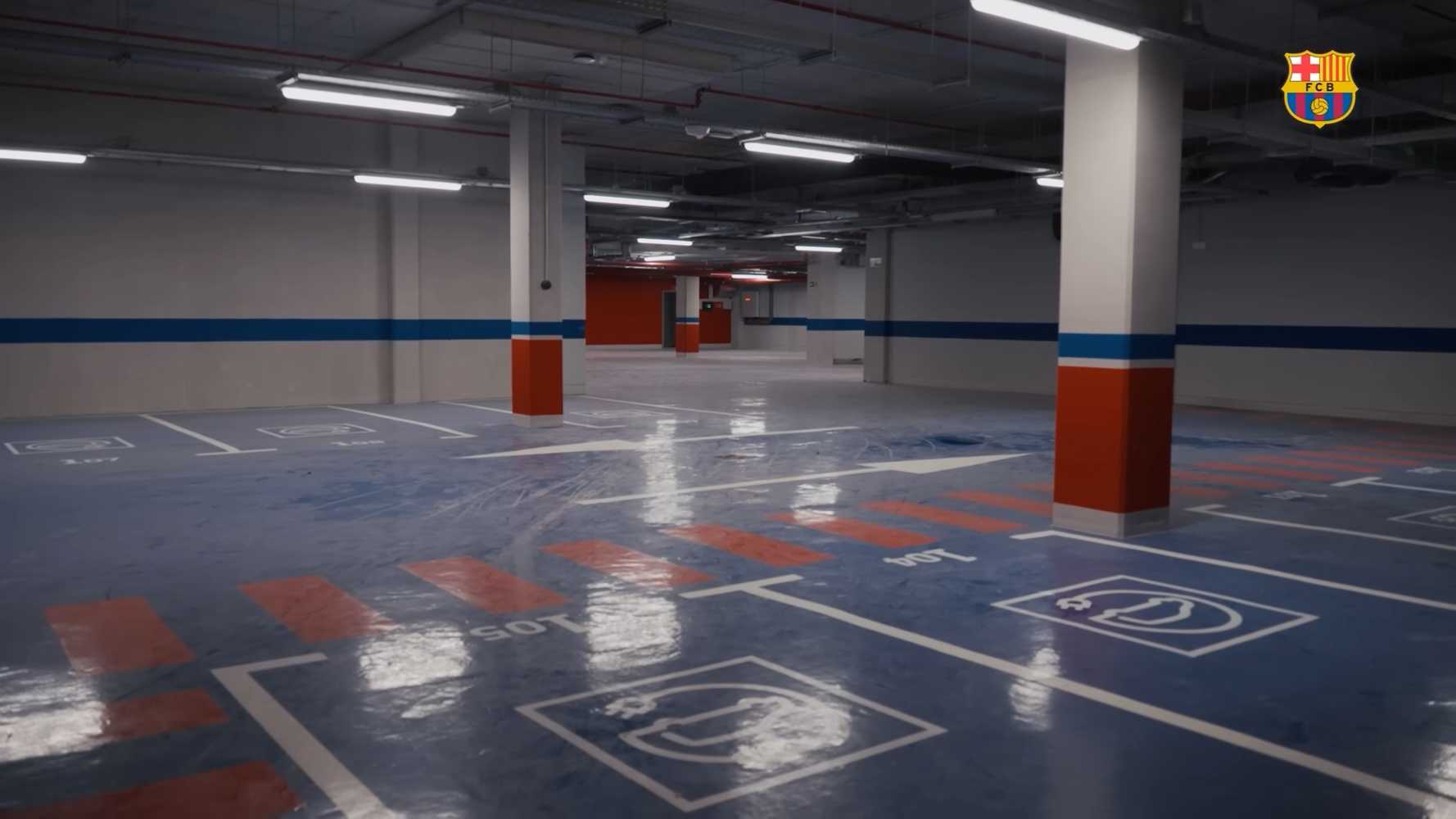

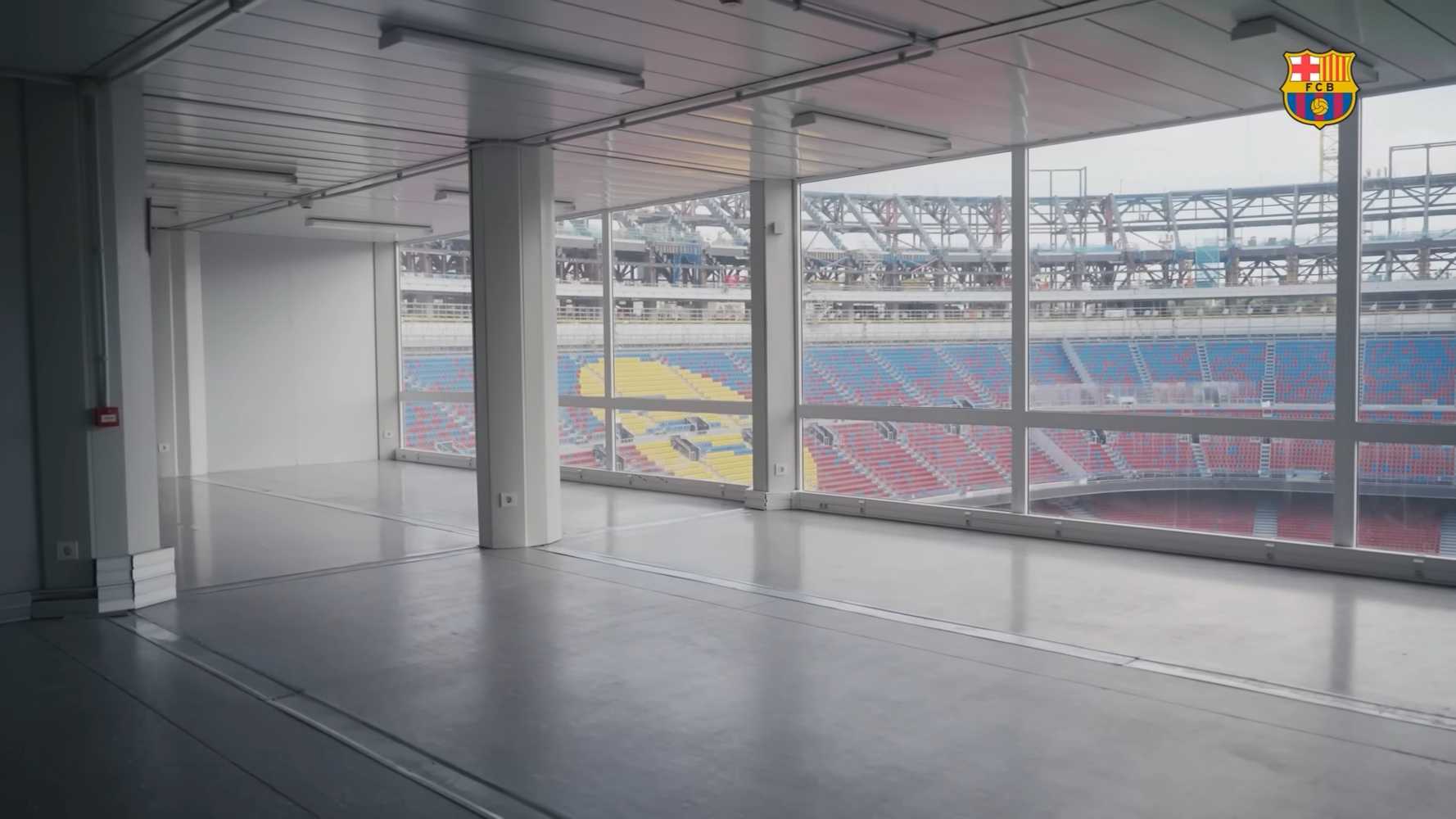

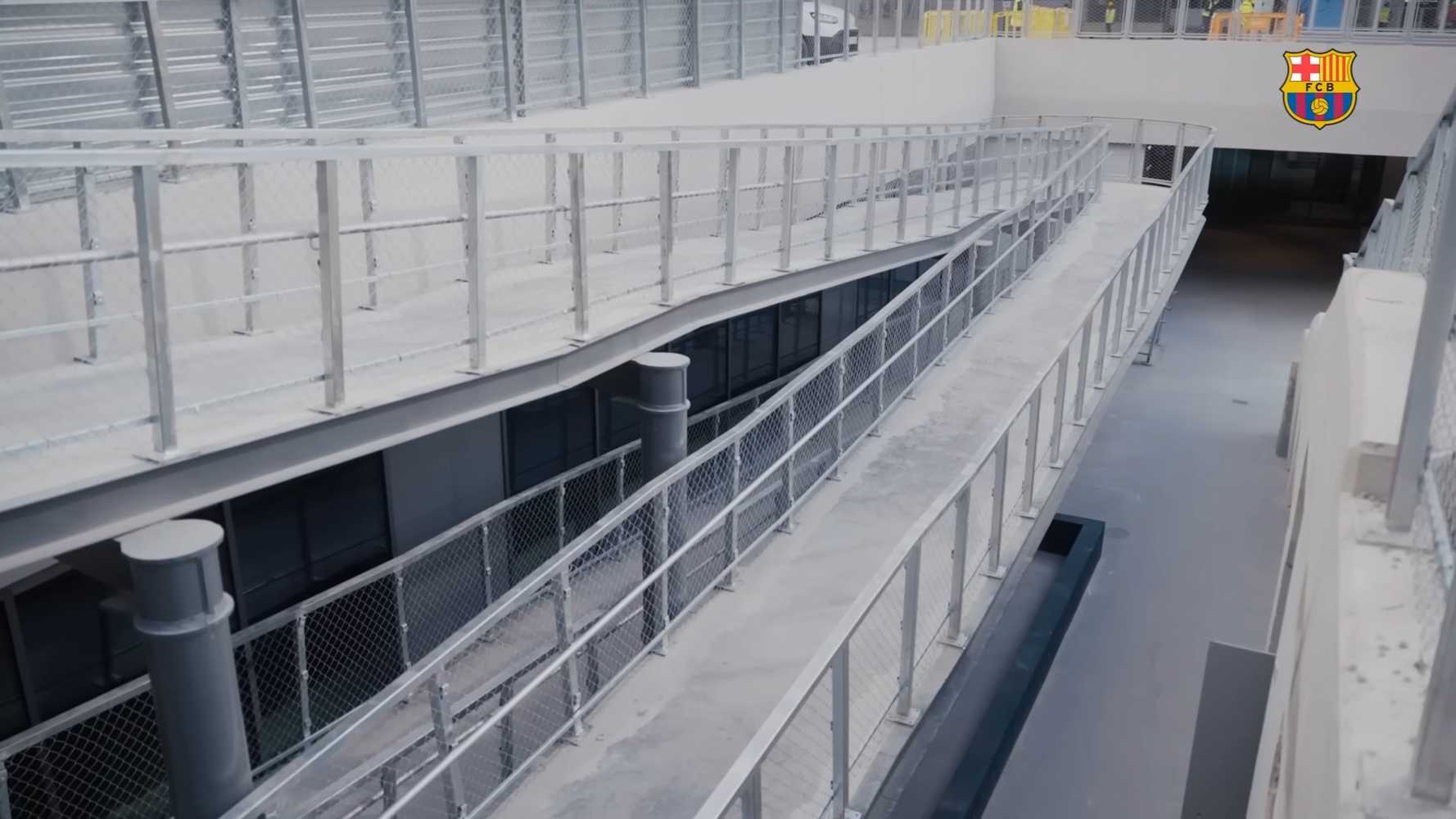

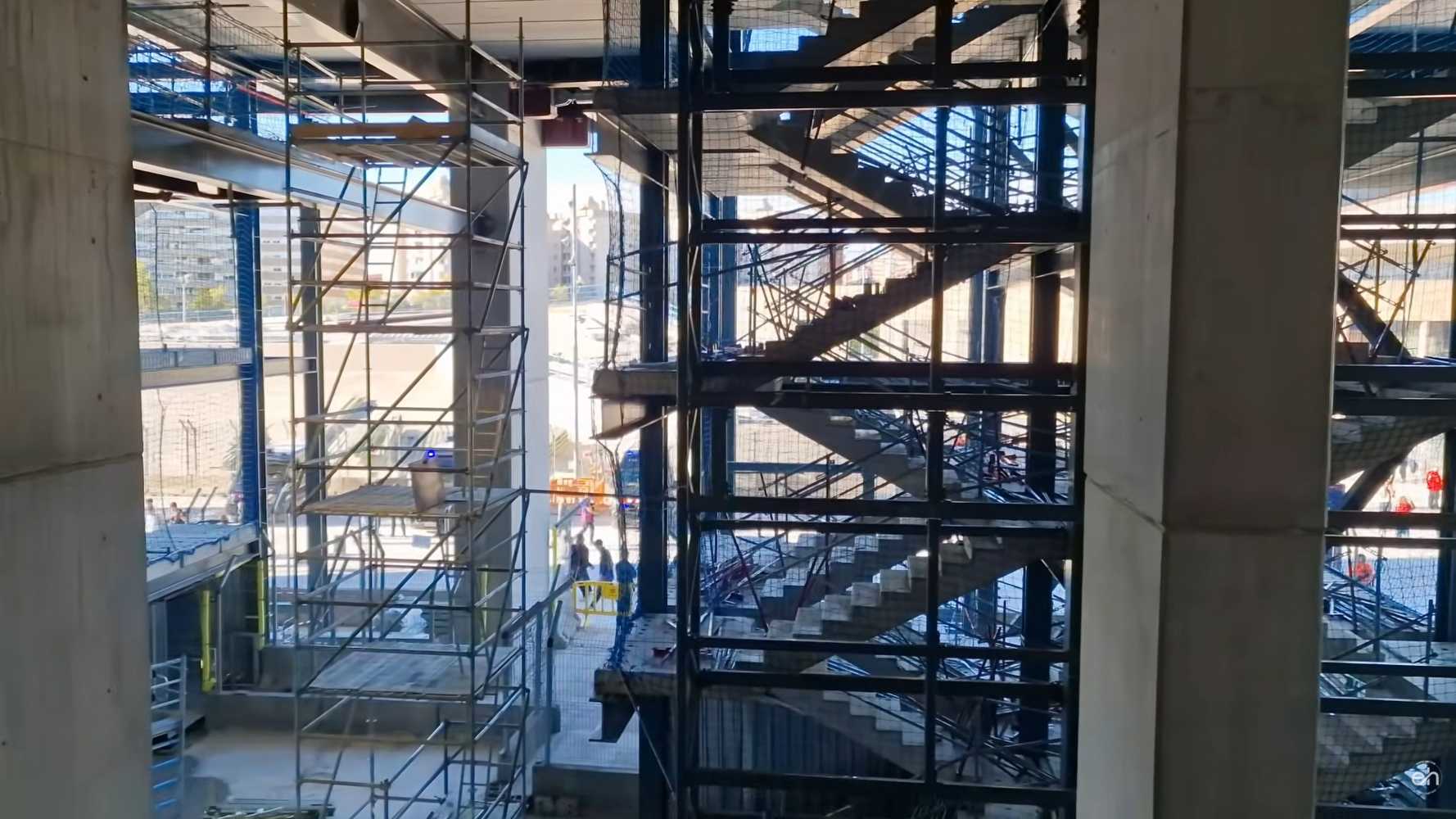

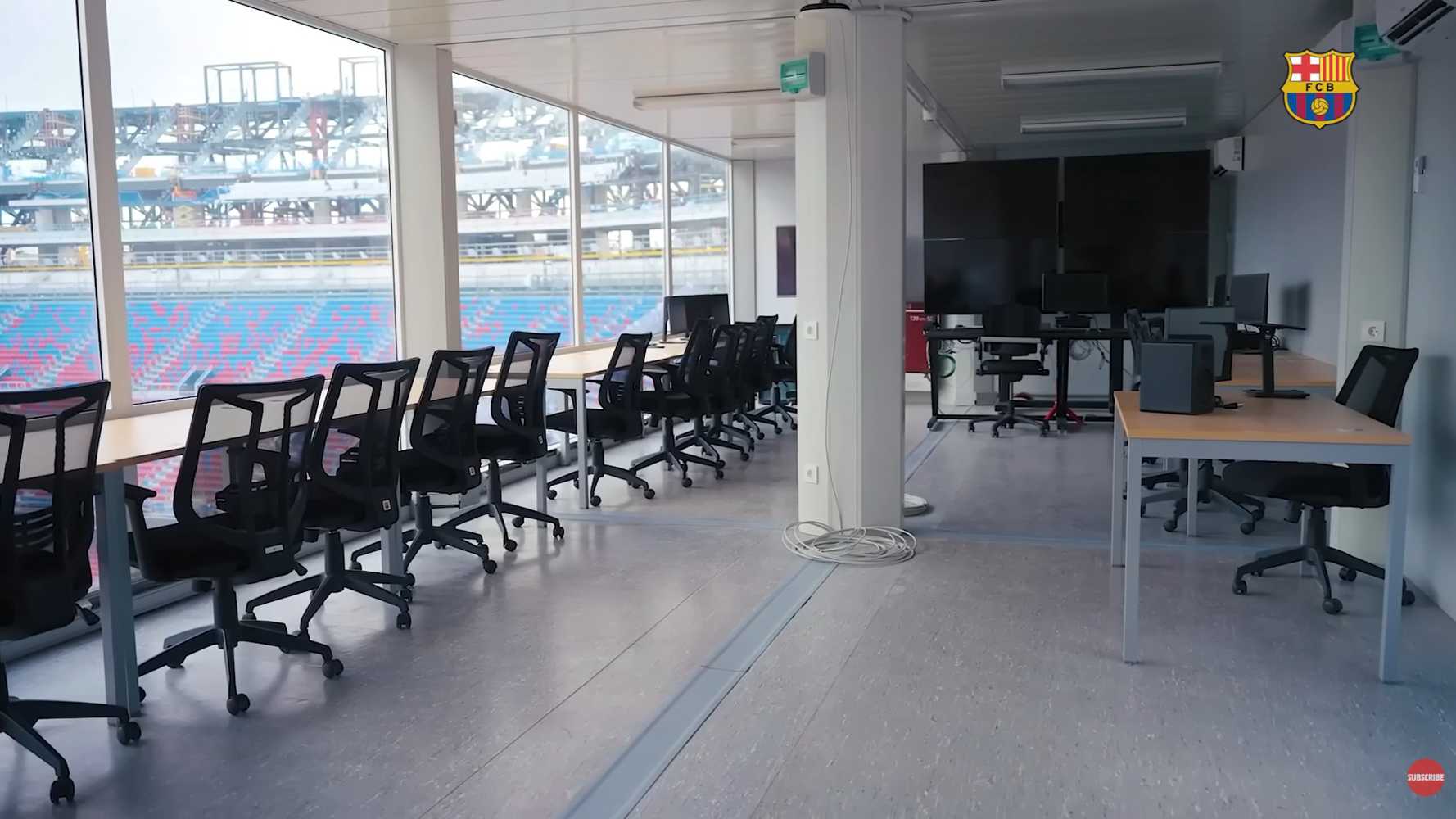

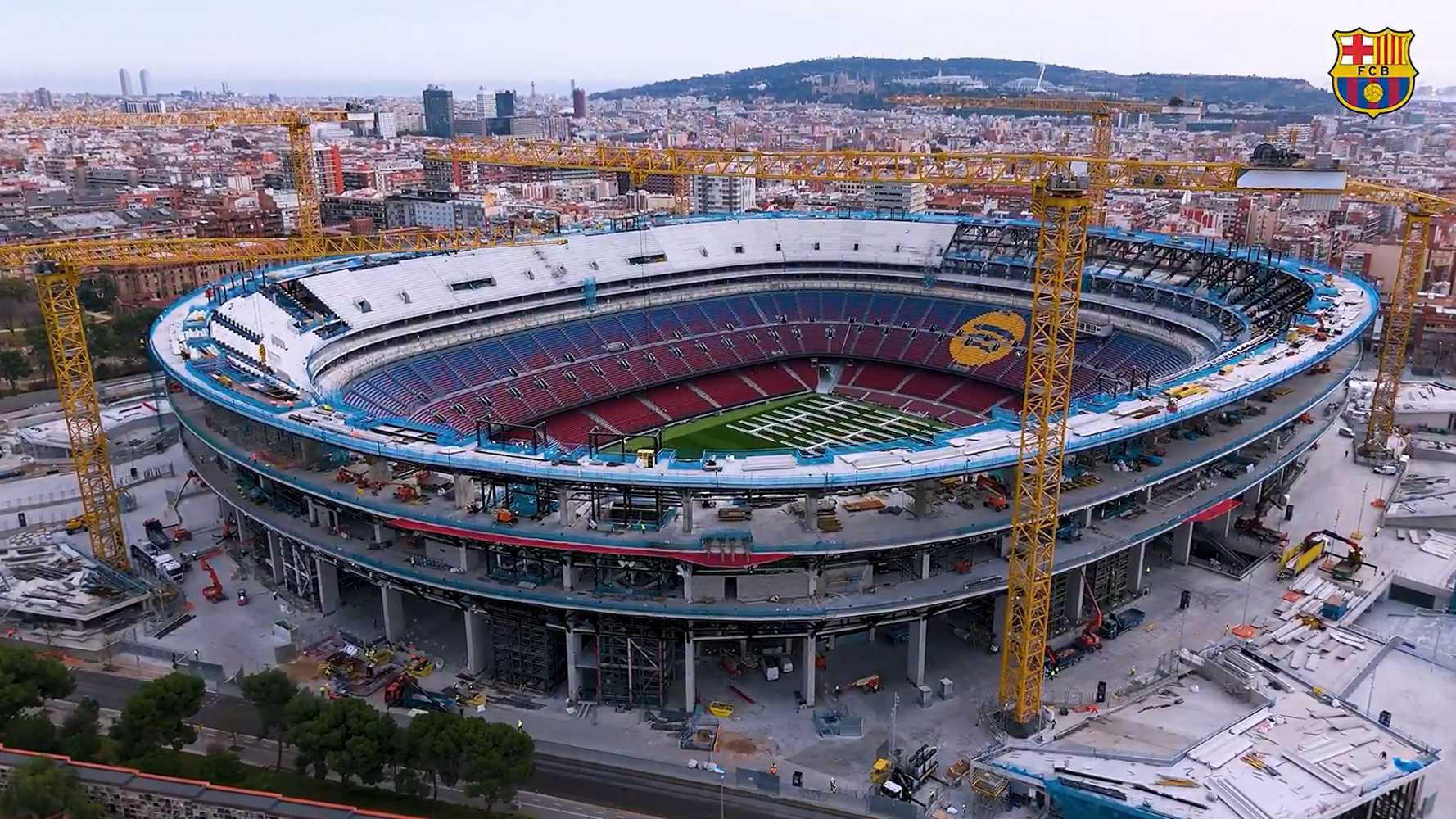

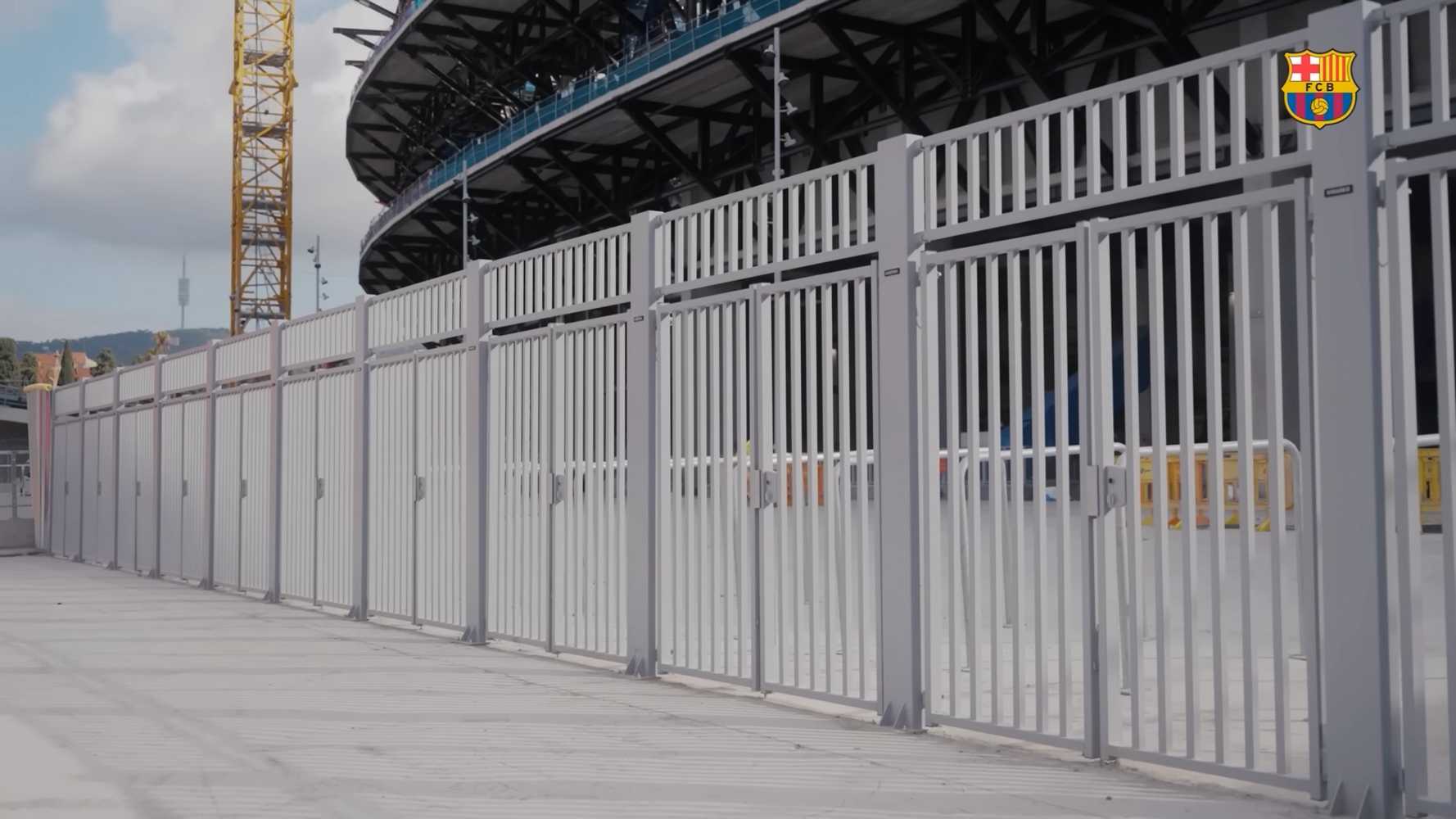

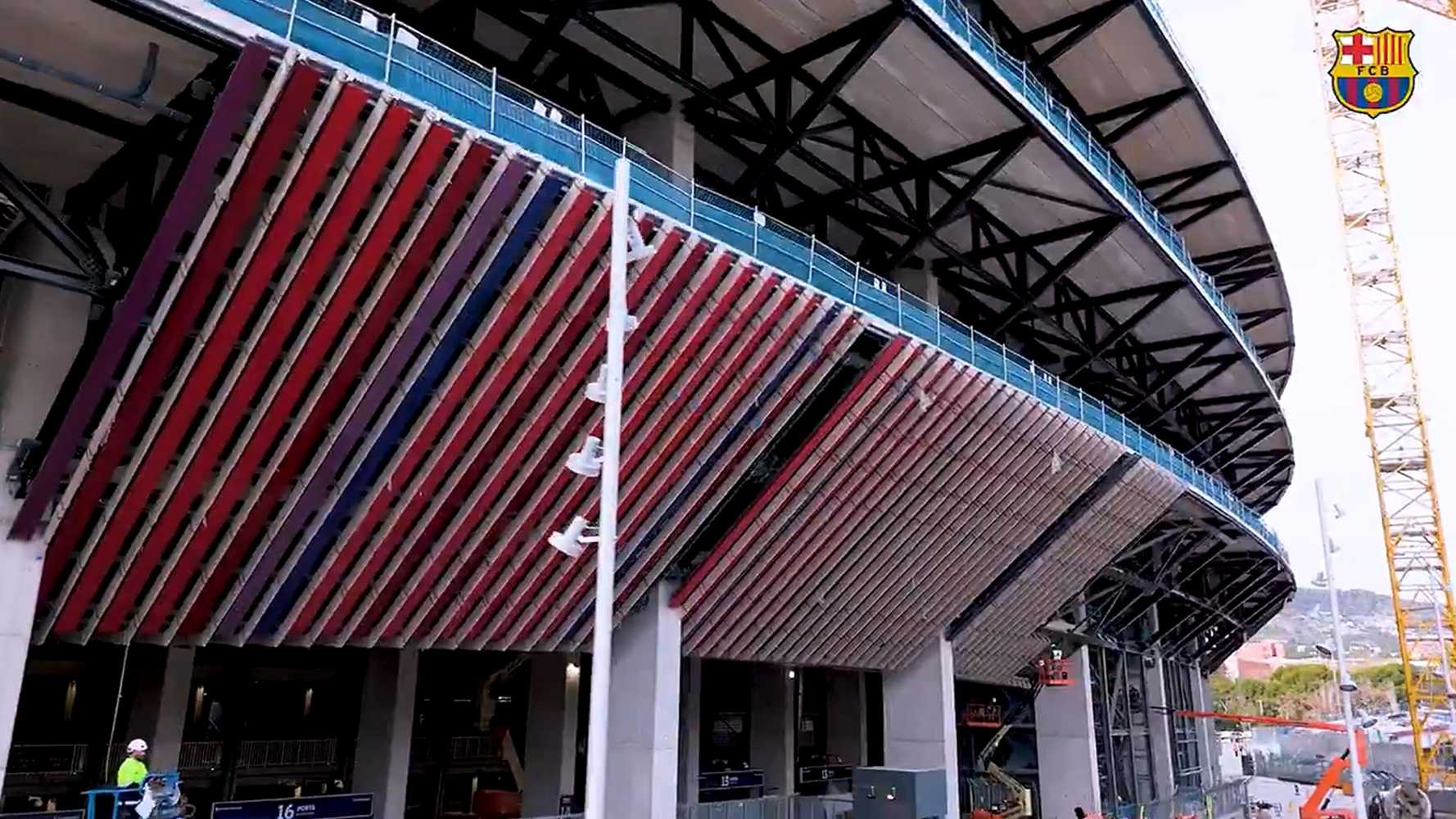

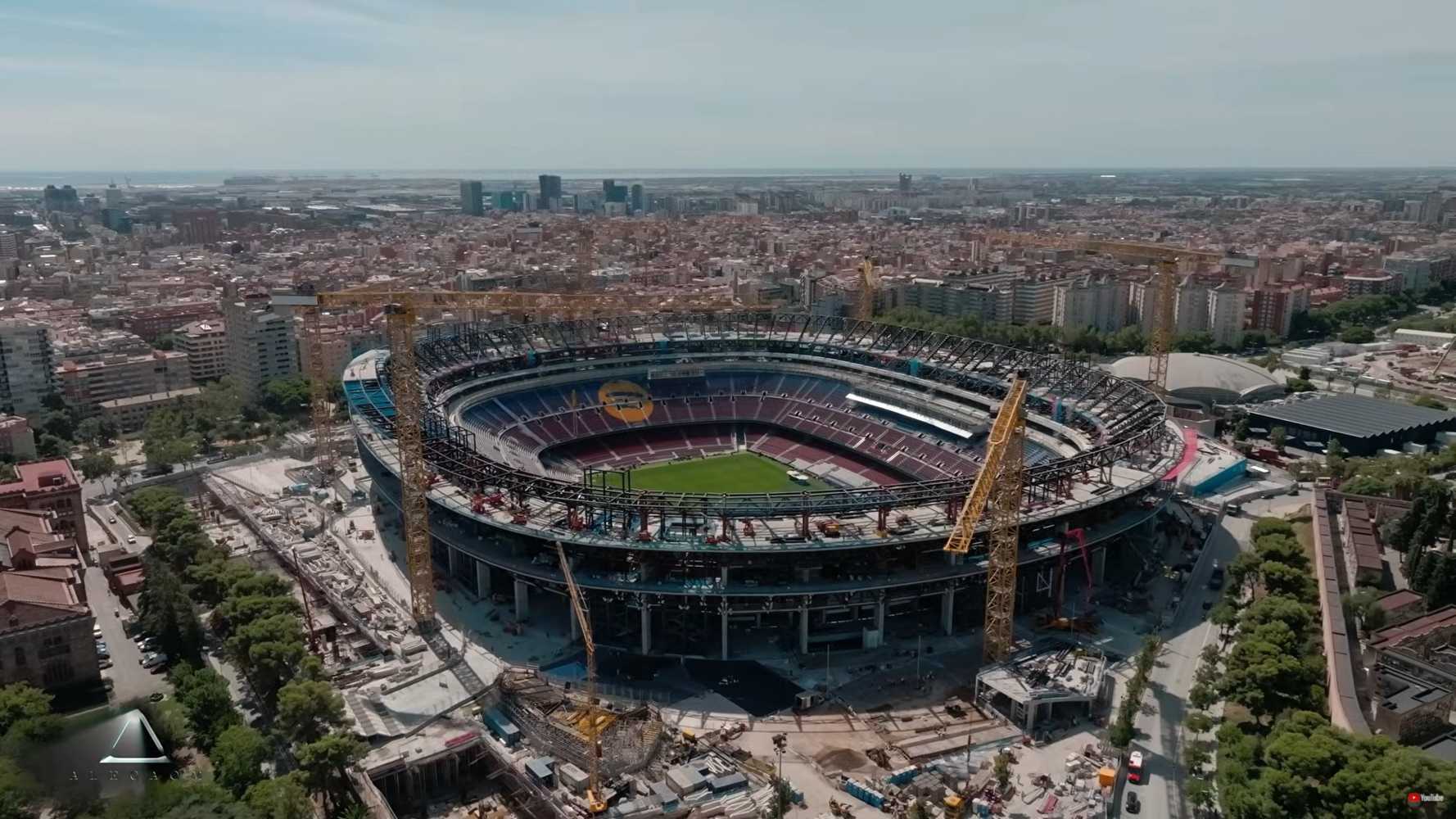

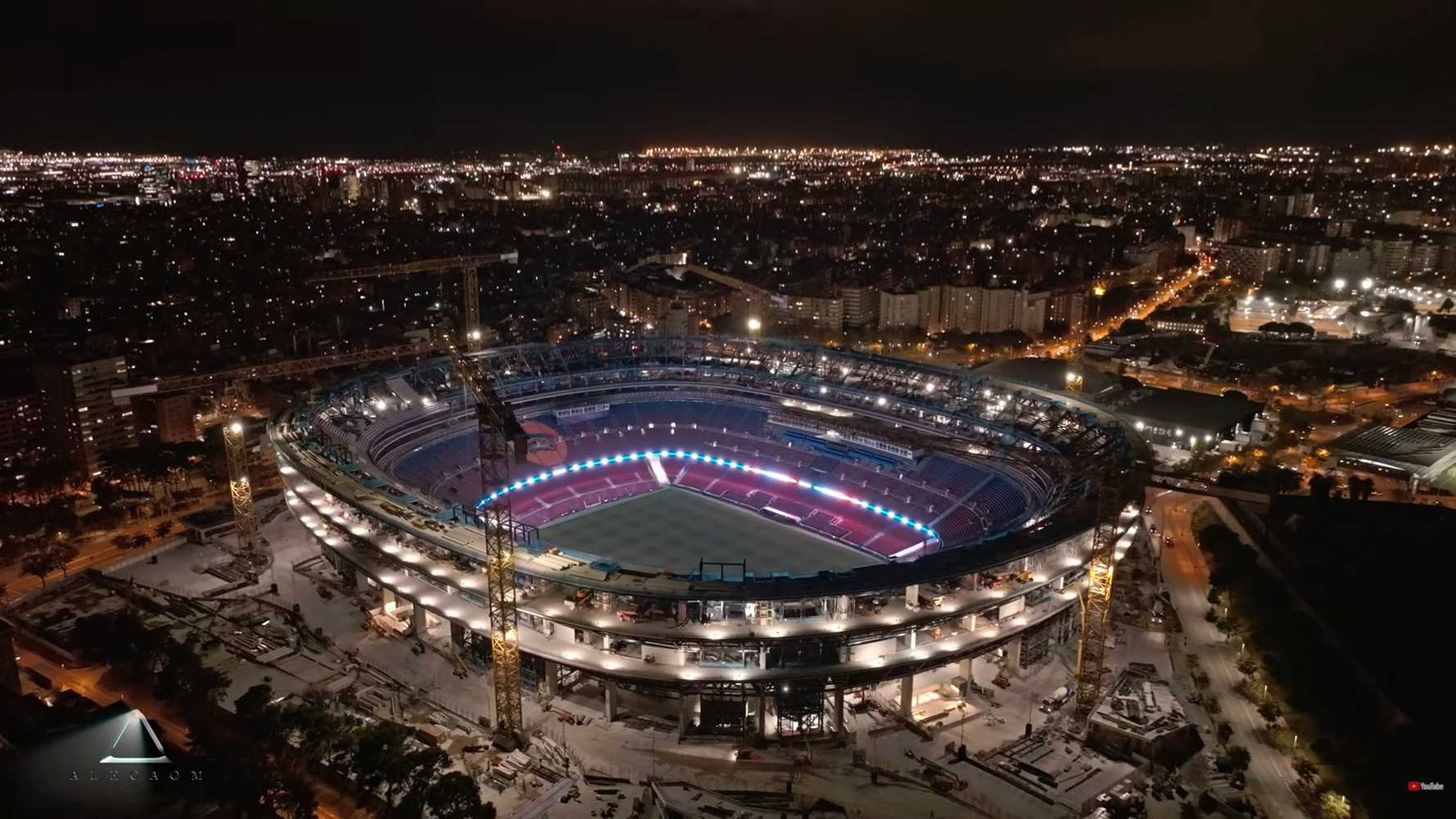

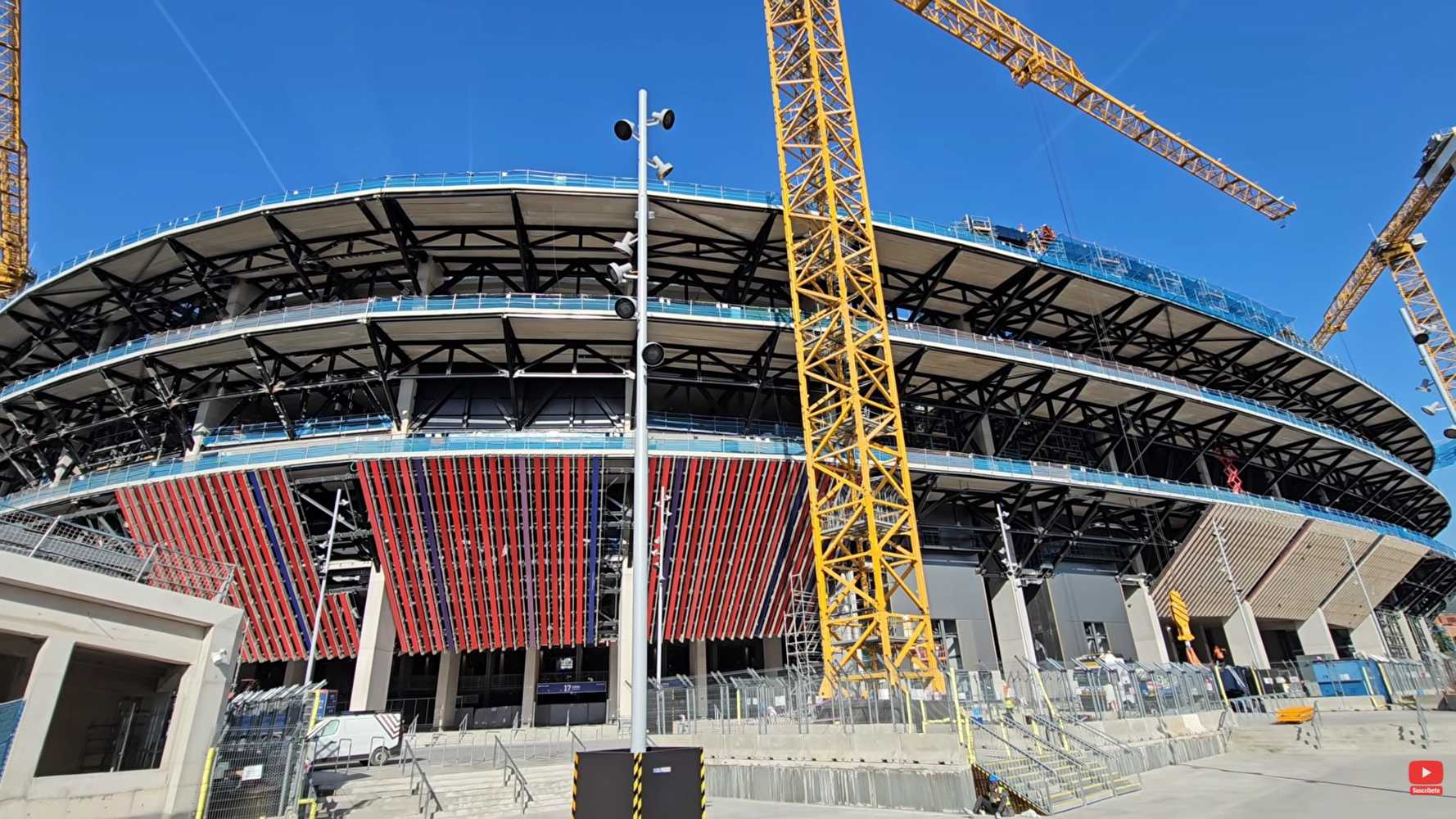

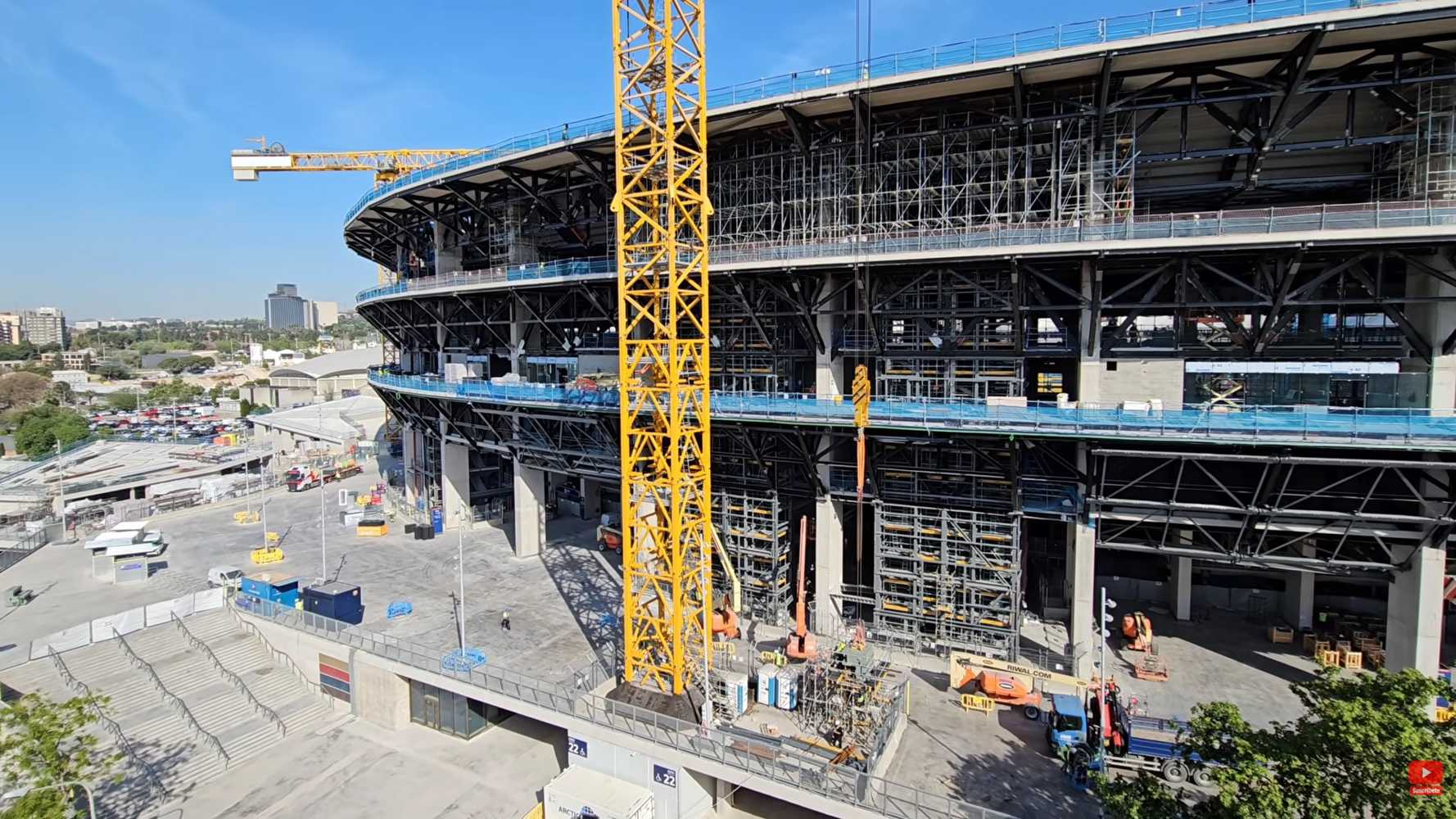

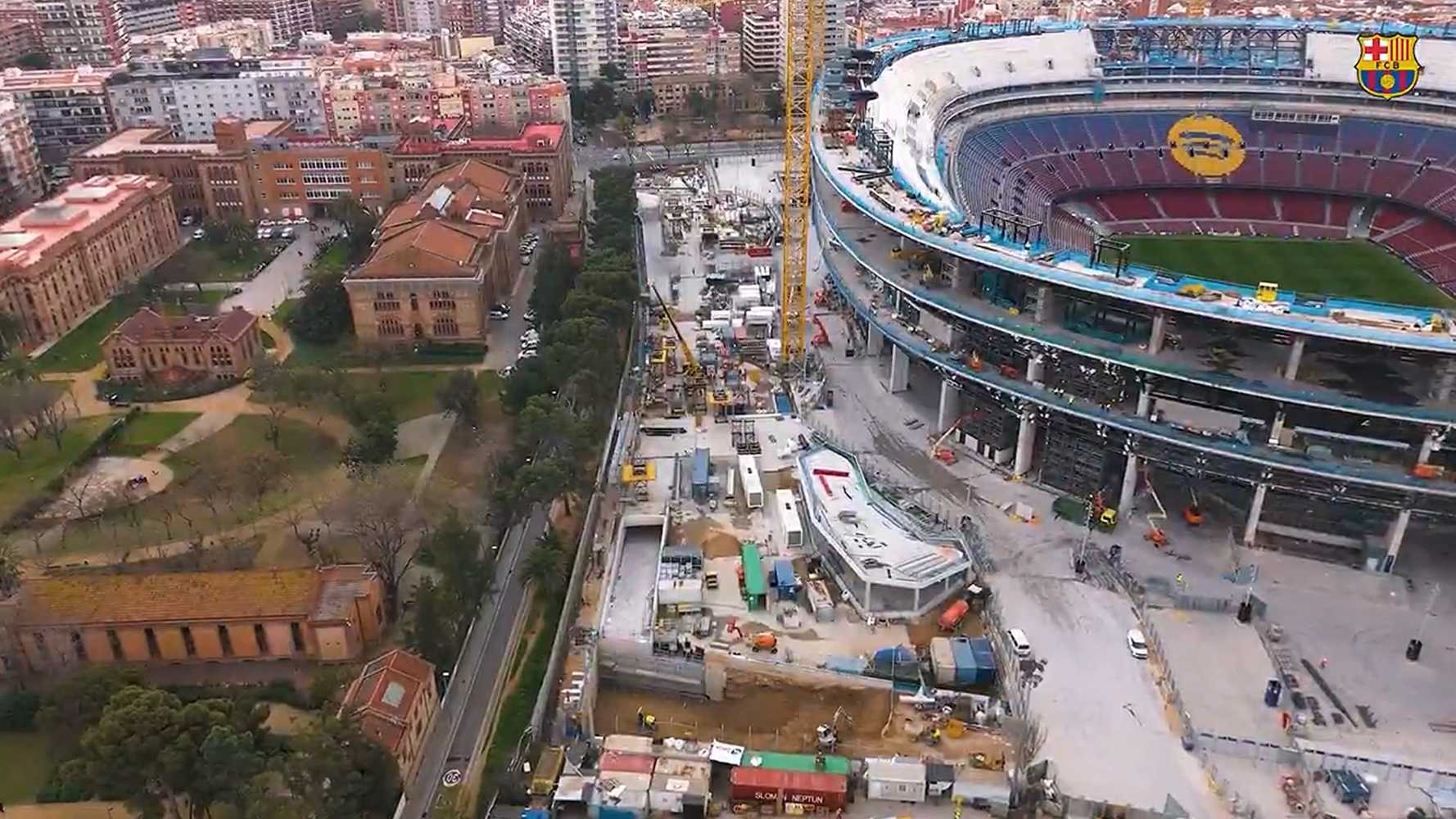

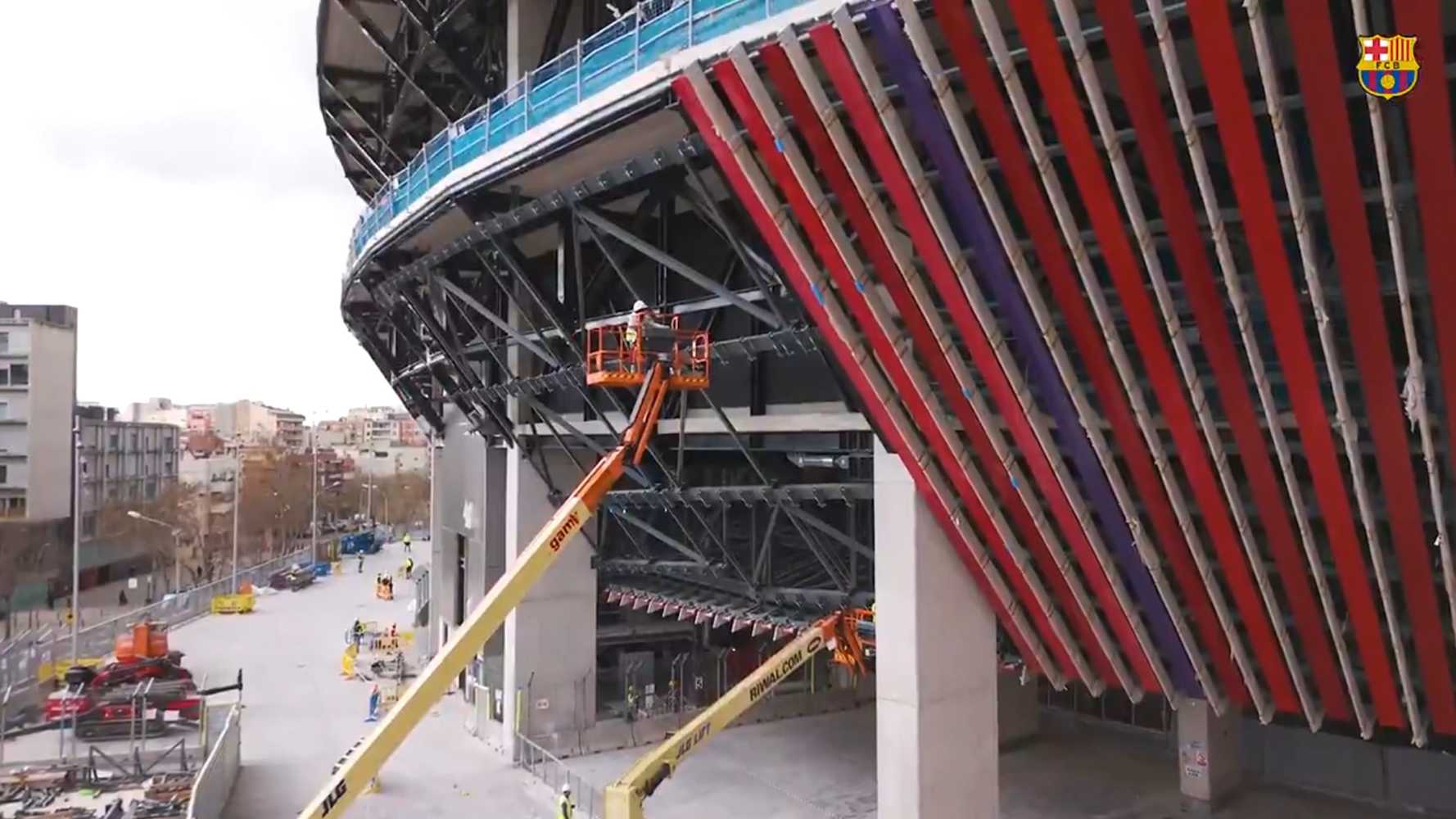

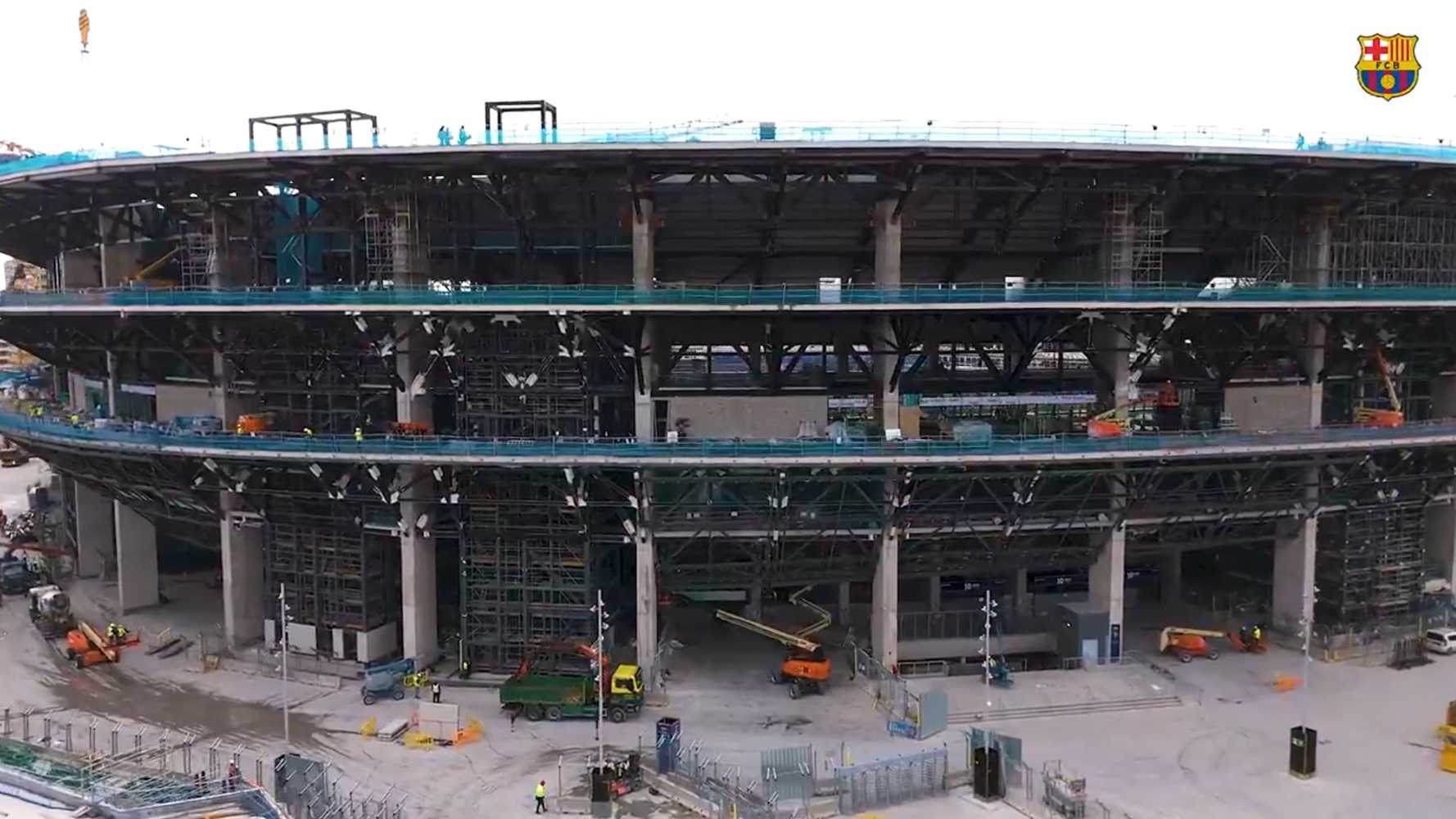

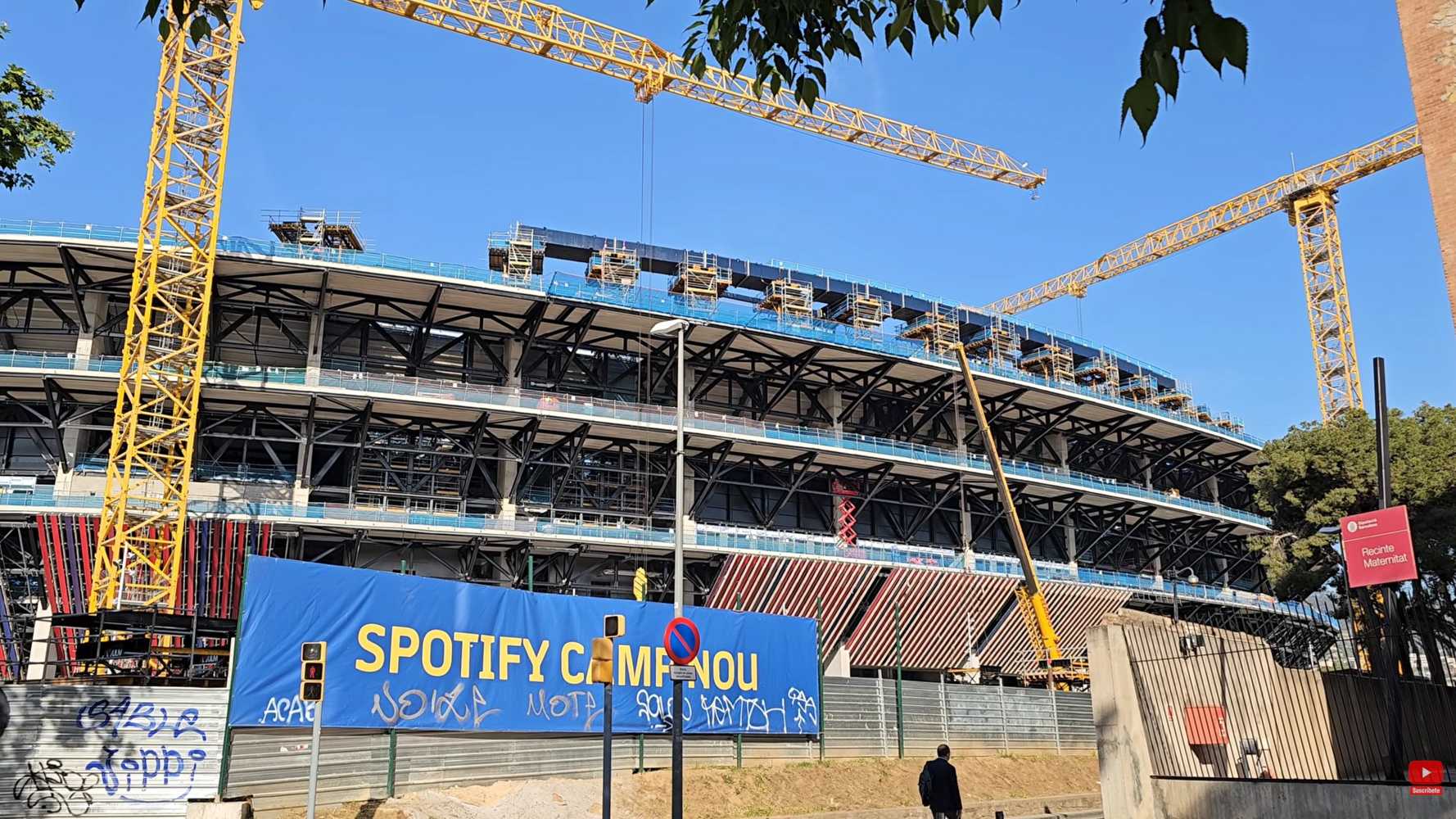

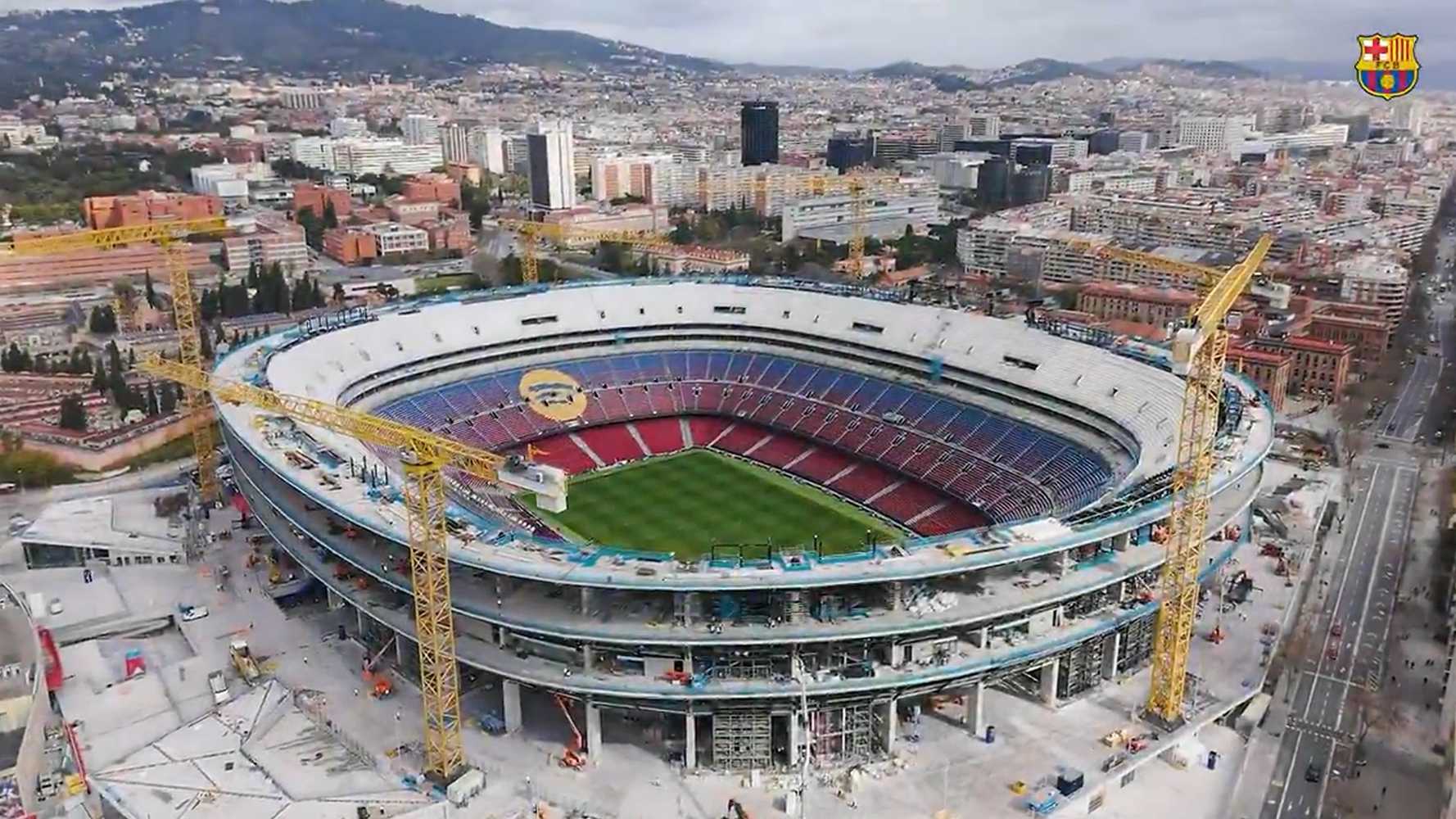

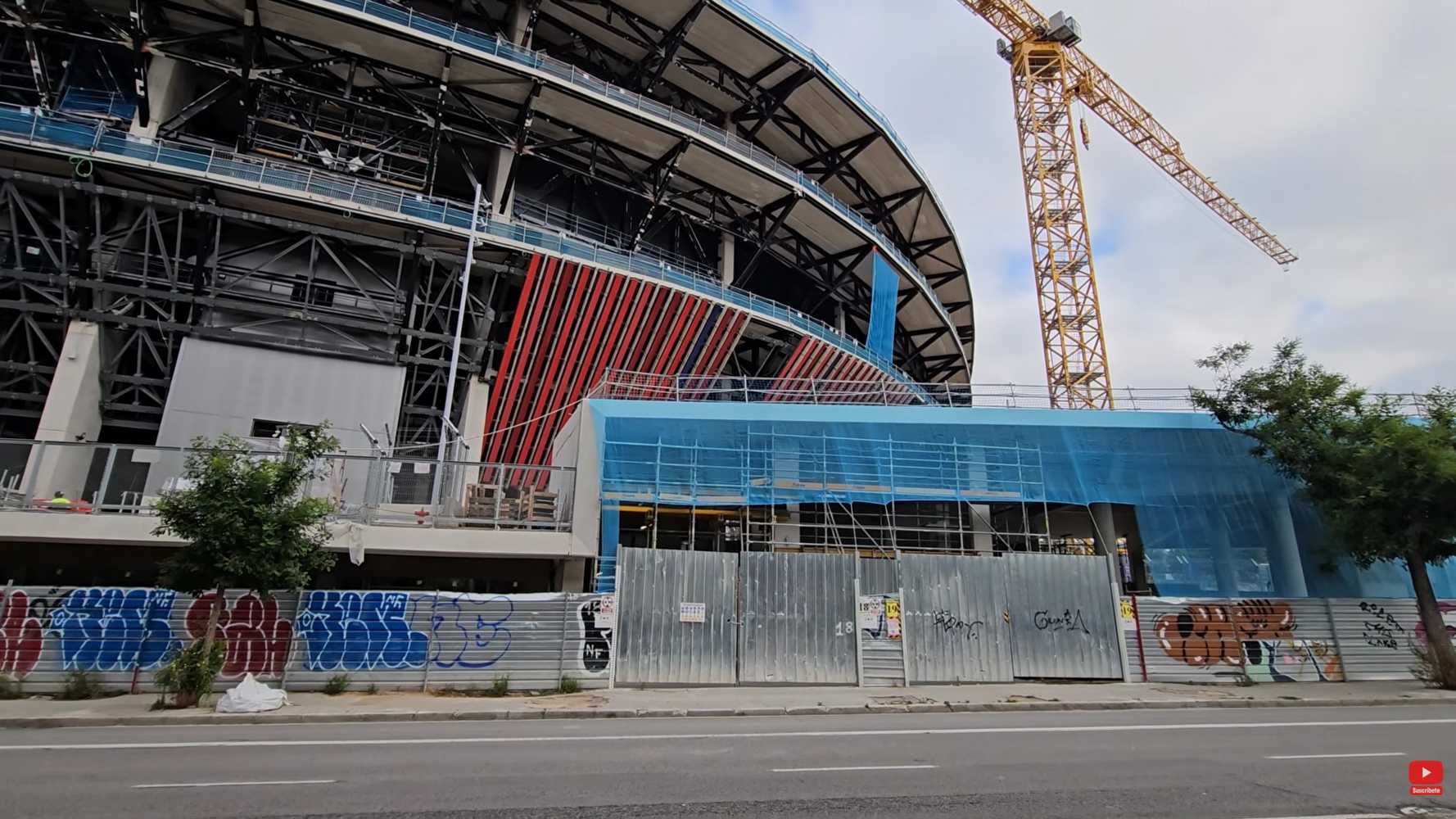

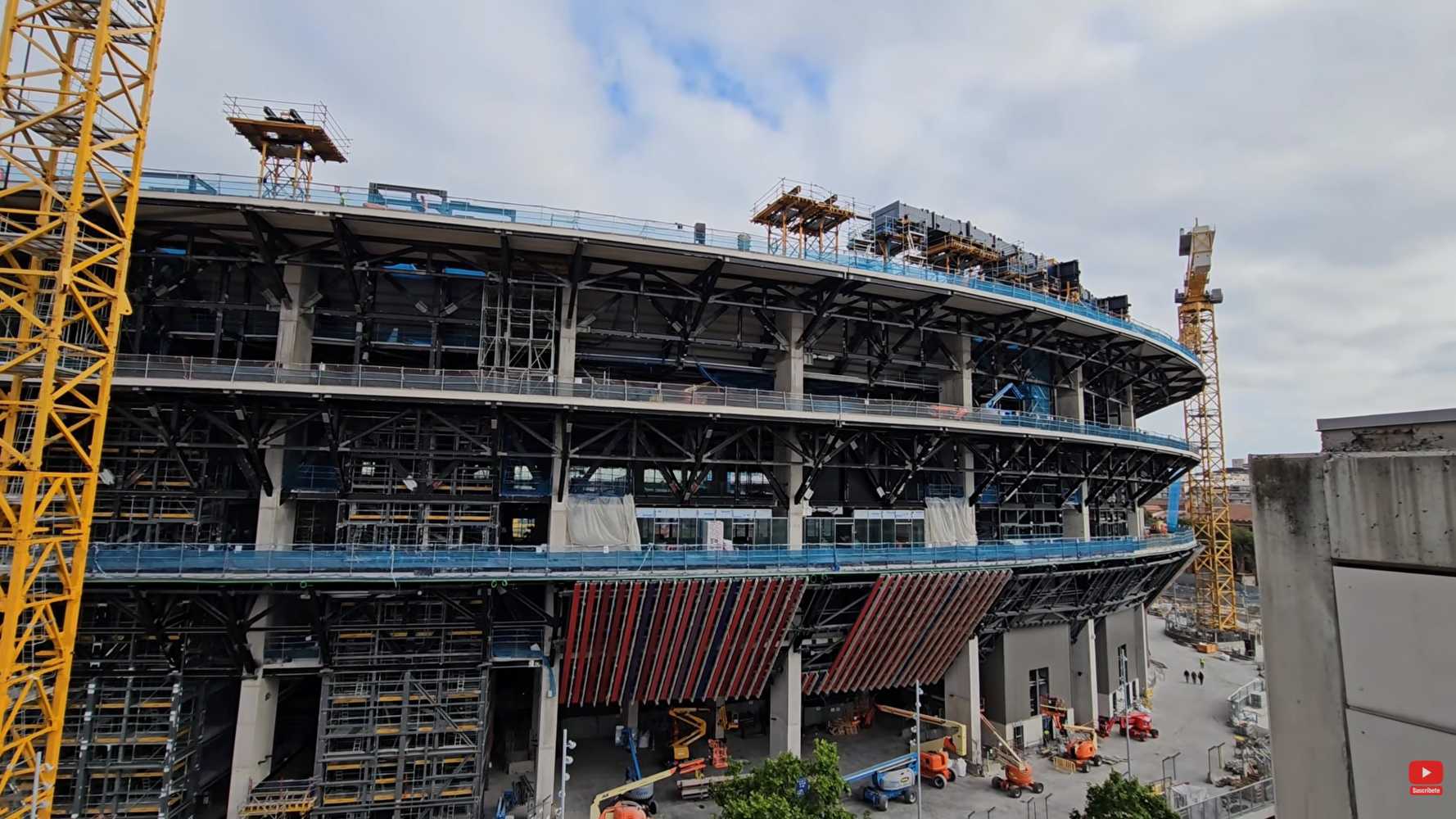

18.11.2024
28.10.2024
10.10.2024
23.09.2024
12.09.2024
26.08.2024
23.07.2024
07.07.2024
24.06.2024
21.06.2024
20.05.2024
08.05.2024
11.04.2024
28.03.2024
06.03.2024
10.02.2024
27.01.2024
19.01.2024
16.01.2024
05.01.2024
15.12.2023
26.11.2023
11.11.2023
05.11.2023
23.10.2023
02.10.2023
19.09.2023
21.08.2023
02.08.2023
21.07.2023
05.07.2023
21.06.2023
12.06.2023
09.06.2023
30.05.2023
31.12.2022
21.12.2022
20.12.2022
05.12.2022
03.12.2022
26.11.2022
25.11.2022
24.11.2022
15.11.2022
11.11.2022
10.10.2022
08.11.2022
23.10.2022
17.10.2022
09.10.2022
17.09.2022
12.09.2022
09.09.2022
07.09.2022
Related news
2024
-
FIFA: World Cup 2030 stadium evaluation. Camp Nou in the lead
Of the 23 stadiums to host the 2030 World Cup matches, as many as 14 either exist only on paper or will undergo deep redevelopment before the tournament. Nevertheless, FIFA has evaluated each of them before the Extraordinary Congress, which will already make its final decision on December 11. Also the one about the final arena.
-
FIFA: Madrid, Barcelona, Morocco - three locations for 2030 World Cup final
The race to host 2030 World Cup finals is on, and three cities remain in play: Madrid, Barcelona and Benslimane. Each offers unique strengths, making FIFA's choice potentially one of the toughest ever. What is in favour of each candidate?
-
Spain: Working Saturdays return to Camp Nou
The Barcelona City Council has given the green light after the agreement with the neighbors for the Camp Nou works to be extended to Saturdays. Of course, with limitations and conditions.
-
Spain: Barcelona back at Camp Nou in mid-February earliest
The countdown to Barcelona’s return to Spotify Camp Nou has officially begun. The club has set February as the target date, a plan confirmed by Barcelona City Council. On November 18, another meeting took place with representatives of the Les Corts neighborhood.
-
Spain: FC Barcelona surprised by socios' reaction to Camp Nou return
October 23 marked the deadline for FC Barcelona’s socios to apply for subscriptions to attend matches at Spotify Camp Nou. A total of 45,000 seats were offered for league and Copa del Rey games, and 40,000 for the Champions League.
-
Spain: Wave of stadium upgrades sweeps through the Iberian Peninsula
In recent years, work on Spanish stadiums has not stopped, and the 2030 World Cup has provided another important impetus for the renovation of facilities. With work on the Bernabéu, Camp Nou and Balaídos already underway, 9 La Liga venues are awaiting their turn. Rosaleda, Romareda, Riazor and La Cartuja join the group as 2030 World Cup hosts.
-
Spain: 24/7 work at Camp Nou – Laporta announces new deadlines
FC Barcelona continues to work towards returning to Spotify Camp Nou as soon as possible, updating the timelines regularly, and expressing confidence that the selection of construction company Limak will soon "astonish everyone."
-
Spain: Bernabéu and Camp Nou for sale in pieces
The stadiums of the two eternal rivals, Real Madrid and FC Barcelona, are undergoing extensive renovations. The works not only reopen the debate about who has the best stadium in Spain, but also open up a unique opportunity for fans to buy parts of the two emblematic grounds.
-
World Cup 2030: Bernabéu fails to meet final requirements?
The issue of the tournament's final venue resurfaced due to Barcelona City Council's sports councillor, David Escudé, who announced that "according to FIFA requirements, the Bernabéu could not host the final." Additionally, the federations are threatening to strip Spain of the entire tournament. What's going on?
-
Spain: Seats are appearing at Camp Nou

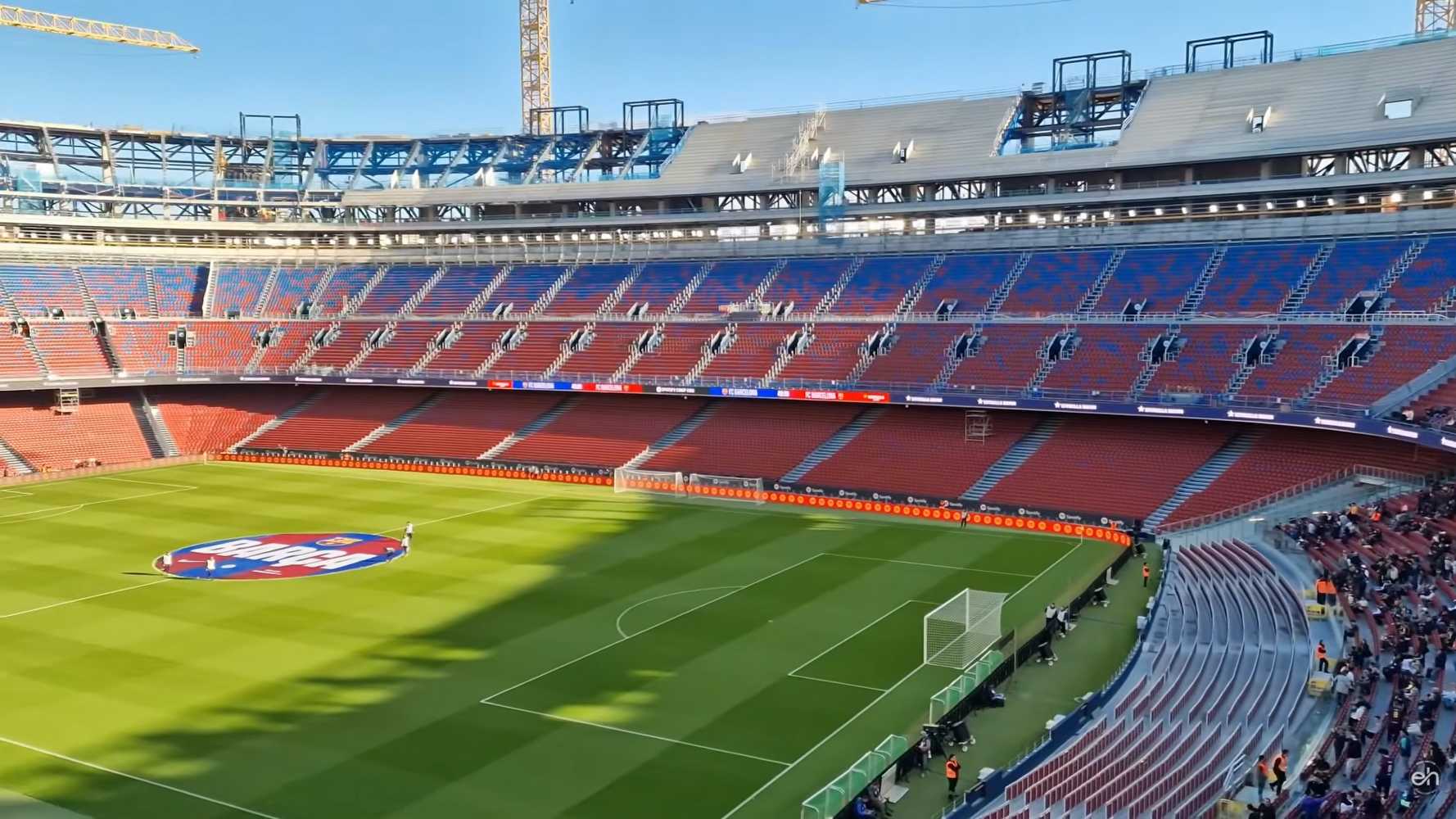

Although the final return to Spotify Camp Nou is expected to happen no earlier than 2025, work at the stadium is progressing well. The renovation of Catalonia's club home is now entering its decisive phase.
-
Spain: FC Barcelona will not return to Camp Nou until February 2?
Although Joan Laporta has stated in his last two speeches that "barring unforeseen circumstances, we will be able to play at Camp Nou by the end of the year", the situation is changing dynamically. However, we now know more about both the return date to the stadium and ticket prices.
-
Spain: Barcelona sets new date for return to Camp Nou
FC Barcelona's Board of Directors, which met on Monday afternoon, made an assessment of the club's economic situation, which continues to suffer from playing at Montjuïc. Although reluctant to indicate the exact matchday, the club gave a hint by setting the new date for the return to Camp Nou for "the second half of the season".
-
Spain: Barcelona may not return to Camp Nou until April
FC Barcelona has already received permission from the Barcelona City Council to carry out noise-free work at the stadium without time restrictions, but they must first find and train new workers to assist with the renovation.
-
Spain: Camp Nou inaugurated on this day 67 years ago
September 24, 1957, sunny Barcelona. For the first time in history the world saw Camp Nou filled with fans. These spectators were watching a game that included the FC Barcelona team and... a Warsaw XI.
-

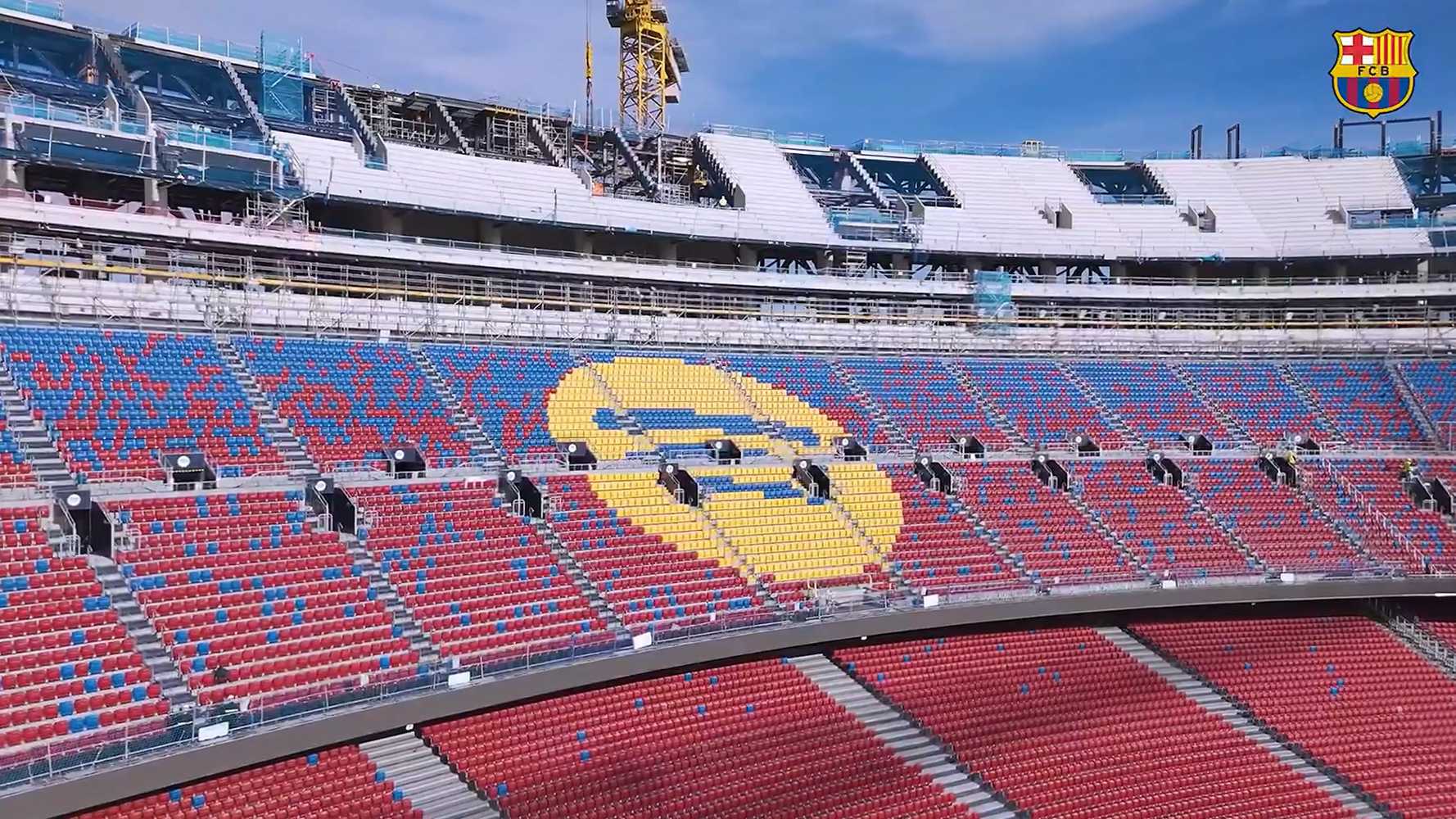

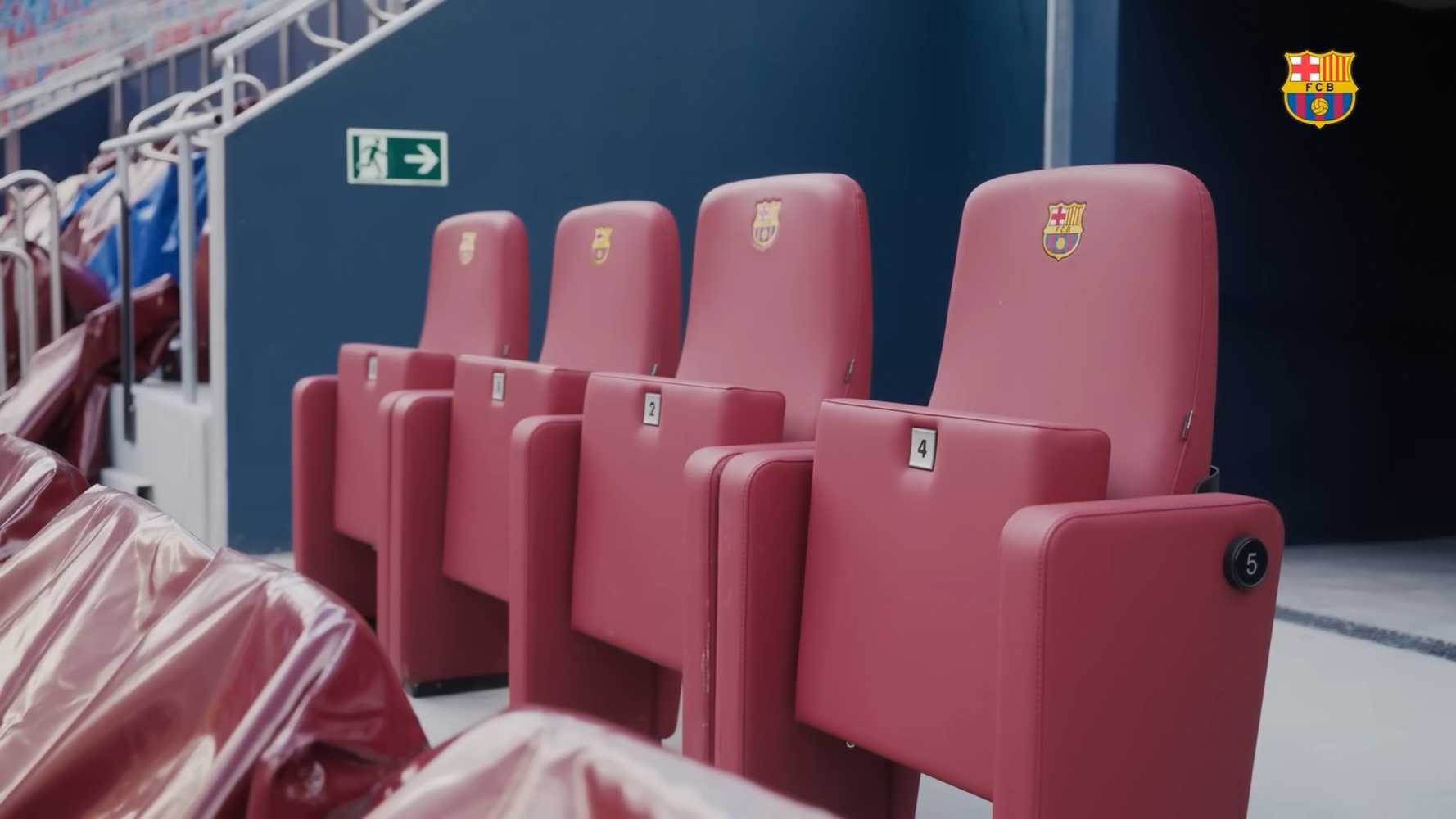

Spain: The first seats at Camp Nou are already in place
Work at the new Blaugrana stadium continues 24 hours a day, literally, so that Barça can return to Les Corts on schedule. Although the task is very difficult, one detail gives hope to FC Barcelona fans: the first seats of the second stand are already installed.
-
Spain: Construction work on Camp Nou to continue 24/7!
According to Betevé, FC Barcelona has reached an agreement with the city council and residents of Les Corts that will allow round-the-clock work on the renovation of Camp Nou. Of course, this comes with certain conditions and restrictions. The regulation will take effect on September 12.
-
Spain: FC Barcelona sure of quick return to Camp Nou

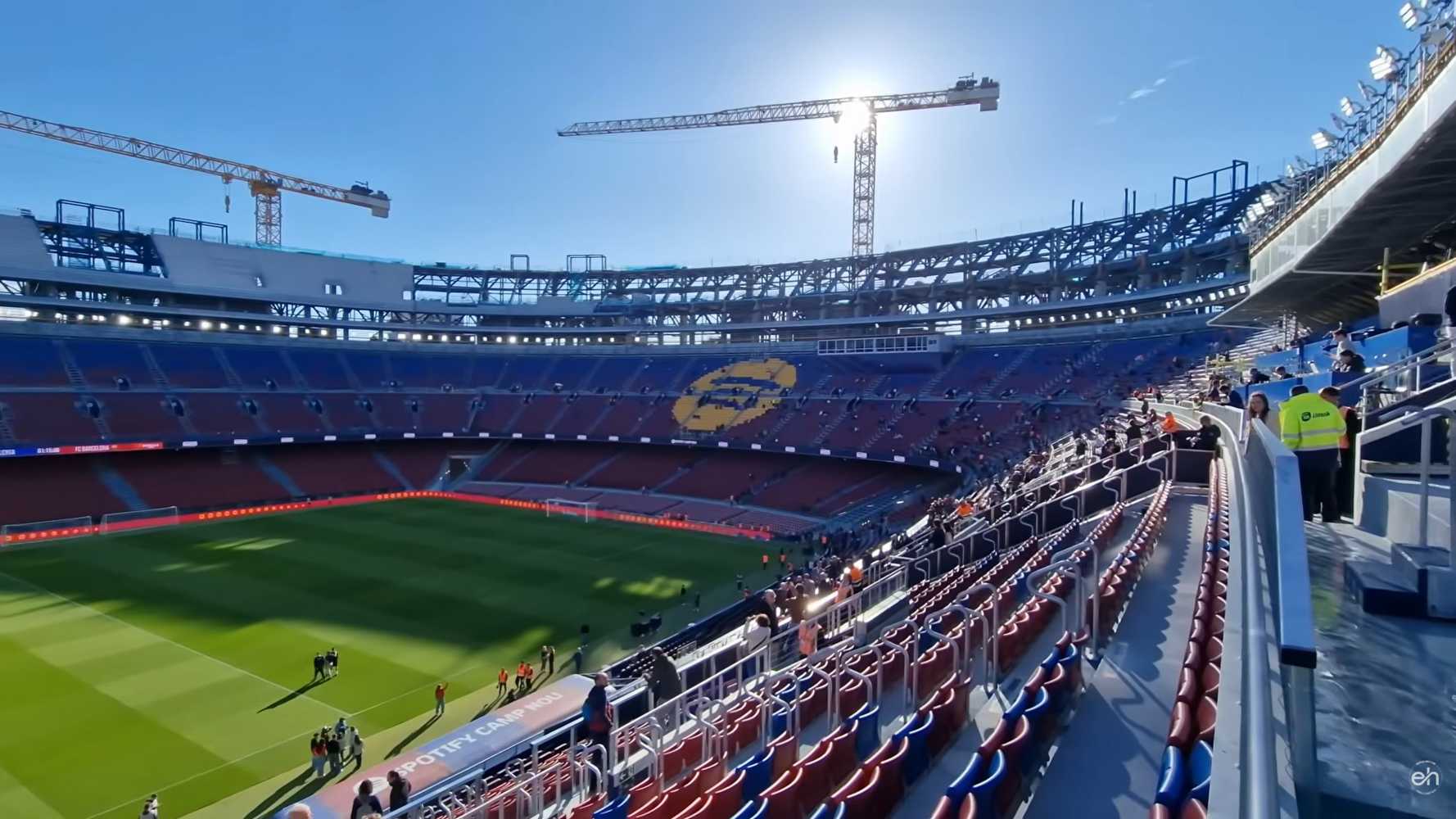

With just over three months left in the year, FC Barcelona is under enormous pressure to ensure that the new Camp Nou can partially welcome its fans by the last month of 2024.
-
